buildwiz.uk

Kitchen Extension Stages: From Planning to Completion

When I decided to project manage my own kitchen extension, I wanted a clear timeline: what happens, in what order, how long each stage takes, and what I should do. This guide is the version I wish I'd had.

Fair warning: my build took 35 months from first architect contact to Building Control sign-off. That is not normal. A well-managed kitchen extension should take 9-15 months, but the delays and mistakes on my project are exactly the traps this guide helps you avoid.

The Short Answer: How Long Does a Kitchen Extension Take?

Expect 9-15 months total from first architect contact to building control sign-off. That breaks down roughly as:

  • Planning and design: 3-4 months (before any building work starts)
  • Pre-construction and builder mobilisation: 4-8 weeks
  • Construction on site: 4-6 months (groundwork through specification, first fix, second fix, and completion)
  • Snagging and sign-off: 1-3 months

The planning phase is where most people underestimate the time. You can't just hire a builder and start digging. There's a sequence of decisions, applications, and lead times that must happen first.

My real timeline: 35 months (February 2021 to January 2024). Construction cost: £122,150 against an original builder quote of £45,500. I'll explain what happened and what you can learn from it.

Phase 1: Planning and Design (3-4 months)

This is the longest phase, and it all happens before a single brick is laid. Most of the time is spent waiting: for drawings, for approvals, for quotes.

Getting Architectural Drawings (2-4 weeks)

Your first step is getting architectural drawings. Even if your extension falls under permitted development (most single-storey rear extensions do), you need proper drawings for building control submission and for builders to quote from.

An architect or architectural technologist typically needs 2-4 weeks to produce drawings. Cost: £1,500-£2,500 depending on complexity.

On one documented build: the architect was first engaged in February 2021. Including structural calculations and multiple revisions (the steelwork design changed several times), the architect cost totalled £2,604.46 spread across 10 invoices over the project (fees plus disbursements including the planning application fee). That is at the upper end of the typical range; complexity and revisions are why.

Lesson learned: Get your architect to include a structural engineer's specification in their scope. You'll need structural calculations for any steelwork, and almost every kitchen extension needs at least one steel beam where you knock through the existing wall. If you arrange the structural engineer separately, it adds 2-3 weeks.

Planning Permission (10-14 weeks if needed)

If your extension falls within permitted development rights, you can skip formal planning permission. But check carefully: there are restrictions on height, distance from boundaries, and total coverage. If you want certainty, apply for a lawful development certificate (6-8 weeks, around £100).

A householder planning application takes about 10-14 weeks from submission to decision: the council has 8 weeks, counted from the day after it receives a complete application and fee, and if a document is missing the 8 weeks do not start until it arrives, and about a third of householder decisions in England run past 8 weeks under an extension of time agreed with the applicant. Don't wait for the decision to do everything else. Use this time to get quotes and sort out party wall agreements.

My experience: Planning was granted about 3 months after first contacting the architect. The planning application fee was £206 at the time (it has since risen to £548 in England).

Our full guides on whether you need planning permission and the permitted development rules cover how to check which route applies before you spend money on drawings.

Party Wall Agreements (2-8 weeks)

If your extension is within 3 metres of a neighbouring property's wall (or 6 metres for deeper foundations), you need to serve a party wall notice. Your neighbour has 14 days to respond. If they consent, you're done. If they dissent, you'll need a party wall surveyor, which can take 6-8 weeks and cost £700-£1,500 per neighbour.

Start this early. It is the single biggest cause of delays I've seen. A difficult neighbour can hold up your entire build. Our full guide on party wall agreements walks through serving notice, the schedule of condition, and how to keep surveyor costs down.

Finding a Builder and Getting Quotes (4-8 weeks)

Get at least three quotes. A good builder for a kitchen extension isn't easy to find, and the best ones are booked 2-3 months ahead. Start looking as soon as you have drawings.

My experience: I signed the contract with my builder in June 2021. His original quote was £45,500. The proposed start date was September 2021, but actual work didn't begin until late October, a 27-day delay due to his previous job over-running. This kind of slippage is common.

Kitchen Layout Decision (Before Construction)

This is the critical dependency most people miss. Your kitchen layout must be decided before first fix electrics and plumbing. Socket positions, lighting positions, water and waste pipe locations: all depend on where your units, appliances, and worktops will go. If you are not sure what each stage covers, first fix vs second fix breaks it down.

You don't need to have ordered the kitchen yet, but you need a finalised layout with exact measurements. See our guide on measuring and layout for how to get this right.

Utility Meter Relocation (10–14 weeks planning allowance)

If your gas or electricity meter is on the wall where the extension will be built (common with rear extensions), you need it moved. This involves your distribution network operator (DNO) for the supply cable and your energy supplier for the meter itself, so both have to be booked and you are the one sequencing them. Use 10–14 weeks from first contact as an initial planning allowance. Confirm provider dates: network work windows often start at payment, and complex moves can take longer.

My experience: The network charges came to £857 for the gas service alteration and £1,021 for the electricity one. The gas job was quoted at £809 and paid, then refunded when an emergency callout rerouted the pipe instead of the booked visit, and re-invoiced slightly higher. That is the cost of moving the pipe and the cable, not the meters: the energy supplier moved the electricity meter on a separate visit, the gas meter went to its new position with the gas network's reroute, and neither meter move was charged. Contact your DNO as early as possible. This is non-negotiable if the meter is in the way. Our full guide to meter relocation covers the exact steps and why it is the hidden delay that catches so many people out.

Explore the full Kitchen Extension Guide

Every task, in the right order, with tools and materials guidance.

View the Guide

Phase 2: Pre-Construction (4-8 weeks)

Once planning, party wall, and building control are sorted, there's a short burst of practical preparation.

  • Skip hire organised (you'll fill at least two during the build; one extra skip for kitchen and garden waste cost £240 on the documented build)
  • Builder's insurance confirmed (ask for a copy of their public liability policy)
  • Payment schedule agreed: 10-20% is the market standard deposit range. I paid 20% (£9,100), which sat at the upper end. Justifiable only because the builder needed to pre-order steelwork
  • Temporary kitchen set up in another room: microwave, kettle, mini fridge, camping stove

That temporary kitchen sounds manageable. By week 6, you'll be sick of it. Plan for more takeaways than you'd like to admit. We have a full guide on setting up a temporary kitchen.

Phase 3: Groundwork (2-3 weeks)

Construction starts. This is where it gets exciting. Expect noise.

Foundations (1 week)

Digging trenches for strip foundations. Depth depends on ground conditions, typically 900mm-1200mm, but tree roots or clay soil can push this deeper.

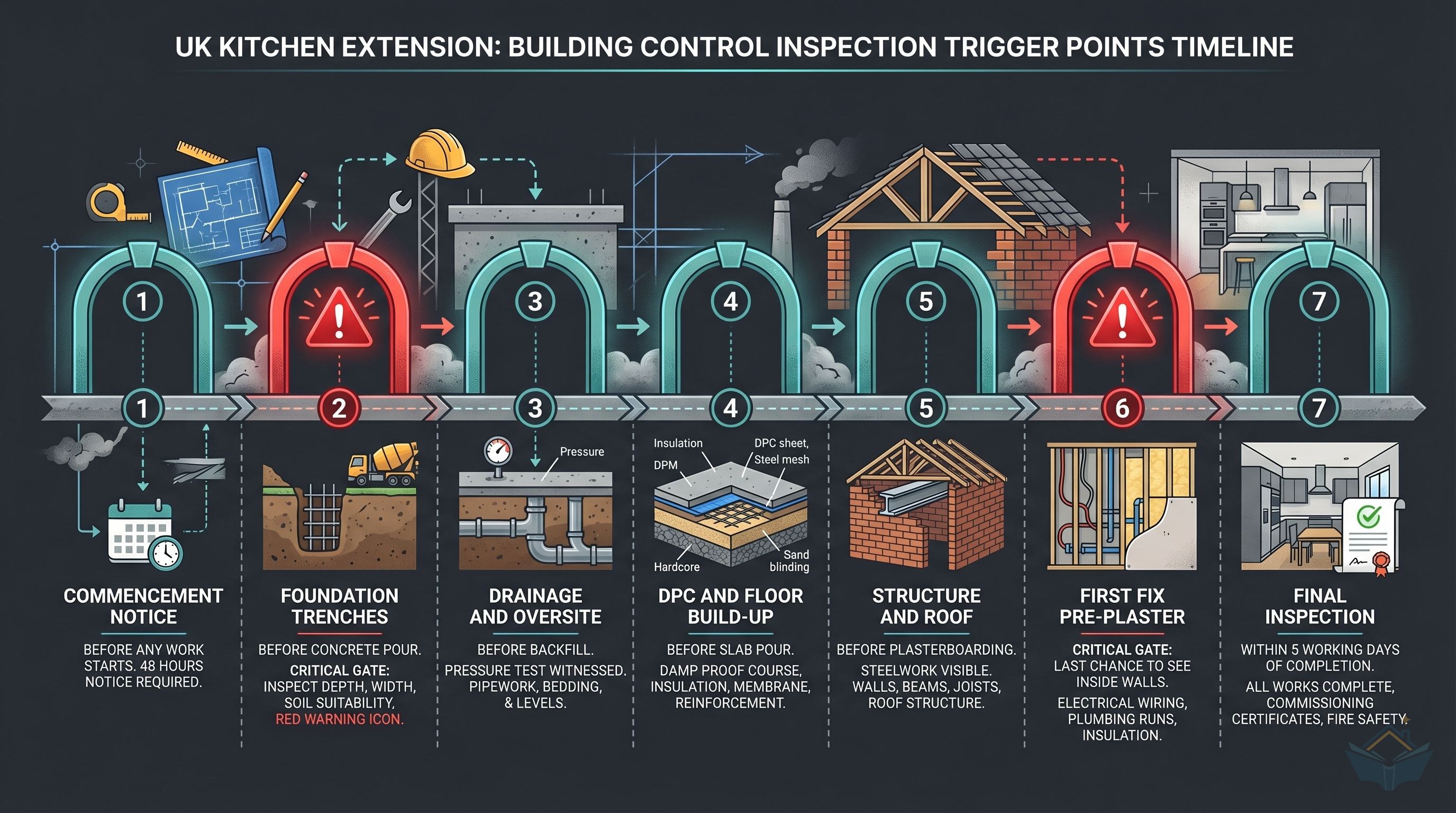

Building control inspection #1 happens here. They inspect the trenches before concrete is poured. Don't pour until they've signed it off.

My experience: Concrete was poured about two weeks after work started. The ground was wet and clay-heavy, requiring extra work to "bottom up" the trenches.

What went wrong: During the foundations prep, the builder went through the water mains pipe on two separate occasions in two different places. He also hit a gas pipe. That's three utility strikes during groundwork alone. If your utility plans are inaccurate (and they often are), make sure your builder proceeds carefully and knows where to call for emergency repairs.

Drainage and Oversite (1 week)

Underground drainage connects to the existing foul and storm water systems. Then the oversite concrete (floor slab base) is poured.

Building control inspection #2 covers the drainage and damp-proof membrane before the slab goes down. See our detailed guide on what building control inspects at this stage.

DPC and Floor Slab (1 week)

DPC, insulation below the slab, and the concrete floor are completed. At this point you have a flat base at floor level. It starts to feel real.

Phase 4: Structure (4-8 weeks, or much longer if things go wrong)

Walls and Blockwork (2-3 weeks)

Walls go up fast once the slab is in. Your bricklayer will lay blockwork to DPC level, then continue up to wall plate height. Cavity walls with insulation between the skins are standard.

Window and door openings are formed with lintels. Structural steels (RSJs) are lifted into place. This is the day you'll want to be on site.

What went wrong on my build: Storm Dudley in February 2022 cracked the top 4 rows of rear blockwork loose. They had to be completely redone. Check your builder has adequate site protection for partially-built walls.

The Steelwork Saga (a cautionary tale)

My steelwork phase should have taken 2 weeks. It took 11 months.

The initial steels were delivered in December 2021 (£3,360). But my builder then discovered they didn't fit (his own modifications to the design were wrong). Multiple redesigns followed, including a cantilever solution to remove a corner post for bifold doors. A steel fabricator installed an upstanding steel via chemical fixings and welding, but it shifted 3cm during installation.

Then the real problem: my builder and his team changed the roof ridge beam from steel to timber without telling me. When the building control officer saw photos, he arranged an immediate visit. The beam wasn't to spec.

The steels weren't finally installed and welded in place until November 2022, 11 months after they were first delivered.

Total steelwork fabrication cost on this build: £7,495 across six separate invoices. Lesson: Never let a builder make unauthorised material changes. If the structural engineer specified steel, it must be steel.

Roof and Weathertight (2-3 weeks)

Roof covering goes on, windows and doors are fitted. The extension is now weathertight. The opening between the existing house and extension is knocked through once the steel is in and building control have approved.

Building control inspection #3: they want to see the structure, steelwork, and that insulation meets thermal requirements.

Confirm the roof-glazing delivery date. Stock roof windows and bespoke roof glazing have different supply routes. For common made-to-order glazing, use 8–12 weeks as an initial allowance after survey and specification sign-off; get a separate supplier quote for large bespoke units. On my build, the HBD Systems roof glazing had a 14-week lead time and was ordered in mid-summer to arrive in September, close to the roofer starting. That is a historical project observation, not a stock roof-window delivery promise. Confirm the exact dimensions and delivery date before the roofer covers the openings.

Phase 5: First Fix (2-3 weeks)

First fix means all the services that get buried in walls and floors before plastering.

Electrical First Fix

Your electrician runs cables for sockets, switches, lighting circuits, cooker supply, and everything in the kitchen layout. This is why the kitchen layout had to be decided months ago.

Underfloor heating also goes in at first fix stage, before the screed.

My experience: The electrician quoted £3,290 for the core wiring, first and second fix together. The consumer unit had to go behind the bin. There's a maximum 3-metre rule from the meter. Extras on top (moving the consumer unit, outdoor lighting, certification) took the electrics to £6,624 across eight invoices.

Plumbing First Fix

Hot and cold water pipes to the sink position, dishwasher supply, and any other water points. Waste pipes connect to the drainage already in place.

Insulation

Walls get insulated with rigid PIR boards. The building inspector will want to see this before it gets covered by plasterboard.

My experience: The BCO required an upgrade from 100mm to 150mm insulation, an extra £773 I hadn't budgeted for. Check your U-value requirements early.

Phase 5.5: The Bifold Door Disaster

This deserves its own section because it's one of the most expensive mistakes you can make, and the most preventable.

In April 2022, I paid a deposit to a bifold door supplier, and by the end of May £10,340 had gone to them across three payments, part of it on a credit card. This turned out to be the smartest financial decision of the entire build.

By September 2022, I'd read negative Google reviews about the company. I investigated and confirmed they had cleared out of their premises. No doors or windows remained. They were insolvent.

I raised a Section 75 dispute with my credit card provider in October 2022. The full refund of £10,624 arrived in January 2023.

I then ordered replacement doors from another supplier (£16,743 total, of which £15,693 was the door and window order itself), more expensive but they actually delivered.

The lesson is simple: Always pay deposits on a credit card. Section 75 of the Consumer Credit Act means the card company is jointly liable for purchases priced over £100 and up to £30,000. If the supplier goes bust, you get your money back. I'd have lost £10,340 without this protection.

Get new blog posts by email

One email each time we publish a new post on project managing your build. No spam. Unsubscribe anytime.

Phase 6: Fit-out (4-8 weeks)

This is the kitchen package: locking the final specification, ordering the long-lead items, checking the deliveries, booking the fitter, and coordinating templating. The visible installation happens later, but the decisions that make it possible cannot wait until the room looks finished.

Final Kitchen Specification (before first fix starts)

By this point you need the layout frozen: unit widths, appliance models, extractor route, island services, and worktop decisions that affect sockets or plumbing. This is why the measuring and layout, appliance selection, and extractor and ventilation leaves sit in the specification phase, which runs alongside structure and closes before first fix begins.

Ordering, Delivery, and Fitter Coordination

This is where you turn a design into a real installation plan. Units need ordering with enough lead time. Appliance and worktop choices need confirming in writing. Deliveries need checking for damage and completeness. And your kitchen fitter, electrician, plumber, and stone templater all need to know when the room will actually be ready.

The extractor deserves special mention. Plan the ducting route at first fix stage: routing pipework after plastering is a far bigger job. I had a self-extracting Neff hob where the motor pulls air downward, so the 150mm ducting runs below the screed and exits through the side wall rather than going up through the roof void. The wrinkle: Neff use keyed, non-standard fittings, so standard plastic ducting won't connect. I had to buy Neff-specific ducting at roughly ten times the price of regular plastic venting. See our guide on extractor and ventilation for the full picture.

Phase 7: Second Fix (4 weeks or more)

This is where the shell becomes a finished room. Wet trades need to dry, services get completed, and the kitchen package you locked down during the specification phase finally lands on site.

Plastering (1 week)

Once first fix is inspected, the plasterer goes in. Plasterboard on walls and ceiling, skim coat on top. Allow 2-3 weeks for plaster to dry before decoration. Liquid screed dries at roughly 1mm per day for the first 40mm and about half that beyond, so a 65mm liquid screed needs about 13 weeks in ideal conditions; force drying over UFH can shorten this. In winter, allow about half as long again for the screed (the screed drying calculator adds 50%) and at least two more weeks for the plaster. Pour the screed as early as the programme allows (straight after first fix) so the drying overlaps plastering and second fix. Even then a screed this deep will not be dry within this phase's 4-8 weeks unless it is force dried over the underfloor heating, so agree the force-drying cycle with your UFH installer or programme the floor finish last.

Second Fix Electrics and Plumbing (1 week)

Sockets, switches, and light fittings are installed. The consumer unit is updated. Taps, waste traps, and connections are completed.

Kitchen Installation (1-2 weeks)

Units, worktops, splashbacks, and appliances go in. A good kitchen fitter needs 5-8 days. Stone worktop templating adds a week. The templater comes after units are in, then the worktop is cut and fitted a week later. Our kitchen installation guide covers this in detail. In other words, the specification work happens in phase 5 alongside structure, and the physical kitchen installation culminates during second fix.

Flooring, Tiling, and Decoration (2 weeks)

Floor tiles or LVT go down, wall tiles behind the hob and sink. Then painting: two coats minimum on new plaster after a mist coat.

On one documented build: Tiling alone came to £7,033 (227 Bravestone Grey 60×60 tiles covering 81m² at £3,933 for the tiles, plus £3,100 labour for Ditra UFH matting and laying). Decoration was £2,188.

Phase 8: Completion (4-12 weeks, or longer)

Snagging

Walk through with a critical eye. Check every socket works, every door closes properly, every tile is level. Make a snagging list and get your builder to fix everything before the final payment.

Building Control Final Inspection

Building control visit for final sign-off. They check the build against approved plans, verify electrics (Part P certificate from your electrician), and check fire safety.

If everything passes, you get a completion certificate. Keep this document forever. You'll need it when you sell. Without it, your buyer's solicitor will raise queries and their mortgage lender might refuse to lend.

My experience (and the 12-month nightmare): My extension was practically finished in January 2023. But building control wouldn't sign off without a gas certificate and final electrical certification. My plumber failed to provide the Gas Safe certificate for over a year. The Gas Safe Register eventually had to begin enforcement proceedings against him. I finally received the certificate on January 9, 2024, and building control signed off the next day, about 12 months after the kitchen was in use.

Lesson: Get certificates from your trades as soon as their work is complete. Chase immediately. Your completion certificate depends on it.

Update Home Insurance

Notify your insurer about the extension. Your rebuild value has increased and your policy needs updating.

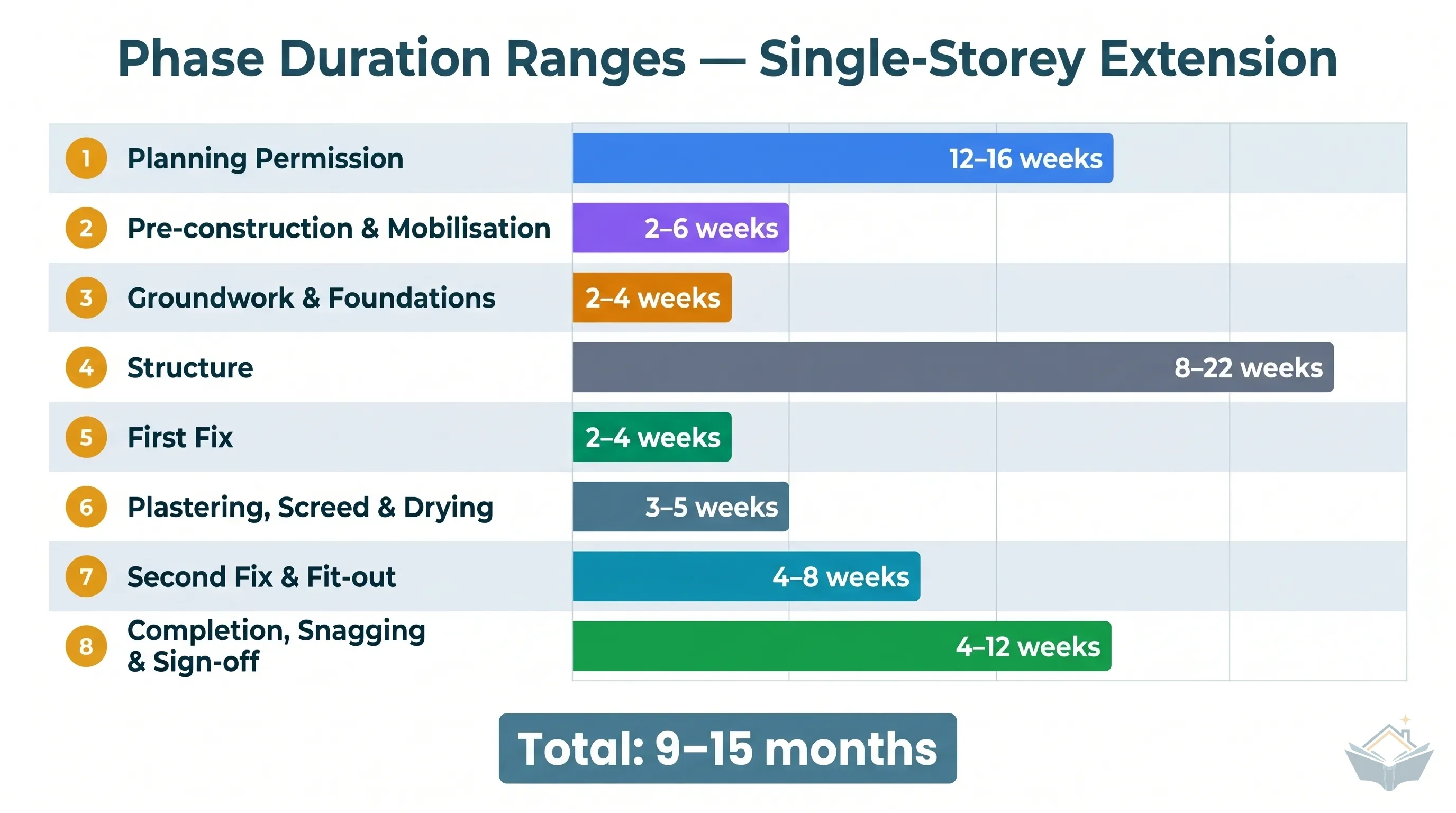

The Complete Kitchen Extension Timeline at a Glance

PhaseTypical DurationMy Build
Planning and design3-4 months7 months (Feb-Aug 2021)
Pre-construction4-8 weeks4 weeks
Groundwork2-4 weeks6 weeks (Oct-Dec 2021)
Structure4-8 weeks12 months (steelwork delays)
First fix2-4 weeks5 months (concurrent with structure)
Fit-out4-8 weeksoverlapped other phases and dragged for months
Second fix4 weeks or more5 months
Completion and sign-off4-12 weeks12 months (gas cert delay)
Total9-15 months35 months

The estimator below gives the no-delay case for each phase. Its planning stage counts from submitting the application, so add your design weeks before it, and it allows two weeks for completion rather than the months sign-off can take, so its total lands at the bottom of the range in this table or just below it.

Interactive calculator

Extension Stages Estimator

Enter your extension details to get a personalised phase-by-phase timeline estimate.

What I'd Do Differently

Five things I'd change if I did this again:

  1. Pay everything on credit card. Section 75 saved me £10,624 when my bifold door supplier went bust. Without it, I'd have lost the lot.

  2. Get the meter moved first. I started the meter relocation process too late. Contact your DNO before you even have planning sorted.

  3. Never let a builder change materials without your written approval. My builder swapped a steel ridge beam for timber without telling me. The BCO caught it from site photos, and putting it right took eight days.

  4. Get certificates immediately. Don't wait until completion to chase your electrician and plumber for Part P and Gas Safe certificates. Get them the day the work is done.

  5. Budget 20% contingency, not 10%. My build came in at £122,150 against an original quote of £45,500. Ground conditions, steelwork redesigns, a supplier going bust, and scope changes all add up. The contingency advice of "10% should cover it" is dangerously optimistic. See our full guide on budgeting and contingency.

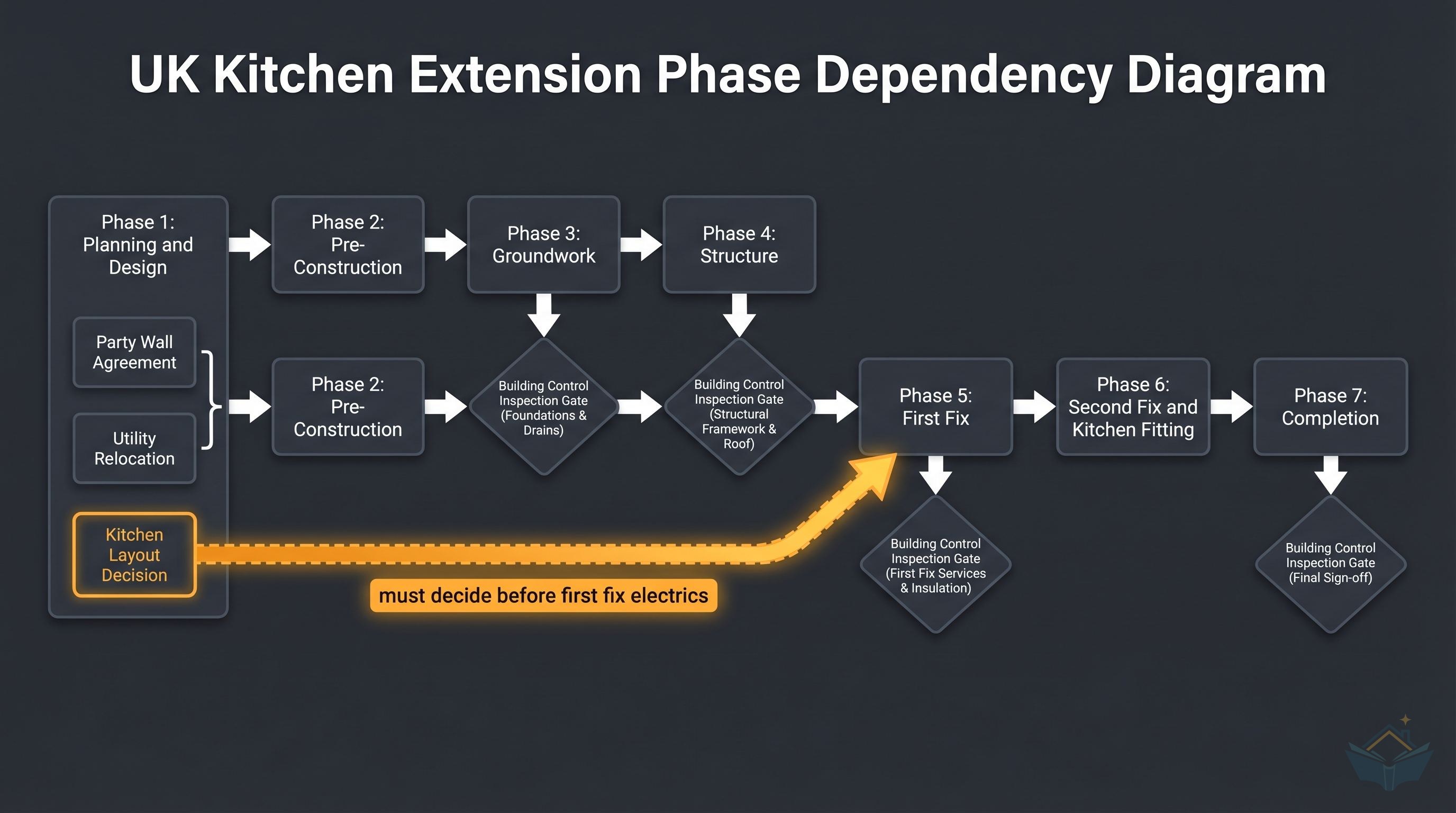

What Order Do You Build an Extension?

The sequence I now use is: planning, pre-construction, groundwork, structure, specification, first fix, second fix, then completion. Each phase depends on the one before it. Specification is the one that catches most homeowners out: it runs alongside structure rather than after first fix, because the kitchen layout, supplier orders, and appliance specs have to be locked before sockets and pipes go in.

The timeline above is based on one real build, but every kitchen extension follows the same fundamental sequence. Understanding the stages, the building control checkpoints, and the dependencies between them is what turns a stressful build into a manageable project.
