How to Project Manage Your Own Extension (and Whether You Should)

Nine days into my kitchen extension, I watched my builder pour concrete over foundation trenches he had already put through the water main. Twice. Both times the water meter, hidden at the front of the house, had to be found and shut off before the leak could be stopped. Nobody told me. I went out to look.

That was the moment I understood what project managing your own extension actually means. It means being the person who catches things. And it means being the person who deals with them when nobody else will.

The Direct Answer

Yes, you can project manage your own extension. The harder question is whether you should.

That comes down to time, trade knowledge, reliable contacts, and your tolerance for risk when mistakes cost real money.

I project managed a kitchen extension that ran for 35 months, involved 15+ trade and supplier contracts, and exposed me to supplier failure and unauthorised spec changes.

If you're considering it, start with our guides to budgeting and contingency, construction programme, and what building control inspects at each stage. Those cover the gaps that cost me most.

15-20%

The realistic saving from project managing your own extension versus using a main contractor, according to industry consensus. The 30% figure you'll see quoted online is achievable only with trade experience and strong local contacts.

What Does a Project Manager Actually Do?

Before you decide whether to do this yourself, understand what "this" is. A PM on a residential extension:

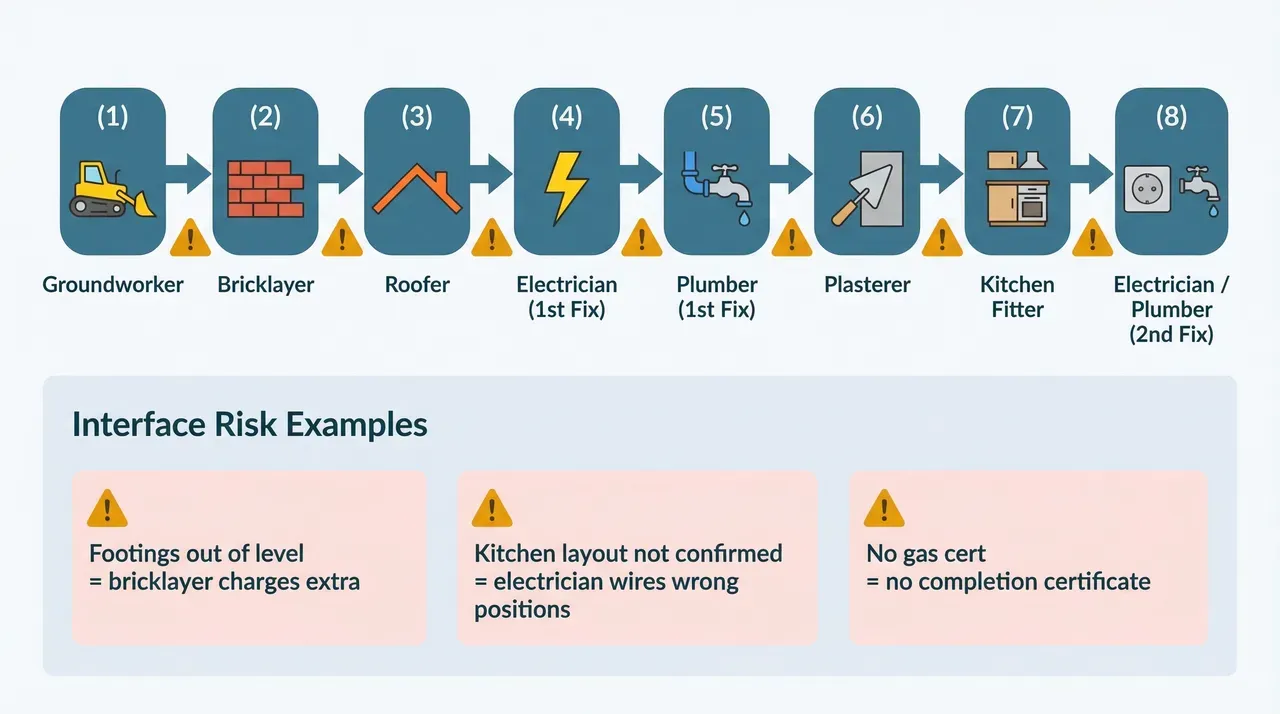

  • Sequences the trades. Groundworker finishes, bricklayer starts. Bricklayer gets to wall plate, roofer comes in. First fix electrician needs the kitchen layout confirmed before wiring a single socket. Get the sequence wrong and you pay tradespeople to sit in their vans waiting.

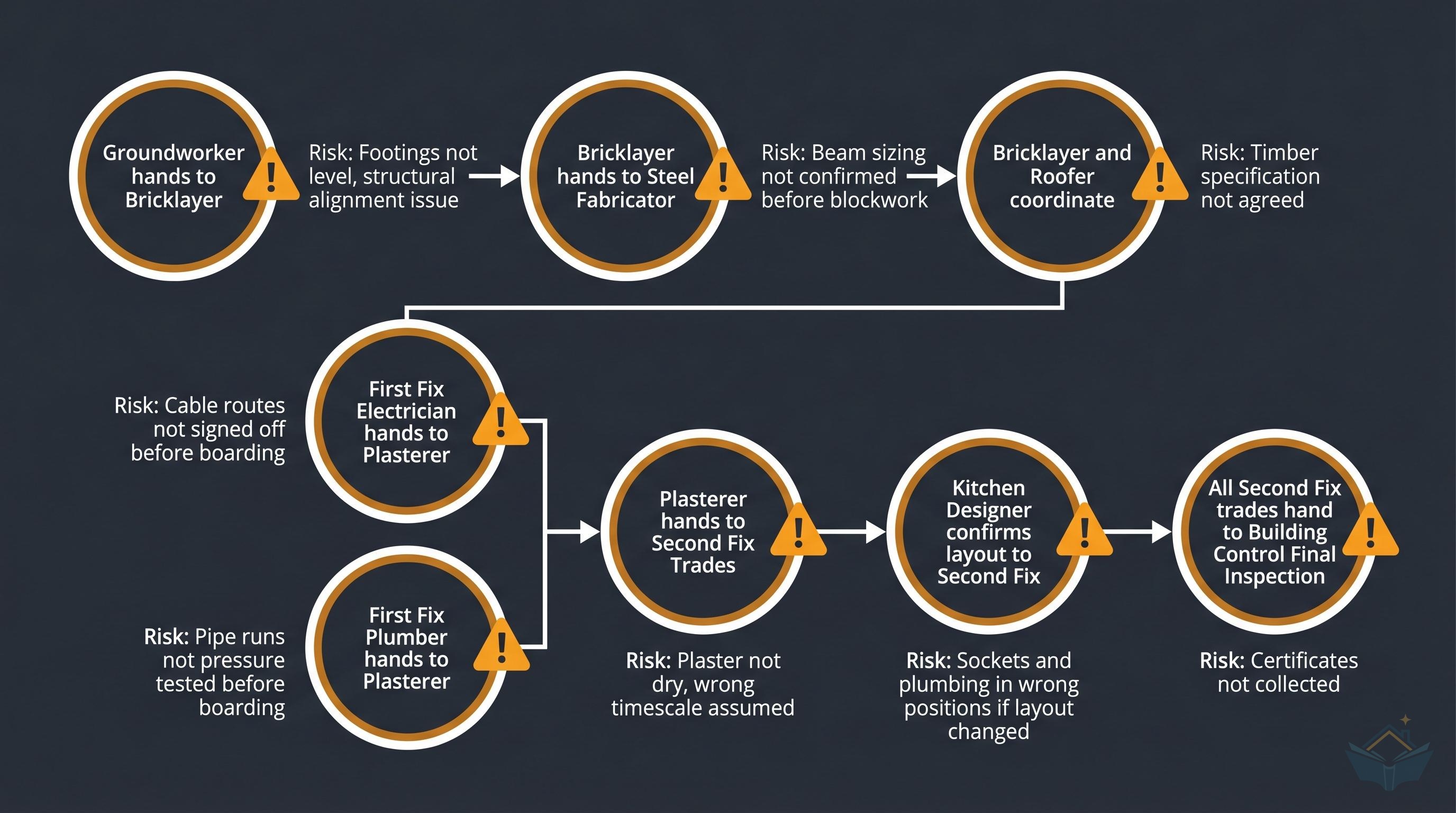

  • Manages the interfaces. This is the part nobody warns you about. If the groundworker leaves footings slightly out of level, the bricklayer charges extra for cutting bricks. If the plumber and electrician haven't agreed their routes through the same ceiling void before first fix starts, their pipes and cables end up competing for the same space. One of them has to move their work. The gaps between trade packages become your problem.

  • Handles variations. The average homeowner-managed build experiences 15-20 variation orders. Each one needs a decision: accept the cost, negotiate, find an alternative, or push back. Some are genuine (ground conditions worse than expected). Some are the builder padding the job.

  • Chases certificates and sign-offs. Building control need to inspect at multiple stages. Your electrician needs to provide a Part P certificate. Your gas engineer needs a Gas Safe certificate. Without these, you won't get your completion certificate. On my build, the plumber failed to provide his Gas Safe certificate for 14 months after the work was done. The Gas Safe Register had to start enforcement proceedings.

Is It Actually Cheaper?

This is the question everyone starts with. The honest answer: probably, but less than you think.

Industry sources consistently cite 15-20% as the realistic saving from project managing it yourself versus hiring a main contractor or professional PM. NSBRC puts it at up to 15%. Self-Build.co.uk claims up to 20%. A groundworks contractor on MyBuilder claims 30% is possible on small builds.

The catch is that these figures assume everything goes smoothly. They don't account for interface gaps, delays caused by poor sequencing, or the variations you'll accept under pressure because you don't know enough to push back.

A professional PM costs 15-25% of the construction budget on a residential extension. On a £100,000 build, that's £15,000-£25,000. On a £50,000 build, the percentage skews higher because the PM's fixed overheads don't scale down.

ApproachTypical Cost ImpactYour TimeRisk Level
Main contractor (all-in)Baseline priceMinimal: weekly check-insLow: contractor absorbs trade coordination
Professional PM + direct tradesNet cost similar to main contractor: direct trade savings roughly offset by the PM feeLow: PM handles day-to-dayMedium: you still approve variations
Project manage it yourself, direct trades15-20% saving vs main contractor1-2 hours/day on average, more during intensive phasesHigh: every interface is yours to manage
Project manage it yourself + some DIY labour20-25% saving possibleSignificantly more during active build phasesVery high: workmanship and liability risks

The savings are real. But they come from your time, your stress, and your willingness to solve problems at 7am on a Saturday when the screed pump breaks down.

The Time Commitment Nobody Mentions

"Daily site visits" is the advice you'll read everywhere. It tells you almost nothing.

On a typical week during active construction, expect to spend 1-2 hours per day. Some weeks more, particularly during groundworks or when trades are overlapping. Some weeks less, during planned pauses between phases. I worked full-time throughout my 35-month build and kept up with it. It wasn't effortless, but it wasn't a second job either.

That time breaks down roughly as:

On site (30-60 minutes most days): Checking work against drawings. Photographing progress for building control. Answering trade questions. Taking delivery of materials. Being there when the building control officer visits.

Off site (varies by phase): Calling suppliers about lead times. Chasing quotes. Reviewing invoices. Coordinating next week's trades. The administrative overhead is front-loaded: heavier during pre-construction and groundworks, lighter during second fix.

Warning

Trades call during business hours. Deliveries arrive during business hours. Building control inspections happen during business hours. If you have zero flexibility during the working day, project managing it yourself will be harder. The key is knowing in advance what sign-offs and decisions are coming up so you can plan around them rather than being caught off guard.

If I had structured guidance telling me what was coming at each stage, I could have planned my time better. Instead I spent a lot of time reacting. That's one of the main problems this site exists to solve.

Why Oversight Matters: The Ridge Beam Incident

My builder and his team changed the roof ridge beam from steel to timber without telling me or the architect. The structural engineer had specified steel. They substituted timber because it was easier and cheaper to install.

The building control officer spotted it when reviewing site photos. He arranged an immediate inspection. The beam wasn't to spec. It had to be taken out and replaced with the correct steel section, at the builder's cost.

If I hadn't been photographing progress and sharing it with building control, this might have been covered up by roof tiles and plasterboard. A timber ridge beam where steel was specified is a structural deficiency. It could affect the property for decades.

This is the strongest argument for project managing it yourself: you are the person who cares most about getting it right. A main contractor managing their own subcontractors has different incentives. They want the job done fast and profitably. You want it done properly.

Tip

Photograph everything before it gets covered up. Steelwork before the roof goes on. Drainage before the slab. Insulation before the plasterboard. First fix wiring and plumbing before plastering. Send photos to your architect and building control. This creates a record and forces accountability.

The Supplier Insolvency Risk

In April 2022, I ordered bifold doors and windows from a supplier. Total paid: £10,340 across three payments. By September, I'd read troubling Google reviews. By October, they'd cleared out of their premises. Insolvent. No doors, no windows, no company.

A Section 75 credit card dispute returned £10,624, marginally more than I had paid in. The replacement order from a different supplier cost £15,693. If I'd paid entirely by bank transfer instead of putting part of it on a credit card, I'd have lost every penny of that £10,340.

This risk is specific to project managing it yourself. When you hire a main contractor, they place orders with suppliers. If a supplier goes bust, the contractor absorbs the loss and finds an alternative. When you're placing orders directly with 15+ suppliers, every single one is an insolvency exposure point.

Construction firms account for roughly 18% of all company insolvencies in England and Wales. That's disproportionately high compared to other sectors. The Building Safety Act has increased operational costs for many smaller firms. Supply chain disruption hasn't fully resolved. More firms will go under.

Warning

Always pay supplier deposits on a credit card. Section 75 of the Consumer Credit Act means the card company is jointly liable for purchases over £100. If the supplier goes bust, you get your money back. This is non-negotiable if you are project managing. Do not pay large deposits by bank transfer, no matter how much of a discount the supplier offers for "direct payment."

Since October 2023, Part 2A of the Building Regulations requires every domestic building project to have a Principal Designer and a Principal Contractor. These are formal, legal roles introduced by the Building Safety Act 2022.

As a domestic client, you don't personally carry these duties. They pass to the people you appoint (or default to the designer and contractor in control of the work if you don't formally appoint anyone). But you do need to understand what this means.

If you're project managing it yourself with multiple individual trades, there's no single "principal contractor" by default. You need to either formally appoint one of your trades as Principal Contractor, or accept that the duty may fall to whoever is in control of the construction phase. Get this wrong and the lines of responsibility become unclear. Building control can (and increasingly do) ask who your appointed duty holders are.

Your architect or architectural technologist will typically fill the Principal Designer role. For Principal Contractor, pick the trade who is on site most consistently (usually the builder handling the structural phase). Put the appointment in writing.

Tip

Ask your building control officer at the initial application stage: "Who do you need me to name as Principal Designer and Principal Contractor?" They deal with this daily and will tell you exactly what documentation they need.

What My Build Actually Cost

I've written a full timeline of my 35-month kitchen extension with phase-by-phase costs. The summary:

The builder quoted £45,500 for the structural work. By the end he had been paid £53,855. But that covered only one part of the build. The other £68,295 of the construction cost went to a dozen other trades and suppliers: architect, structural engineer, electrician, plumber, drainage, screed, lead specialist, bifold doors (twice), roof windows, tiler, plasterer and painter. The kitchen came on top of that: kitchen supplier, kitchen fitter and worktop supplier, another £59,766. The garden was a separate cash job again.

The original builder quote never included most of these. It covered foundations, blockwork, steelwork, and getting the extension to a weathertight shell. Everything from first fix onwards was separate.

This is a common surprise for homeowners who project manage. The builder's quote looks like the whole job. It isn't. The finishing trades, the kitchen, the flooring, and the decoration are all on top. Budget accordingly, then track those categories separately in budgeting and contingency and tracking your build costs.

15+ separate contracts

The number of individual trade and supplier contracts I managed across a single kitchen extension. Each one required its own quote, negotiation, schedule coordination, and quality check.

The Skills That Actually Matter

Forget the generic advice about "being organised" and "good communication." Those are necessary but nowhere near sufficient. The skills that determine whether you succeed at project managing your own build are:

Reading drawings. Not just looking at them. Understanding what 1:50 scale means. Knowing that the dashed line on the plan is a beam above, not a wall. Checking that what's been built matches what was drawn. If you can't read a floor plan and a section drawing confidently, you will miss spec deviations.

Understanding trade sequencing. Knowing that the electrician needs to complete first fix before the plasterer starts, and that the kitchen layout must be confirmed before the electrician begins. Knowing that the screed needs 21 days to cure before tiling. Getting the sequence wrong costs time and money.

Spotting bad work before it's covered up. Blockwork that's out of plumb gets hidden by plasterboard. Drainage with insufficient fall gets buried under concrete. Insulation with gaps gets skimmed over. You have a narrow window to catch defects at each stage. Miss it and the rework cost multiplies.

Saying no under pressure. Your builder will propose changes that save him time and cost you quality. Your plasterer will want to start before the plaster has fully dried. Your tiler will suggest a different adhesive because it's what he has in the van. Some of these suggestions are fine. Some will cause problems. Knowing the difference, and having the confidence to push back, is what separates a project manager from a passenger.

How to Project Manage Your Own Extension, Step by Step

If you decide to do it, the work falls into seven stages. Each one has to be finished, or at least started, before the next can go well.

  1. Set the budget before anything else. Price the whole job, not just the builder: professional fees, every trade, the kitchen, flooring, decoration and a contingency. A budget that only covers the shell is the commonest way these builds go wrong. Start from budgeting and contingency.

  2. Get permission and the design signed off. Check whether you need planning permission or can use permitted development, appoint a structural engineer, choose your building control route, and serve party wall notices if the work is near a boundary. None of this can be rushed once the builder is booked.

  3. Find the trades and price the work like for like. Find a builder for the shell, then get at least three quotes for each package and compare them line by line. Two quotes that look far apart usually cover different things, and Rate My Quote will check what each one leaves out. The builder interview checklist gives you the questions to ask.

  4. Put contracts, payments and insurance in writing. Every trade gets a written scope, a price and a payment schedule tied to finished work, never to dates. Check each trade's insurance and tell your home insurer before work starts (insurance and liability).

  5. Build the programme, with the long-lead orders in it. Write down which trade follows which, and what has to be decided before each one starts. Steel, glazing and the kitchen can each take months, so they are ordered while the shell is still going up. The construction programme guide and the hard dependencies checklist cover this.

  6. Run the site week by week. Confirm the next week's trades and deliveries every Friday. Check work against the drawings before it is covered up, book each building control inspection in time, and write down every variation and its price before agreeing it. Track spending against the budget as invoices arrive, not at the end.

  7. Close it out properly. Collect the electrical and gas certificates as each job finishes, not months later. Get the completion certificate, walk the extension with a snagging checklist, and hold back the final payment until the snags are fixed.

The kitchen extension guide lays every task out in this order, with what each one depends on, so you can see what is coming before it arrives.

Who Should Project Manage Their Own Extension (and Who Shouldn't)

Score these as a household, not just as an individual. If your partner can take deliveries, handle supplier calls, or review invoices while you manage the trades, your combined availability and knowledge is what matters. Not just yours alone.

Project manage it yourself if:

  • Between you and your household, someone has flexibility during working hours or can take leave during critical phases
  • You have trade knowledge, construction experience, or a background in project management (or a partner who complements your gaps)
  • You have local trade contacts you've worked with before (or who come recommended by someone you trust)
  • You can handle financial stress: your £10,000 bifold order might disappear, your build might run 50% over budget, and your completion certificate might take 14 months
  • You genuinely enjoy problem-solving and aren't doing this purely to save money

Consider a PM or main contractor if:

  • Nobody in your household has any flexibility during business hours and you cannot take leave
  • You have no construction or trade experience and no one to fill that gap
  • You don't have existing trade contacts in your area
  • The thought of managing 15+ separate supplier relationships while living in a building site makes you anxious rather than energised
  • Your budget is tight enough that a 20% overrun would cause serious financial problems

The middle ground exists. Hire a main contractor for groundworks and structure (the riskiest, most sequencing-dependent phases). Then project manage the finishing trades yourself: kitchen fitter, electrician second fix, tiler, decorator. This gives you control and potential savings on the easier phases while professional coordination handles the hard ones.

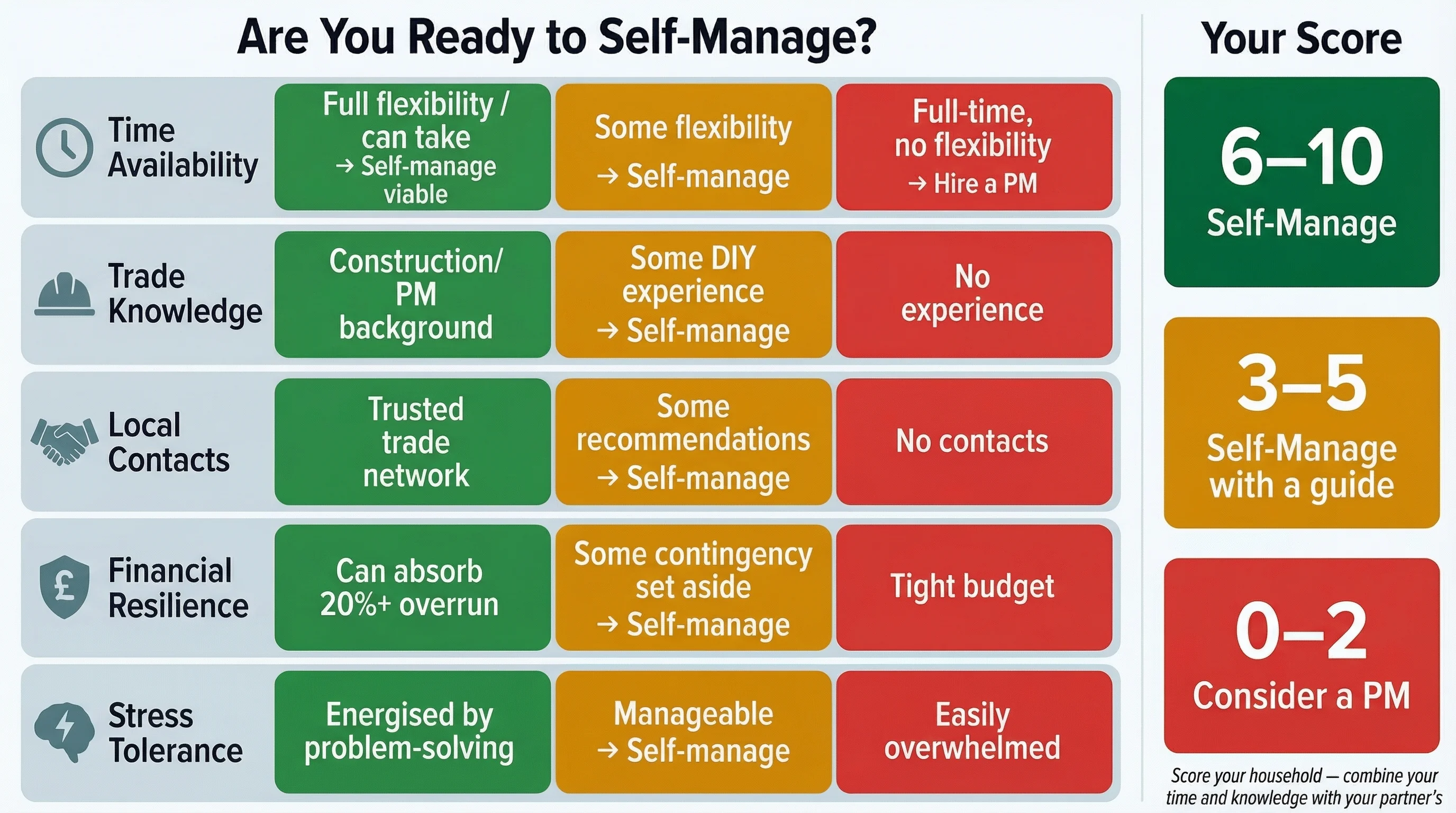

For each of the five rows below, pick the column that best describes your situation: green scores 2, amber scores 1, red scores 0. Add up your five scores to get your total.

Illustration in progress

Tip

Score your household, not just yourself. A partner who can take deliveries and chase paperwork while you manage the trades pushes your combined score up significantly. Many successful homeowner-managed builds are genuinely a two-person effort.

What I'd Do Differently

The saving was real. Across a £122,150 construction spend, avoiding a 15-20% PM fee saved me somewhere between £18,323 and £24,430. I'd do it again.

What I'd change is going in with better knowledge of what to expect at each stage. I spent time and money on avoidable problems: the ridge beam substitution that slipped through because I didn't know what to inspect at roof level. The 14-month gas certificate delay because I didn't know to chase it within 30 days of the work. The sequencing gaps between trades that cost me delays because I hadn't mapped the dependencies in advance.

None of those required special skills. They required knowing what the checklist looked like at each phase. With that knowledge, the 35-month build could realistically have been 12-15 months.

If you're weighing this decision, the right question isn't "am I capable?" Most homeowners are. The right question is: "do I have a structured guide to what happens at each stage, or am I going to figure it out as I go?" The first approach works. The second is how you end up managing a build that runs two years over schedule.

If you do choose to project manage it yourself, don't stop with this article. Build a construction programme, lock down your contracts and payment schedules, and learn what building control inspects at each stage before work starts. That's the difference between a real saving and an avoidable mess. The full kitchen extension guide sets out all eight phases in the order they actually happen, so you can see what is coming before you commit.

General guidance for homeowners in England (and Wales where we say so), not professional advice. Every site is different: check anything that affects your build with a qualified professional, your local council or building control. Terms
