Structural steel beams for extensions: section sizes, S275 vs S355, padstone bearing, 30 vs 60 minute fire protection, UKCA marking, and per-metre prices.
By IanLast updated
Project managed a £182k Oxfordshire kitchen extension
Structural steel only looks optional when the person trying to remove it is not the engineer who specified it. On extension work, an unauthorised substitution can bury delay, extra cost, and non-compliance inside the structure before anyone realises. The homeowner does not need to calculate the beam, but does need to understand what was specified and why. That is often the only thing stopping a convenient site shortcut from becoming an expensive rebuild.
This page covers everything a homeowner needs to know about structural steel for extension work in the UK: what the different sections are called, what they cost, how they're installed, why padstones matter, what fire protection is required, and how to spot when something has gone wrong.
What it is and what it's for
Structural steel is hot-rolled mild steel formed into long sections with specific cross-sectional shapes designed to carry load efficiently. In domestic construction, structural steel does one job: it bridges openings or spans that masonry alone can't span. Anywhere you have a wall that needs to stay up but you want to remove the bit underneath (a window, a door, a kitchen-diner opening, a wall taken out for open-plan), there's almost always a steel beam doing the work.
The UK industry uses confusing overlapping names for the same thing.
Universal Beam (UB) is the modern UK term. Cross-section is an I-shape with parallel flanges (the top and bottom horizontal bars of the I). This is what you'll see on every structural engineer's drawing for a current project.
Rolled Steel Joist (RSJ) is the older name. Historic RSJs had tapered flanges (thicker at the web, thinner at the tips). True tapered-flange RSJs are largely obsolete in new work. But "RSJ" has stuck as a generic trade term, and most builders, suppliers, and homeowners still call any I-section beam an RSJ. When your builder says "RSJ," they almost certainly mean a modern parallel-flange UB.
I-beam is the American term, sometimes used in UK informal speech.
All three usually refer to the same thing in a domestic extension context. Don't get hung up on the naming. The structural engineer's drawing will specify the exact section.
The standards apply regardless of what you call it. Structural steel work in UK buildings is governed by Building Regulations Approved Document A (structural safety) and Approved Document B (fire safety), with structural design carried out to BS EN 1993, the European standard known as Eurocode 3. Eurocode 3 replaced the older British standard BS 5950 in April 2010, although BS 5950 can technically still be used. Most UK structural engineers now design to Eurocode 3 by default.
There's one more standard that matters: structural steel sold in Great Britain must carry UKCA or CE marking. The planned switch to UKCA-only on 1 July 2025 did not happen: in 2024 the government committed to keep recognising CE marking for construction products, with at least two years' notice of any change. Any fabricator producing structural steel for your project must hold a Factory Production Control (FPC) certificate to BS EN 1090-1 from an Approved or Notified Body (it covers the firm's welding quality system), and must issue a Declaration of Performance with the steelwork. If a fabricator can't produce these documents on request, walk away. Building control will not accept uncertified structural steel.

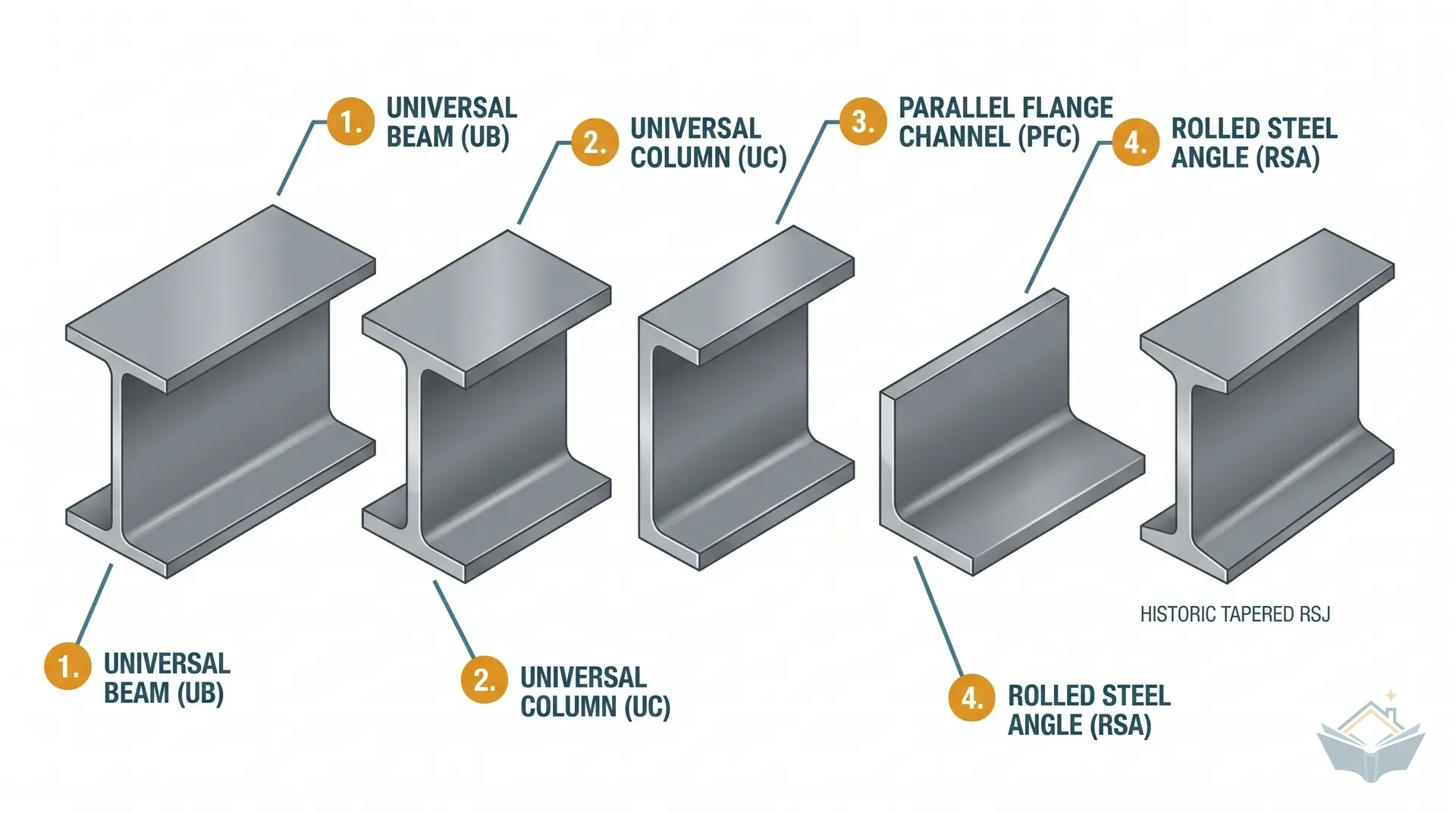

Section types you'll meet
Five section types come up on extension drawings. Knowing the difference helps you read what your engineer has specified.
| Section | Cross-section | Where it's used in extensions |
|---|---|---|
| Universal Beam (UB) | I-shape, deeper than wide | Primary horizontal beam across an opening; lintels over wider openings; structural ridge beams |
| Universal Column (UC) | I-shape, equal or near-equal width and depth | Vertical posts; goal-post frames; anywhere a vertical load path is needed at a corner or jamb |
| Parallel Flange Channel (PFC) | C-shape | Edge beams; trimmer beams next to rooflights or stairwells; back-to-back pairs to form a built-up section |
| RSA (Rolled Steel Angle) | L-shape | Connection brackets; secondary lintel angles in cavity walls; small trimmer angles |
| Old-style RSJ | I-shape with tapered flanges | Legacy term and legacy sections in older houses. Modern equivalents are all parallel-flange UBs. |
The two letters and three numbers on a structural drawing follow a strict format. A "203x133x25 UB" is a Universal Beam, nominally 203mm deep, 133mm wide flange, weighing 25kg per metre. The depth is what carries bending load efficiently, the width sets how much bearing the masonry above gets, and the kg/m number is how the supplier prices and weighs it.
Section size and what your engineer will specify
The structural engineer will pick the section size based on three things: the span, the load coming down on top of the beam, and the deflection limit (usually span divided by 360, so a 4m beam can deflect at most about 11mm under load).
This is indicative only. Always use the section your structural engineer specifies on the drawing.
| Span | Typical section (S275, residential roof or floor loading) |
|---|---|
| Up to 2m | 127x76x13 UB or 152x89x16 UB |
| 2 to 3m | 152x89x16 UB or 178x102x19 UB |
| 3 to 4m | 178x102x19 UB or 203x133x25 UB |
| 4 to 5m | 203x133x30 UB or 254x146x31 UB |
| 5 to 6m | 254x146x37 UB or 305x127x37 UB |
| 6m and above | 305x165x40 UB or larger; engineer's calculation essential |
A documented extension of around 55m² used 305x127x48 UBs for the main side spans of just over 5m, carrying the corner of the existing house. That's at the heavy end of typical residential because the beams carry load from the house as well as the roof, and the final design removed the corner posts altogether. A simpler rectangular extension with a 4m kitchen opening might only need a 203x133x30 UB. The variation is large and is driven entirely by the load path: what's above the beam (joists, roof, upper floor) and how far that load travels.
S275 vs S355 grades
Steel grade is the second specification on the drawing. Two grades dominate UK construction.
S275 has a yield strength of 275 N/mm². Adequate for most single-storey residential extensions. Better for welding. Cheaper.
S355 has a yield strength of 355 N/mm². About 29% stronger, allowing 15-25% lighter sections for the same capacity. Roughly 10-15% more expensive per kg. S355 is now the dominant grade in UK commercial construction generally, but for residential extensions S275 is still the common default unless the engineer specifies otherwise.
S460 exists for very high-load applications. You won't see it on an extension drawing unless something unusual is going on.
If the engineer's drawing says "S275" or "S355" with no further detail, the fabricator will supply that grade. Don't let anyone substitute a different grade without going back to the engineer for sign-off.
How structural steel actually gets specified, made, and installed
Steel arrives on site through a three-trade chain: structural engineer specifies it, fabricator makes it, builder installs it. Knowing who does what stops you from blaming the wrong person when something goes wrong.
The structural engineer's role
A chartered structural engineer (member of the Institution of Structural Engineers, IStructE, or the Institution of Civil Engineers, ICE) carries out load calculations, picks the section sizes, designs connections, specifies padstones, and produces a structural drawing. The drawing goes into your building control submission under the engineer's stamp. Their fee for the steelwork element of an extension typically runs £150 – £250 for initial calcs, or £600 – £2,200 as a complete package covering site visit, calculations, and drawings.
Skipping the engineer is the single most damaging mistake a homeowner can make. A 2018 CROSS Safety report found that 30-40% of structural applications received from non-professional engineers were potentially under-designed. Beams calculated as fully restrained when they should have been unrestrained, software used without understanding, copy-pasted spans from neighbours' projects. The cost of getting it wrong runs from cracked walls to collapse. The cost of getting it right is a few hundred pounds.
Warning
Never copy a beam size from a neighbour's project, an online calculator, or a forum thread. Span and section look similar; load path and deflection limits are not. A homebuilder publication put it bluntly: "RSJ costs should never be worked out online." The same applies to RSJ sizes. Always pay an engineer to specify your steel.
The fabricator's role
The fabricator is who turns mill stock into the exact piece you need. There are two purchasing routes:
Stock supply (online merchant or steel stockist). Cut to length from standard 6m or 12m mill lengths. No drilling, no welding, no end plates. Fast: 1-5 days delivery. Suitable for a single straight beam with simple bearing connections. Suppliers include FH Brundle, Southend Steels, metals4U, Pratley Builders Beams, and Cardiff Steels.
Fabricated to drawing. The structural engineer's drawing goes to a steel fabricator who cuts to exact length, drills bolt holes, welds end plates, and prepares column-to-beam connections. Lead time is 2-8 weeks depending on the fabricator's workload. Required for any multi-beam frame, goal-post arrangement, cantilever connection, or where one beam bolts to another.
The 55m² documented extension used a local fabricator (a small Oxfordshire firm) for the full sequence: the main beams and the ridge RSJ in December 2021 and January 2022, a cantilever in April 2022, then altered rear beams and a welded plate in the autumn. Fabrication came to £7,495 across six invoices, plus £1,150 of the builder's labour to install it. Four separate fabrication phases is unusual; most extensions complete fabrication in one or two phases.
Lead time matters more than price
Steel lead time is the project management trap. Order steel too early and the engineer's design might still change. Order it too late and the build sits idle waiting for the beams. The pattern that works:
- Engineer issues drawings.
- Building control accepts the structural calcs (no point fabricating against a design that fails BC review).
- Order fabrication before the wall opening is created on site, so the steel arrives roughly when the masonry is ready to receive it.
- Builder confirms padstone size and bearing detail before the steel arrives.
Plan four to eight weeks for fabricated steel from order to delivery. If your build programme depends on the steel being on site in week six, the order needs to be placed in week one or two.
The builder's role
The builder receives the steel, lifts it into position, beds it onto padstones, bolts up connections, fits temporary support during the lift, and applies fire protection. Most extension builders have done dozens of steel installations and know the drill. The risk areas are: under-engineered lifting (especially in confined spaces), wrong padstone size, inadequate bearing, and skipped fire protection.

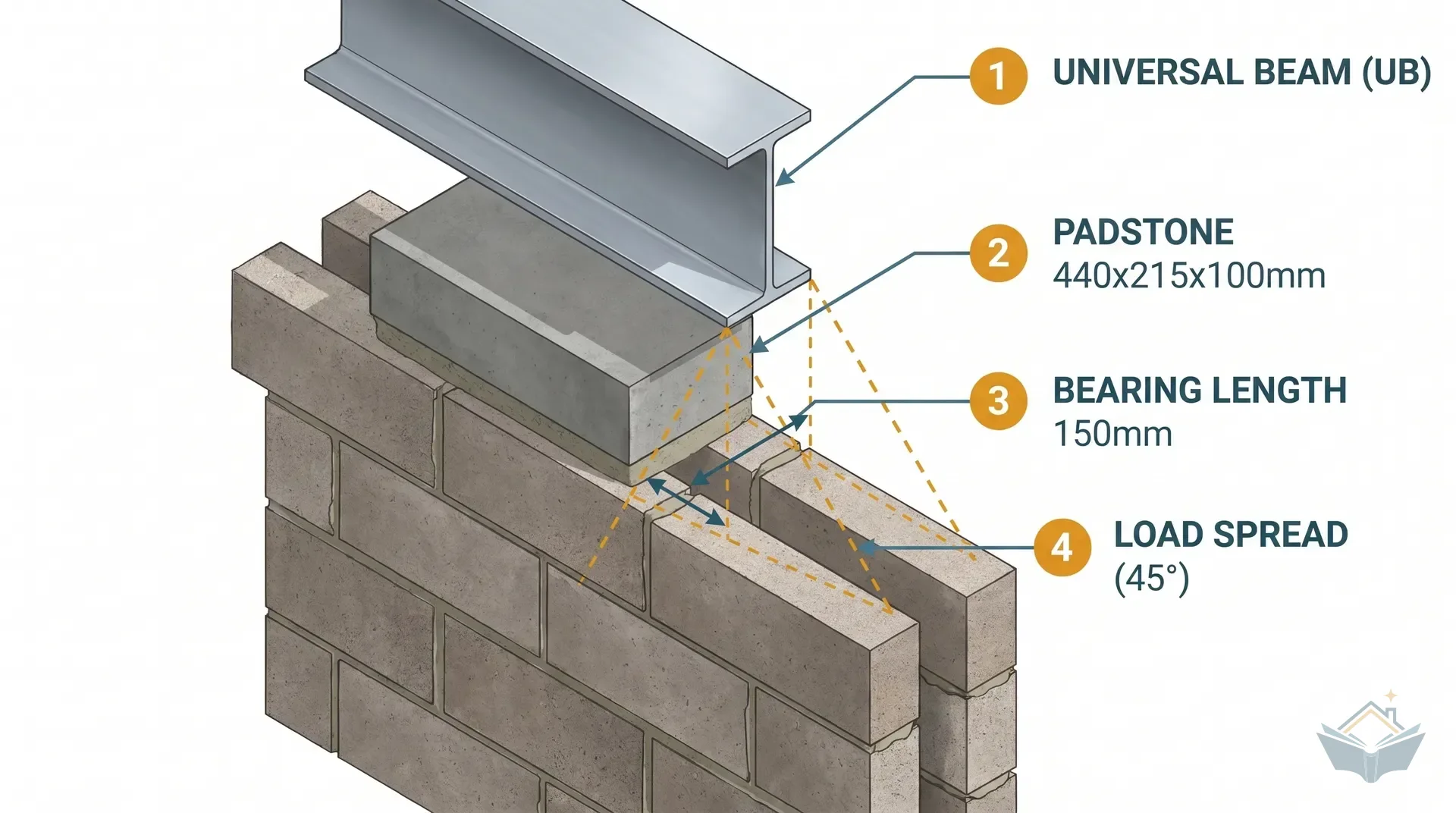

Padstones and bearing detail
A steel beam ends concentrate load into a small area of masonry beneath. Without something to spread that load, the masonry crushes and the beam settles, which cracks walls, jams doors, and triggers expensive remediation. The standard solution is a padstone: a dense concrete or engineering-brick block placed under the beam end, sized to spread the point load into the wall safely.
Standard UK padstone sizes for domestic work are 440x215x100mm, 440x215x140mm, and 440x215x215mm. The depth (100, 140, or 215mm) depends on how much load needs to be spread. Most extensions use precast concrete padstones at C40/50 strength class. £8 – £20 per padstone from a builders' merchant. A typical extension needs 2 to 4. Engineering bricks (Class B) are an acceptable alternative where a SE confirms the masonry strength is enough, but precast concrete is the default.
Three things must be right at every bearing:
Bearing length. UK guidance (Planning Portal, LABC, most building control officers) calls for a minimum 150mm bearing at each end. NHBC's Chapter 6.5 cites 100mm as a floor minimum, but in practice 150mm is what BCOs enforce. Your engineer's drawing will state the required bearing length; achieve at least that.
Padstone size. The padstone must be wider than the beam flange and deep enough to spread the load through the masonry below. If the engineer specifies 440x215x100, install 440x215x100. Don't substitute 300x215x100 because it's what the merchant had in stock.
Level and level bedding. The padstone must be level (spirit-level confirmed before beam delivery), bedded on a full mortar joint, and the top surface clean and dry when the beam arrives. Slate shims to pack out a low padstone are not acceptable; building control will reject slate because it crushes under load.
Warning
Padstones not centred under the beam, beam wider than the padstone, or gaps between beam and padstone are recurring forum complaints from homeowners whose builders have rushed the bearing detail. All three are repairable but only if caught before the beam is plastered over. Photograph every padstone with a tape measure in shot, and confirm with your engineer before any covering work happens.
Fire protection: 30 minutes or 60 minutes?
Bare structural steel loses strength rapidly above 550°C and will buckle in a fire. UK Building Regulations require structural elements to maintain their load-carrying capacity for a minimum period in a fire, expressed as REI minutes (Resistance, Integrity, Insulation). The required period for an extension steel comes from Approved Document B Volume 1, paragraphs 5.1 to 5.3 and Appendix B, Table B2.

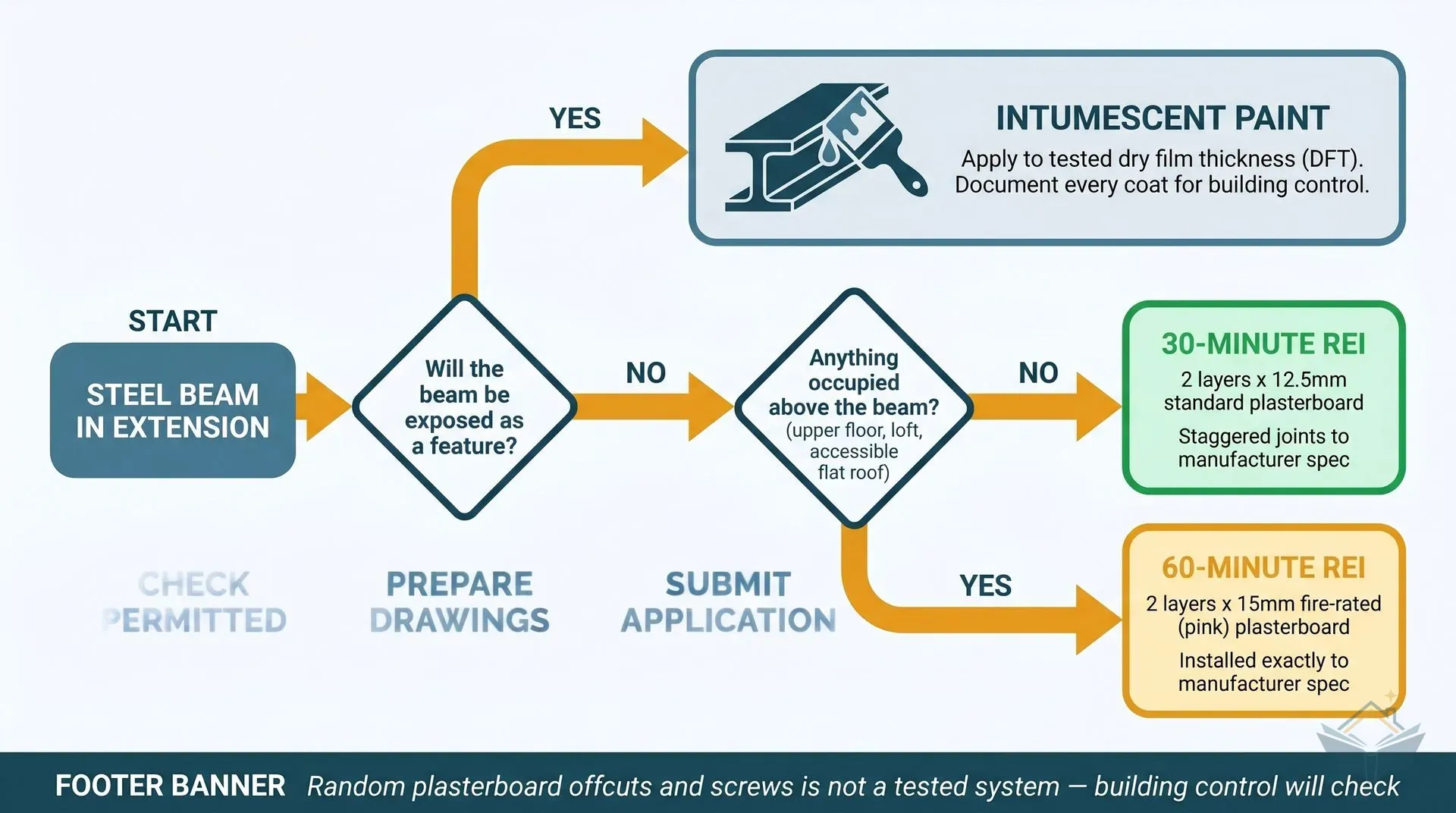

The decision tree is simpler than the regulations make it sound:
Single-storey extension, beam supports only the roof. Usually no fire resistance is required: Approved Document B excludes structure that supports only a roof (paragraph 5.3a), unless the roof is used as a floor (such as a roof terrace) or as an escape route, or the beam is essential to the stability of an external wall that has to be fire resisting. Many building control bodies still ask for 30 minutes, so confirm with yours. Where 30 minutes is needed, encase the beam in fire-rated plasterboard to a tested system: in British Gypsum's White Book GypLyner Encase system, one layer of 12.5mm Gyproc FireLine gives 30 minutes on beams with a section factor up to 260 m⁻¹, which covers most domestic sections. Two layers of standard plasterboard are not a White Book steel protection system, so only use them if your building control body has agreed it in writing.
Beam supports an upper floor or a loadbearing wall above. 30 minutes REI in a house whose top floor is no more than 5m above ground, and in any three-storey house (Table B2 and its note 5). 60 minutes applies to taller houses, or where the steel supports a wall separating your house from the neighbour's. Achieved with fire-rated plasterboard (the pink board, often Gyproc Fireline or equivalent) to the manufacturer's tested system for the period needed, installed exactly to the manufacturer's spec, including correct fixing centres, joint stagger, and metal corner beads.
Beam left exposed as a feature. Intumescent paint applied to a tested system thickness. The paint expands when heated to form an insulating char that protects the steel. Domestic-grade products like Zeroflame Aquasteel WB exist. Surface preparation matters: clean, dry, oil-free, with primer applied first. The required dry film thickness depends on section size and number of exposed faces, and your engineer or a fire-protection specialist will calculate it. Document every coat thickness for building control. Ask for a quote for the specified coating system and beam, including preparation and application.
Warning
You can't just bolt a sheet of plasterboard to a steel beam and call it fire protection. The fire resistance rating only applies if you install the system exactly to the manufacturer's tested specification: correct board type, correct thickness, correct fixings, correct joint stagger, correct number of layers. Building control will ask for the system reference and may refuse to sign off without it. The British Gypsum White Book is the standard reference document fabricators and builders use.
The community confusion on fire protection (visible across BuildHub, MoneySavingExpert, and Screwfix forums) is mostly about which scenario applies. If you have a single-storey rear extension where the beam carries only the roof, Approved Document B usually asks for nothing, though many inspectors still ask for 30 minutes. If your beam is under a converted loft, an upper bedroom, or the house wall carrying the floor above, you're at 30 minutes in a typical two- or three-storey house.
Thermal break at the column base
Where a steel column lands on the ground floor inside the warm zone of the building, raw steel acts as a thermal bridge: heat conducts directly out through the steel into the cold ground. This is a Part L compliance issue and a condensation risk. Any thermal break under a column base plate is part of the structure, so it has to be specified and sized by the engineer for the column's load.
Don't confuse this with a Marmox Thermoblock. Thermoblock (compressive strength 9 N/mm², thermal conductivity 0.05 W/mK, 600mm long, 65mm or 100mm thick, in 100mm, 140mm and 215mm widths) is made to replace the bottom course of a masonry wall at the wall-floor junction. It is not a column base product, and a column's concentrated load must not be put on one unless the engineer has designed for it.
If your steel design includes a goal-post frame with vertical columns landing on the ground floor inside the warm zone, ask your engineer how the column base is detailed for cold bridging. If it isn't addressed, raise it before the design is finalised.
Lifting and handling
Steel weight catches homeowners out. A 4m length of 152x89x16 UB weighs 64kg, roughly double what HSE guidance treats as low risk for two people lifting together, so even a light beam needs a planned lift. A 4m length of 254x146x37 UB weighs 148kg and a 4m length of 305x127x48 UB is 192kg: at those weights, plan on lifting equipment, not people.
Manual Handling Operations Regulations 1992 set no weight limit. They require the employer (on a domestic job, the builder) to avoid hazardous manual handling where reasonably practicable, assess what can't be avoided, and reduce the risk. HSE's low-risk guideline for one man lifting close to the body between knuckle and elbow height is 25kg (16kg for a woman); it is a screening figure, not a safe limit, and a two-person team is taken to manage about two-thirds of the sum of their individual capacities. For heavier beams expect a material lift, a gantry with a chain block, or a hired telehandler or small crane. That kit is lifting equipment, which must have a current thorough examination under LOLER 1998. Acrow props with strongboy heads (the bracket that supports the masonry above while the wall under it is removed) are temporary works to hold the wall up, not lifting gear.
CDM Regulations 2015 require every designer, including the structural engineer, to eliminate foreseeable risks where reasonably practicable and to pass on information about the risks that remain, such as an unusually heavy or awkward lift (regulation 9). Planning the lift and the temporary propping is the builder's job, and on a domestic project the client's CDM duties pass to the builder (regulation 7). Ask the builder how each beam will be lifted and how the masonry will be propped before the wall is opened.
The documented build's main steels were 305x127x48 UBs; at 48kg a metre, a 5m length weighs about 240kg, far beyond a manual lift. Plan well ahead for lifting on tight terraced or end-of-terrace access.
How much does a typical extension's steelwork cost
For an extension with a single 4m kitchen opening, expect:
- Structural engineer fee for steel design: £600 – £2,200
- Steel supply (cut to length, simple beam): a few hundred pounds depending on section size, calculable from the per-metre table below
- Padstones: 2 to 4 at £8 – £20 each
- Builder labour for installation: £800 – £1,500
- Fire protection plasterboard and labour: £200 – £500
A straightforward single-beam project lands at £900 – £1,600.
A wider opening with a cantilever for corner-free bifolds adds:
- Cantilever steel fabrication: £1,000 – £1,500
- On-site welding for connections: £700 – £1,200
- Possible additional pier or foundation work: £300 – £600
Long-span or complex multi-beam jobs run £3,000 – £10,000, including the documented 55m² project at the upper end of that range due to repeated design revisions.
Per-metre supply pricing
If you want to sanity-check what your fabricator is quoting for the steel itself (separate from labour and engineering), per-metre supply prices from UK retailers and stockists are:
| Section | Supply price per metre | Typical span |
|---|---|---|
| 152x89x16 UB | £34.80 – £60.00 per metre | Up to 3m |
| 178x102x19 UB | £45.60 – £84.00 per metre | 3 to 4m |
| 203x133 UB | £55.20 – £102.00 per metre | 4 to 5m |
| 254x146x37 UB | £88.80 – £120.00 per metre | 5 to 6m |
| 305x165x46 UB | £110.40 – £180.00 per metre | 6m and above |
These are stock prices for cut-to-length supply. Add 20-50% for fabrication (drilling holes, end plates, welded connections), more for cantilevers or goal-post frames. Delivery is typically £48 – £96 within local area, free above an order threshold of around five hundred pounds at most stockists.
If your builder's steel quote is more than double these per-metre figures multiplied by the beam length, plus a fair margin, ask what's in the difference. Some fabricators bundle install labour into the steel supply line, which is fine if disclosed.
External resource
Southend Steels UB price list
UK steel stockist with current per-metre prices for all common UB sizes. Useful sanity check on a fabricator's quote.
southendsteels.com
Building control inspections for steel
Building control (LABC or a registered building control approver) inspects extension steelwork at three points typically:
- Before steel arrives. Padstones in place, bedded, and level. Bearing locations confirmed against structural drawings.
- Steel installed but not yet covered. Beam in position on padstones, bearing length achieved, connections bolted and welded as specified, no obvious deflection. The BCO will physically check this.
- Fire protection complete, before plastering. Boarding installed to manufacturer spec, or intumescent paint applied to documented thickness.
The hard rule: never plaster, board, or otherwise hide structural steel before the BCO has inspected it. Builders sometimes try to keep the programme moving by covering ahead of inspection. If they do, the BCO can require the covering to be removed at your expense to verify what's underneath. On the documented 55m² build, three separate steel inspection points happened across 11 months of structural work, including the May 2022 ridge beam crisis described in the next section.
What can go wrong: a real ridge beam substitution
The most instructive structural failure isn't a collapse, it's a substitution. On a 55m² rear extension with a vaulted shallow-pitch roof, the structural engineer specified a steel ridge beam to control the outward thrust from the rafters onto the wall plates. The builder, reasonably enough from his perspective, decided the steel ridge was unnecessary and substituted two bolted-together 8x2 timber beams. He raised it with the designer, but no revised design was issued, building control wasn't asked, and the homeowner wasn't told.
The building control officer spotted it from site photos and booked a visit. Timber, however well-bolted, is less stiff than steel. The beam would deflect more under roof load, the rafters would push out at the wall plates, the wall plates would pull on the masonry, and over time the walls would crack and the roof would sag. The designer's own check put the timber ridge's deflection at more than 80mm against about 5mm for the specified steel. The steel ridge had to be reinstated: the builder lifted the timber out, fitted the specified steel, and the BCO re-inspected. It was put right within about a week.
The lesson isn't that builders are dishonest. Most aren't. The lesson is that on any structural project, the contract should explicitly prohibit substitution of any structural element without written approval from the structural engineer. Add a clause. Get it signed before work starts. If your contract doesn't contain that clause already, BCO inspection is your only catch, and BCOs only inspect after the work is done.
Common mistakes
Using an online RSJ calculator instead of paying an engineer. Online calculators give a section size but ignore foundation suitability, wall capacity, building stability, and load combinations. Cheap is expensive when the wall cracks two years later.
Ordering steel before building control approves the structural calcs. A failed BC review can change the section size or connection detail. Fabricated steel ordered against a rejected design either gets re-fabricated (at cost) or sits in a yard while the rest of the build waits.
Padstone undersized or substituted on site. The builder uses what's in the merchant's yard rather than what the engineer specified. Visible at inspection if you photograph everything; expensive to fix if the wall is already plastered.
Mistaking 30 minutes fire resistance for "30 minutes of any plasterboard." The fire rating only applies if you follow the manufacturer's tested system specification. Random plasterboard offcuts fixed with random screws don't qualify.
No thermal break at column bases. The Part L issue surfaces years later as condensation forming on cold spots near the column base, then mould.
Substituting timber for steel without engineer approval. As above; don't let it happen, and write the prohibition into the contract.
Treating "RSJ" and "UB" as different products. They're the same thing in modern domestic work. Don't pay a premium for a "real RSJ" or accept a substitution from "RSJ" to "UB" as if it matters.
