Do You Need Planning Permission for Your Extension?
How to tell whether your extension needs a planning application or falls under permitted development. Covers the two routes, when PD rights don't apply, and how to check your property.
This guide covers houses in England. Start with your property type, the extension's dimensions and any restrictions on your address. Scotland, Wales and Northern Ireland have different planning rules.
Which Planning Route Fits Your Extension?
| Your proposal | First route to check | What you must establish |
|---|---|---|
| Single-storey rear extension up to 3m on a terraced or semi-detached house, or 4m on a detached house | Standard permitted development | Every condition must be met, including height, boundaries, previous extensions and property restrictions. Depth alone is not enough. |
| Larger single-storey rear extension up to 6m or 8m respectively | Larger Home Extension prior approval | Check eligibility and complete the council's prior-approval process before starting. This route is unavailable on designated land or a Site of Special Scientific Interest. |
| Side or two-storey extension | Check the separate permitted development conditions | Rear-extension depth limits do not establish whether these proposals qualify. |
| Flat, maisonette, proposal outside the limits, or relevant PD rights removed | Planning application | Ask the council or your designer to confirm the application type and restrictions. |
| Listed building | Separate listed building consent check | Planning permission or permitted development does not replace consent for works affecting the building's special character. |
Measurements relate to the original house, so an earlier extension can use part of the allowance. Check the Planning Portal's full limits and conditions before relying on this summary. Our permitted development guide explains the dimensions in more detail.
Use the free address check to identify possible local constraints, then confirm them with your council. It is a starting point, not confirmation that your proposal is lawful.

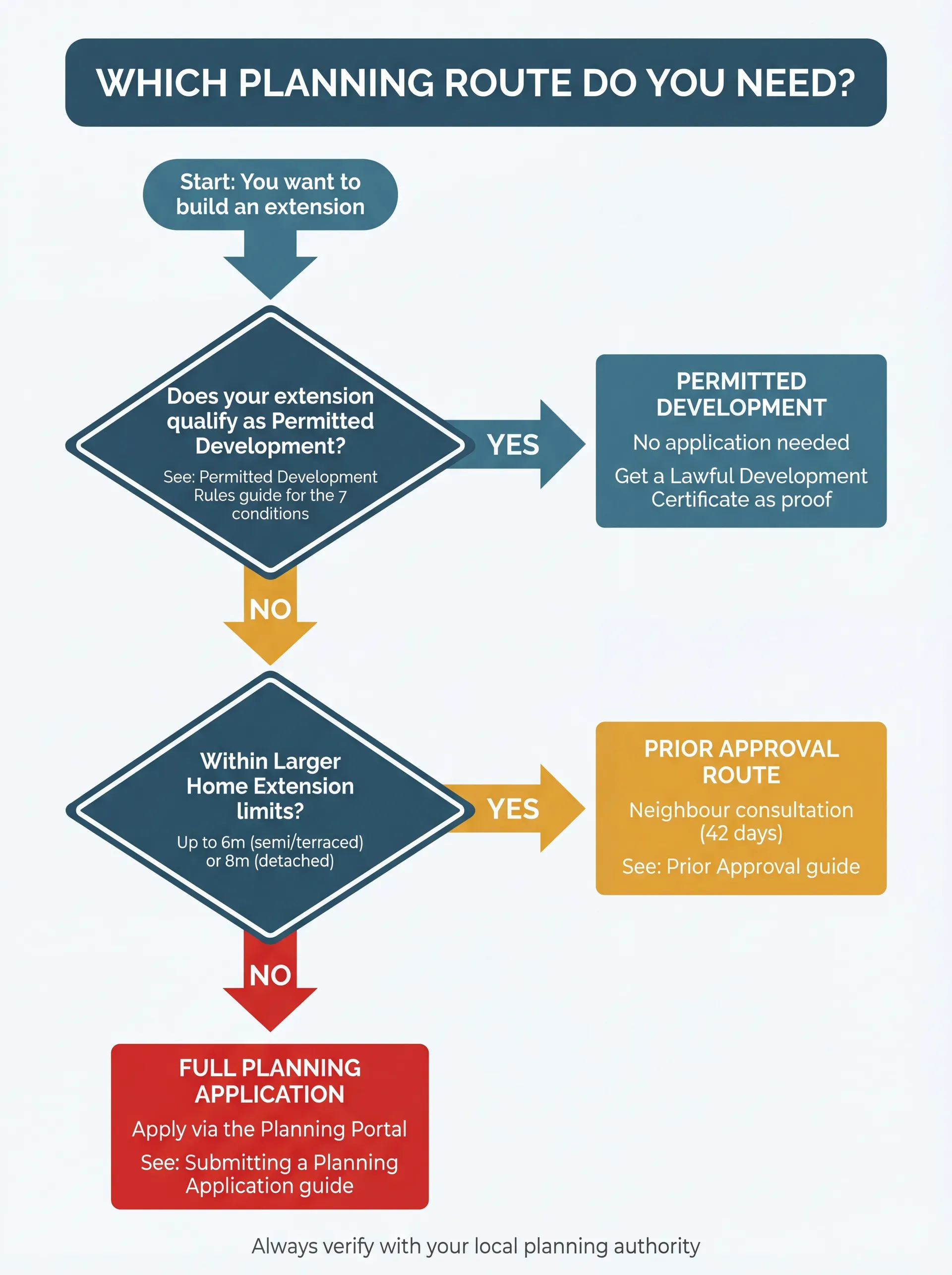

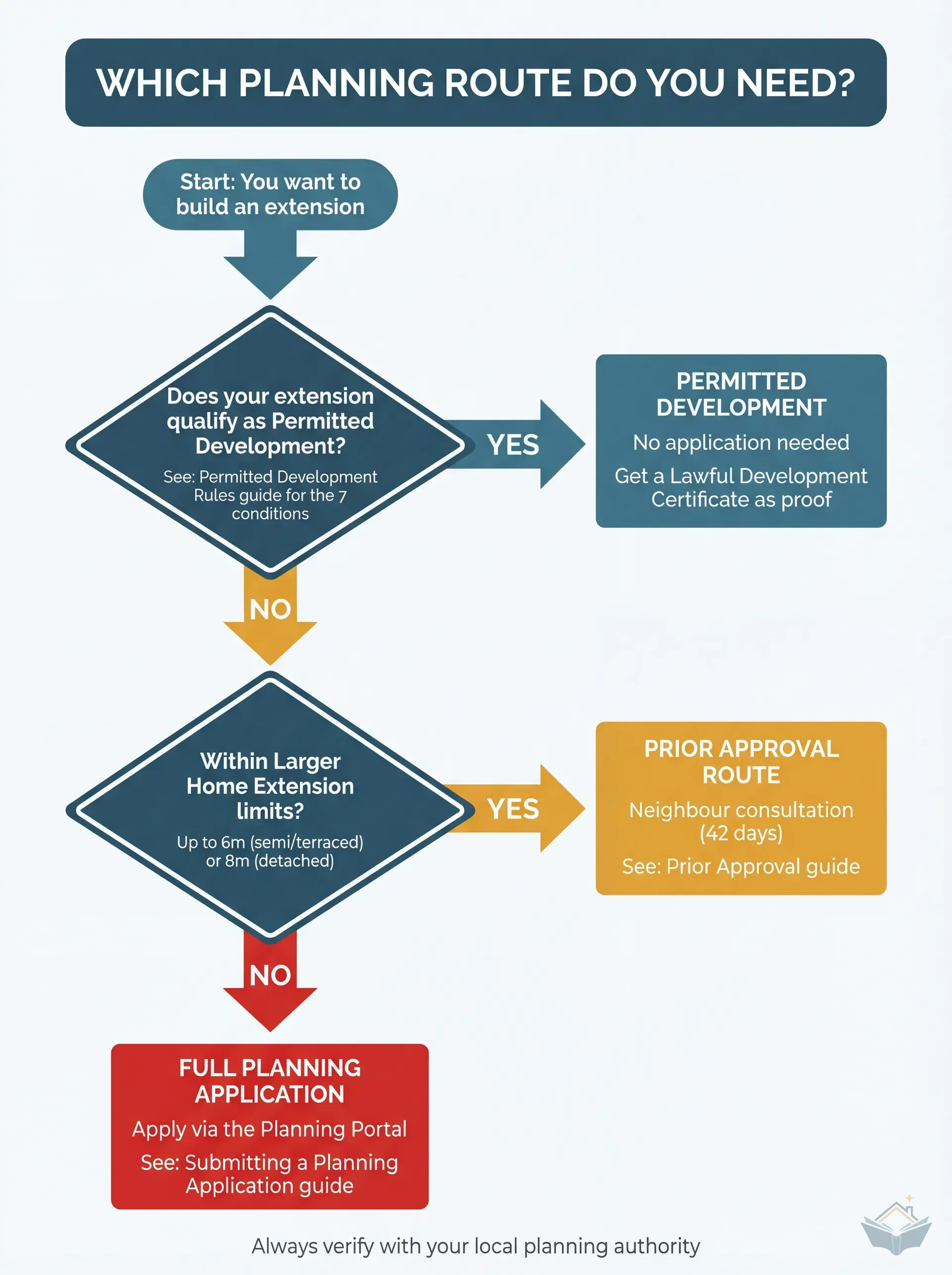

Two Routes, One Question
The main distinction is between permitted development and a planning application. Some permitted development proposals still require prior approval from the council.
Route one: permitted development (PD). Your extension falls within a set of nationally defined size and position limits. You don't need to apply for planning permission. You can build, provided you meet every condition. The rules are precise, and misinterpreting them is easy. We cover these in detail in Permitted Development Rules.
Route two: householder planning application. Your extension exceeds the permitted development limits, or your property type or location removes your PD rights entirely. You submit an application to your local planning authority, pay the fee, and wait for a decision. The council assesses your proposal against its impact on neighbours, appearance, parking, and drainage. If you do apply, our council planning league table shows how quickly your council decides householder applications and links to its planning search.
| Permitted Development | Householder Planning Application | |
|---|---|---|
| Do you apply to the council? | No householder application if all conditions are met; larger rear extensions need prior approval. An LDC can confirm lawfulness. | Yes, formal application through the Planning Portal |
| Fee | £274 for a Lawful Development Certificate | £548 (England, from April 2026) |
| Timeline | LDC takes 6-8 weeks | Target 8 weeks, often longer |
| What it controls | Size, height, position, materials, curtilage coverage | Appearance, neighbour impact, parking, drainage, character |
| Building regs still required? | Normally, for a habitable extension | Normally, for a habitable extension |
Planning and building control answer different questions. Planning considers the proposed development and its effects; building regulations cover matters such as structure, fire safety and energy efficiency. A habitable extension normally needs building regulations approval even when no planning application is required.
Do this first
Building control is a separate process with its own application, fees, and inspections. Read Building Control: How to Apply and What to Expect before assuming planning permission is all you need.
When You May Need Planning Permission or Consent
Some situations change the answer. If any of these apply, expect to need a planning application or listed building consent, or at least check carefully before relying on PD.
Listed buildings. Any extension or alteration that affects the character of a listed building needs listed building consent, and carrying out the work without it is a criminal offence. This applies to Grade I, Grade II*, and Grade II listed properties. Even minor external changes that would normally fall under PD require formal consent, so talk to the council's conservation officer before you design anything.
Conservation areas. Permitted development rights are restricted in conservation areas (and in National Parks, AONBs, the Broads and World Heritage Sites). Side extensions, two-storey rear extensions, external cladding and the Larger Home Extension route are specifically excluded. A single-storey rear extension within the standard depth limits may still be possible under PD unless your council has removed that right with an Article 4 direction, but check before you assume.
Flats and maisonettes. PD rights for extensions apply only to houses. If you live in a flat or maisonette, you need planning permission for any extension.
Exceeding PD limits. If your single-storey rear extension goes beyond 6m (semi-detached or terraced) or 8m (detached) under the Larger Home Extension scheme, or exceeds the standard 3m (semi-detached/terraced) or 4m (detached) limits without prior approval, you'll need a full application. The same applies if extensions and outbuildings together would cover more than 50% of the land around the original house or the extension exceeds 4m in height. Any PD condition you fail to meet pushes you into the formal application route.
Previous extensions. Here's where people get caught. The PD limits are measured against the "original house," defined as the house as it stood on 1 July 1948 (or when first built, if later). If a previous owner added a conservatory in 1990, that counts against your allowance. Check your property's planning history with the council before relying on PD.
Article 4 directions. Some councils remove PD rights for specific streets or areas using Article 4 directions. This is separate from conservation area restrictions. A condition on the original planning permission for your house can also remove PD rights. Your council's planning department will tell you if one applies to your address; our free address check gives a first look at your postcode.
How to Check
Don't start with Google. Start with your local council's planning portal.
Search your council's planning register for previous applications and decision notices. Read conditions that may remove permitted development rights. Check the council's Article 4 and conservation-area records separately: older documents and restrictions may not all appear in an address search. Ask the planning team about gaps in the record.
Tip
Search your address on your local council's planning portal before doing anything else. You'll find your property's planning history, any existing permissions, and whether your area has restrictions that remove PD rights. The national Planning Portal at planningportal.co.uk also has a useful interactive tool for checking PD limits.
If you're unsure after checking, pay for a pre-application advice service. Most councils charge £100 – £300, though London and larger urban councils can charge £400 – £600 for written advice. You describe your proposal, and a planning officer gives you an informal opinion on whether it needs permission and whether it's likely to be approved. Not binding, but useful. It's cheaper than submitting a full application only to have it refused.
Your architect should also confirm the planning route as part of their initial consultation. Any competent architect will assess PD limits and advise whether you need to apply. If your architect doesn't raise this in the first meeting, ask directly.
What the Council Actually Assesses
Planning permission is not about whether your extension is structurally safe (that's building control). The council is assessing something different entirely.
Neighbour impact comes first. Will the extension overshadow their garden or block light to neighbouring windows? Will it overlook a private space? Then there's appearance: does the extension respect the character of the street, and are the materials appropriate? The council also weighs practical constraints like parking capacity and drainage.
The council will consult your neighbours as part of the process. Neighbours can object, and if they do, the planning officer considers those objections alongside their own assessment. Objections don't automatically mean refusal, but they do mean the officer has to address the concerns in their decision report.
Planning officers routinely visit while the homeowner is out. They inspect from the outside, take notes, and leave without making contact. Don't rely on a site visit as a chance to explain your proposal. Your drawings need to communicate everything.
What It Costs
The council fee alone for a householder planning application is £548 (as of April 2026), due to rise to £575 for applications made from 8 December 2026 if Parliament approves draft regulations. But the total cost is higher once you include architect submission fees, OS maps, and the Planning Portal service charge.
Total planning application cost (England)
Prices as of September 2026
How Long It Takes
The statutory target is 8 weeks from a complete application to decision. Budget for 10-14 weeks in practice. Once granted, planning permission is valid for 3 years, miss that window and you reapply from scratch.
Do this first
A planning decision notice is not a build start notice. Building control approval, party wall notices, and builder mobilisation typically add 4-6 months between permission granted and the first digger on site, with 9+ months possible if party wall complications arise. See Construction Programme for a breakdown of this gap and when to start each process.
Read the Conditions
Planning permission rarely arrives without conditions attached, and every one is legally enforceable. Some must be formally discharged before you can start work on site, miss one and the entire permission can be invalidated.
If Your Application Is Refused
Refusal isn't the end. You can appeal to the Planning Inspectorate (free, within 12 weeks) or resubmit an amended application addressing the reasons for refusal.
Do this first
For the full application process - every cost broken down line by line, timeline and what to do if the council is slow, how to discharge conditions, and what to do if refused - read Submitting a Planning Application.

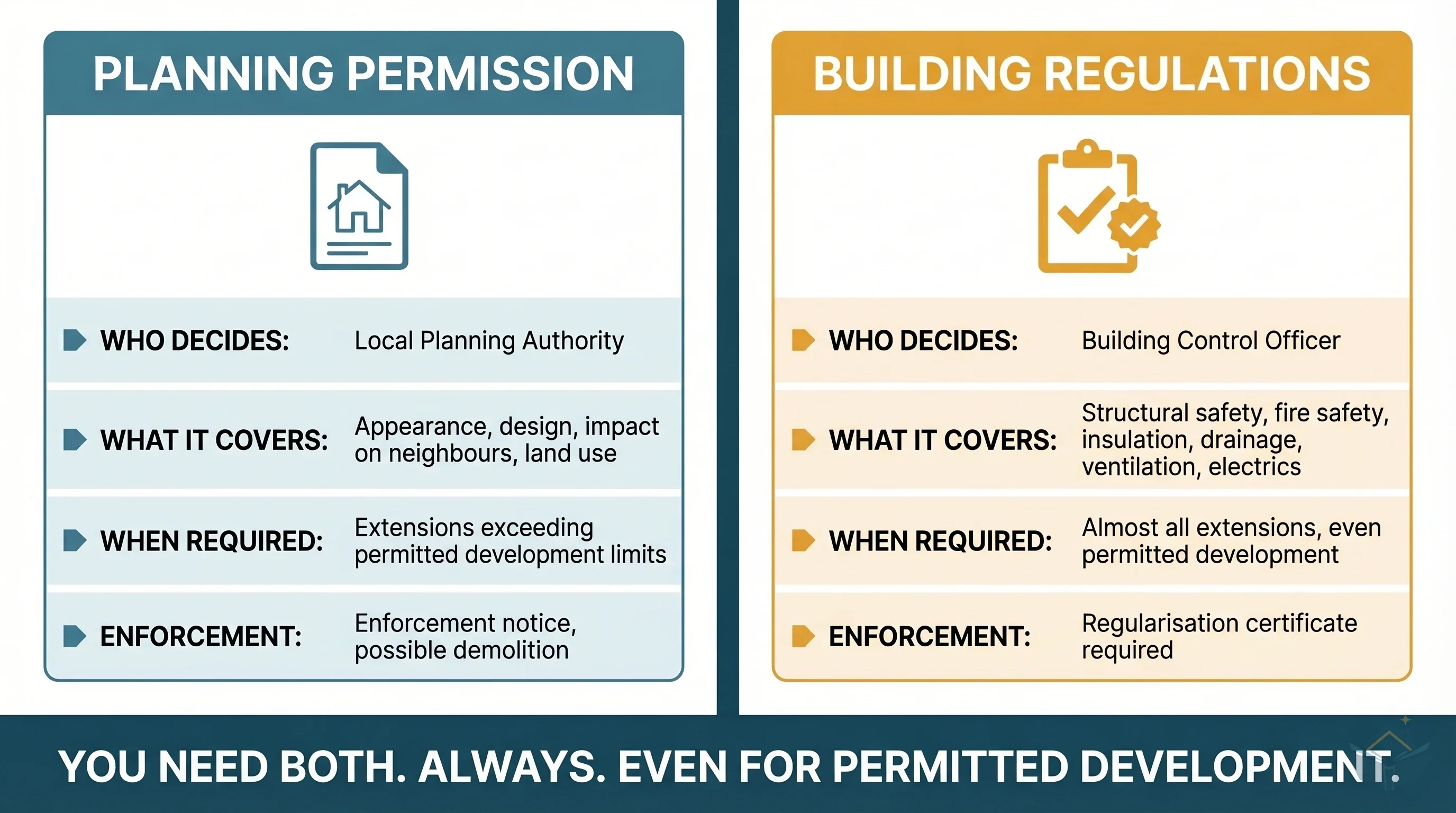

Planning Permission vs Building Control: Know the Difference
This is the single most common misunderstanding. Planning permission granted does not mean you can start building. It means the council is satisfied that your extension is acceptable in terms of appearance, impact, and land use. It says nothing about whether the structure is safe, energy-efficient, or compliant with fire regulations.
| Check | What it establishes | Does permitted development replace it? |
|---|---|---|
| Planning route | Whether the proposal needs a planning application or qualifies under PD rules | PD can remove the need for a householder application; prior approval may still apply. |
| Building regulations | Whether the construction meets applicable technical requirements | No. Check the building-control route separately. |
| Listed building consent | Whether works affecting a listed building's special character are authorised | No. It is a separate consent. |
| Party walls and private rights | Whether notices, agreements or other permissions are needed | No. Planning status does not settle private property rights. |
Building control is a completely separate application with its own fee (typically £300 – £900 for the application plus £500 – £800 for inspection fees, varying by council and floor area), its own documents (structural calculations, thermal calculations, drainage plans), and its own inspections throughout the build. Your architect prepares the building control submission separately from the planning application.
Confirm both processes, but do not assume that means two permission applications. See GOV.UK building regulations guidance for the separate building-control requirements.
Printable
Planning Permission Checklist
Covers everything to check before submitting: PD limits, conservation area status, Article 4 directions, neighbour considerations, parking, and what to prepare for your architect.
Interactive calculator
Do You Need Planning Permission?
Answer a few questions about your property and proposed extension to find out whether you need planning permission, can use permitted development, or may qualify for prior approval.
What to Do Next
If you've established that your extension falls within permitted development, head to Permitted Development Rules for the specific size and position limits. Get a Lawful Development Certificate (£274) as formal proof. You still need building control approval and potentially a party wall agreement before you can start building.
If you need planning permission, the process starts with your architect. They prepare the drawings, submit the application, and manage the council interaction. Read Finding an Architect to understand what that relationship costs and how to appoint one.
Either way, don't confuse planning with building control. They run in parallel but answer different questions, cost different amounts, and involve different people. Confirming your planning route is the first step. Building regulations approval, party wall clearance, and finding a builder all come next.
General guidance for homeowners in England (and Wales where we say so), not professional advice. Every site is different: check anything that affects your build with a qualified professional, your local council or building control. Terms
