My builder quoted £45,500. The kitchen extension cost £181,916.
That is not a typo. It is not an exaggeration. It is the number you get when you add up every invoice, every credit card statement, and every cash payment across 35 months of a single-storey rear extension in Oxfordshire.
The builder's quote was never a lie. It covered the shell: foundations, walls, roof, basic finishes. What it did not cover was the kitchen, the appliances, the worktops, the plumbing, the electrics, the drainage, the utility meter moves, the architect, the structural engineer, building control fees, the bifold doors that had to be bought twice because the supplier went insolvent, or the roof windows. Every one of those was a separate contract, a separate invoice, a separate negotiation.
I project managed the whole thing myself. First architect contact in February 2021. Building control sign-off in January 2024. Thirty-five months, 15+ separate trade and supplier contracts, and enough mistakes to fill a manual. The spec throughout was upper mid-range, not luxury.
These are the ones that mattered most.
The Quote Is Not the Cost
The single biggest misconception about kitchen extensions is that the builder's quote represents the total cost. It doesn't. Not even close.

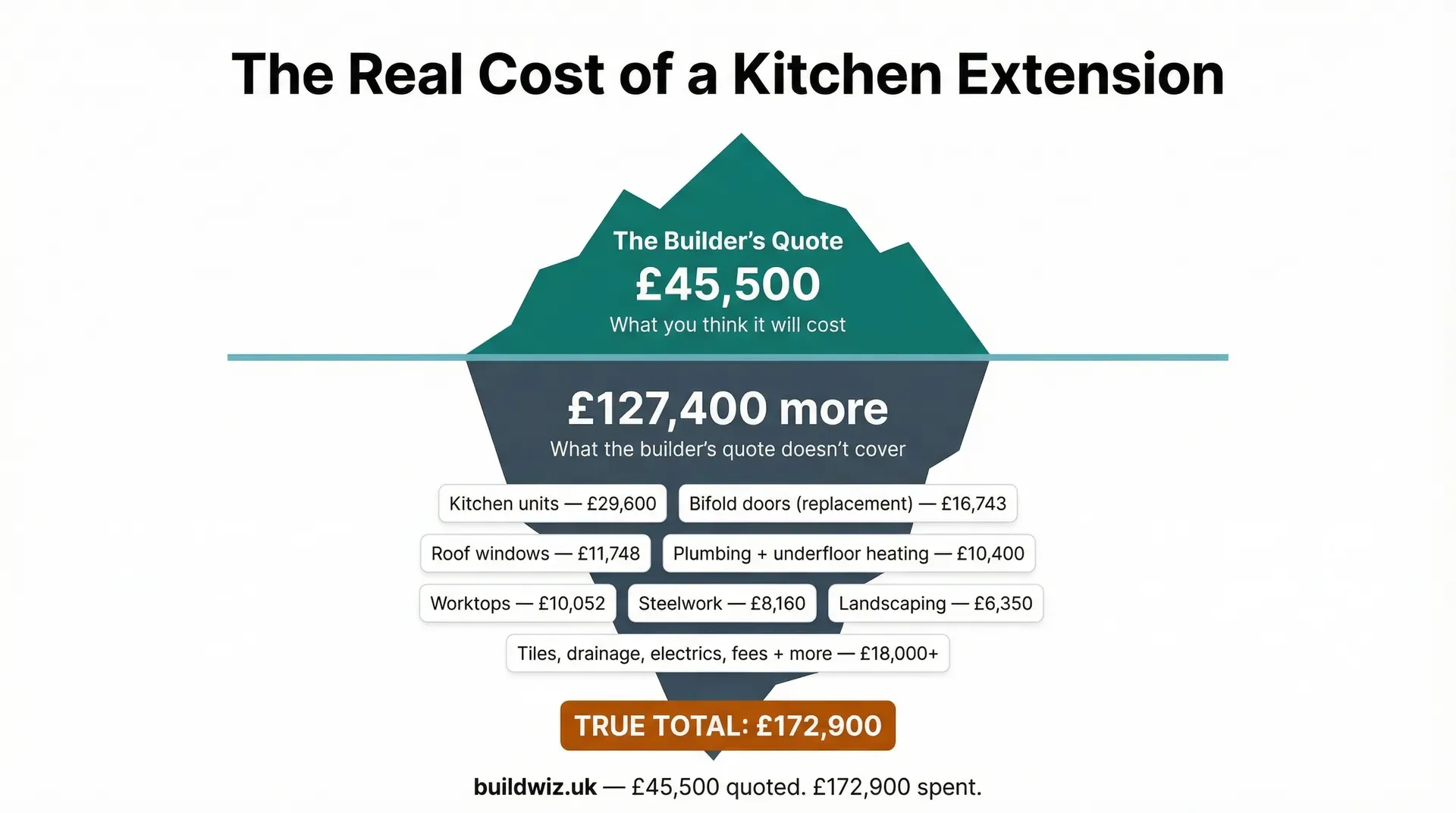

My builder quoted £45,500 for a 55m2 kitchen extension in Oxfordshire. His charges reached £53,142 by the end, about a sixth over. That is actually quite good by industry standards, where 20-30% overruns on the builder's own scope are common.
But the builder's scope was roughly 30% of the true project cost.
Here is where the biggest pieces of that £181,916 went:
| Category | Cost | Notes |
|---|---|---|
| Builder (shell, structure, labour; steel is its own line) | £44,077 | Stage invoices over 14 months |
| Kitchen units | £33,250 | German handleless range, supply only, no fitting |
| Replacement bifolds, windows + back door | £16,743 | First supplier went bust |
| Roof windows | £11,748 | Velux-style, flat roof compatible |
| Appliances | £10,682 | Hob, two ovens, fridge, freezer, dishwasher, wine fridge, warming drawer |
| Plumbing + underfloor heating | £9,695 | Boiler, 66m2 UFH, Quooker. Quoted at £10,400 including a water softener, which I bought myself instead (£700) |
| Worktops (quartz, 30mm) | £10,052 | Island with waterfall ends, sink run, splashback |
| Steelwork (fabrication + install) | £8,645 | 4 major UB sections plus cantilever and ridge |
| Landscaping (paid in cash, outside the total) | £6,350-£7,000 quoted | Patio and fencing; never entered the ledger |
| Floor tiles (81m2) | £3,933 | Supply only, trade discount |
| Service trenches + soakaway | £3,250 | Separate contractor, mostly cash |
| Electrics | £6,624 | First and second fix, across eight invoices |
| Architect + structural engineer | £2,604 | Planning, BC, structural calcs, redesigns |
| Liquid screed (80m2) | £2,560 | Cementitious flowing screed at 65mm |
| Utility service alterations (gas + electric) | £1,878 | SSEN electric cable £1,021. SGN gas pipe quoted £809, then refunded and recharged at £857 when an emergency callout did the same reroute. The meter moves themselves were not charged |
| Painting | £2,188 | Mist coat, finish, wallpaper |
| Building control fee | £882 | Full plans application |
| Thames Water build-over | £299 | Sewer runs under the footprint |
A note on specification before you dismiss these numbers as someone else's problem: this was not a luxury build. The kitchen units were an upper mid-range German handleless range, available from a showroom rather than custom-built. The appliances covered a family's practical needs: induction hob, two ovens, fridge-freezer, dishwasher. Quartz worktops rather than laminate, but not marble. No bespoke joinery, no hand-painted cabinetry, no wine wall. If you plan the same footprint with a flat-pack kitchen from a DIY chain, you could trim £20,000–£30,000 from the kitchen-related lines. The builder's invoice, the steelwork, the plumbing, the professional fees: those numbers barely move regardless of kitchen spec.
Mumsnet has a thread where someone says: "Expect it to cost twice the original estimate. Literally...twice as much." In my case it was four times. That Mumsnet poster was being optimistic.
4.0x
The lesson: before you commit to a build, make a spreadsheet with every line item above. Put in your own numbers. The builder's quote is one line on that spreadsheet. If the total shocks you, adjust the spec before you start, not halfway through.
Get the Kitchen Layout Before You Submit to Building Control
This one cost me months and money. It's the sequencing mistake that nobody warns you about because architects and kitchen designers operate in separate worlds.
I submitted my building control application in July 2021. The structural design included an interior support column. By August, with the kitchen layout taking shape, we no longer wanted a post standing in the middle of the room.
So I went back to my architect and asked to remove it. That required a heavy pair of transverse steel beams and an internal buttress, revised structural calculations, and a variation submission to building control. Cost: £315 in drawing modification fees, plus whatever the heavier steelwork added to the builder's bill. Conditional approval then arrived for the original design, complete with the column we had already decided to remove.
The fix was obvious in hindsight: engage the kitchen designer before finalising the structural design. The kitchen layout drives where the columns can go, where the steels need to span, and where the services run. Not the other way around.
Warning
One more thing on this: share your original house plans with the structural engineer before design begins. My house had an existing 178x102 UB bressummer (a steel beam) running across the kitchen floor that wasn't initially accounted for. It showed up in the original plans. The structural engineer had to revise his load path modelling when it was discovered. If he'd seen the plans from day one, that revision would not have happened.
Your Builder Will Substitute Materials. You Need to Catch It.
In May 2022, my building control officer turned up for a roof inspection and found that the ridge beam was timber. The structural design specified steel.
My builder had substituted two bolted 8x2 timber beams for the specified steel ridge, without telling me. The BCO instructed reinstatement by 13 May 2022. The steel ridge went back in and the roof over it was rebuilt, at the cost of about a week of delay. The ridge RSJ itself had been bought back in January (£570); the substitution meant it had sat unused.
That was the one the BCO caught. Here's the one he didn't, at least not in a way that required action.
The structural specification called for 75x195mm rafters. The builder used 50x170mm. My architect ran the numbers after the fact: both technically pass BS 5268-2. But the as-built deflection was 9.7mm against a limit of 10.1mm. That's 96% of the allowable deflection. The margin is essentially zero.
"Technically passes" and "safely passes" are different things. The building is standing. The rafters are fine in normal conditions. But they have consumed almost every millimetre of safety margin that the code provides, and that margin exists for a reason.
Tip
The roof membrane was a third substitution on the same project. The spec called for a particular breathable membrane (a warm roof requirement). The builder used a cheaper alternative. The result was persistent condensation and leaks that took over two months to diagnose. A lead and roofing specialist finally identified the membrane as the problem in December 2022.
Photograph every layer of the roof before the tiles go on. Membrane, battens, lead flashings, tile-to-window junctions. Once tiles cover it, you cannot see what's underneath without stripping them.
The Bifold Supplier Went Bust. A Credit Card Got Every Penny Back.
In April 2022, I ordered bifold doors and windows from a local bifold supplier, a £12,164 order. By May I had paid £10,340 across three payments, £200 of it on a credit card. By October, the company was unresponsive. Shortly after, they went into liquidation.
£10,340 at risk. The manufacturer could not deal with homeowners directly, only through their dealer network. The dealer was gone.
I raised a Section 75 claim with my card provider. Section 75 of the Consumer Credit Act 1974 makes your credit card provider jointly and severally liable for purchases between £100 and £30,000, even when only part of the price went on the card. The claim succeeded. £10,624 came back in January 2023, £284 more than I had paid out.
The replacement bifolds and windows came from a different supplier at £15,693 (including integrated blinds). With the Section 75 surplus taken off, the doors and windows cost £3,245 more than the original order would have. The insolvency's bigger cost was time: months without doors.
Four things would have reduced my exposure:
- Check Companies House before paying any deposit over £1,000. Look at the last filed accounts, the confirmation statement date, and any charges registered against the company. If accounts are overdue or the company has been struck off and restored, walk away.
- Pay by credit card, not debit card or bank transfer. Section 75 does not apply to debit cards. It does not apply to payments made through a third-party processor like PayPal (the card issuer and the supplier must be separate entities in a direct transaction). Use the credit card directly.
- Phase your payments to delivery milestones. Don't pay the full amount upfront. Tie payments to specific deliverables: deposit on order confirmation, balance on delivery and inspection.
- Have a backup supplier in mind. I had to find a replacement supplier in a hurry. If I'd already identified alternatives before ordering, the transition would have been faster and I might have negotiated a better price.
Warning
External resource
Companies House
Free company search. Check filing status, accounts, and registered charges before paying large deposits to any supplier.
find-and-update.company-information.service.gov.uk
External resource
Section 75 Guide (Which?)
Explains Section 75 credit card protection for purchases between £100 and £30,000, including what qualifies and how to claim.
which.co.uk
Nobody Digs the Trench

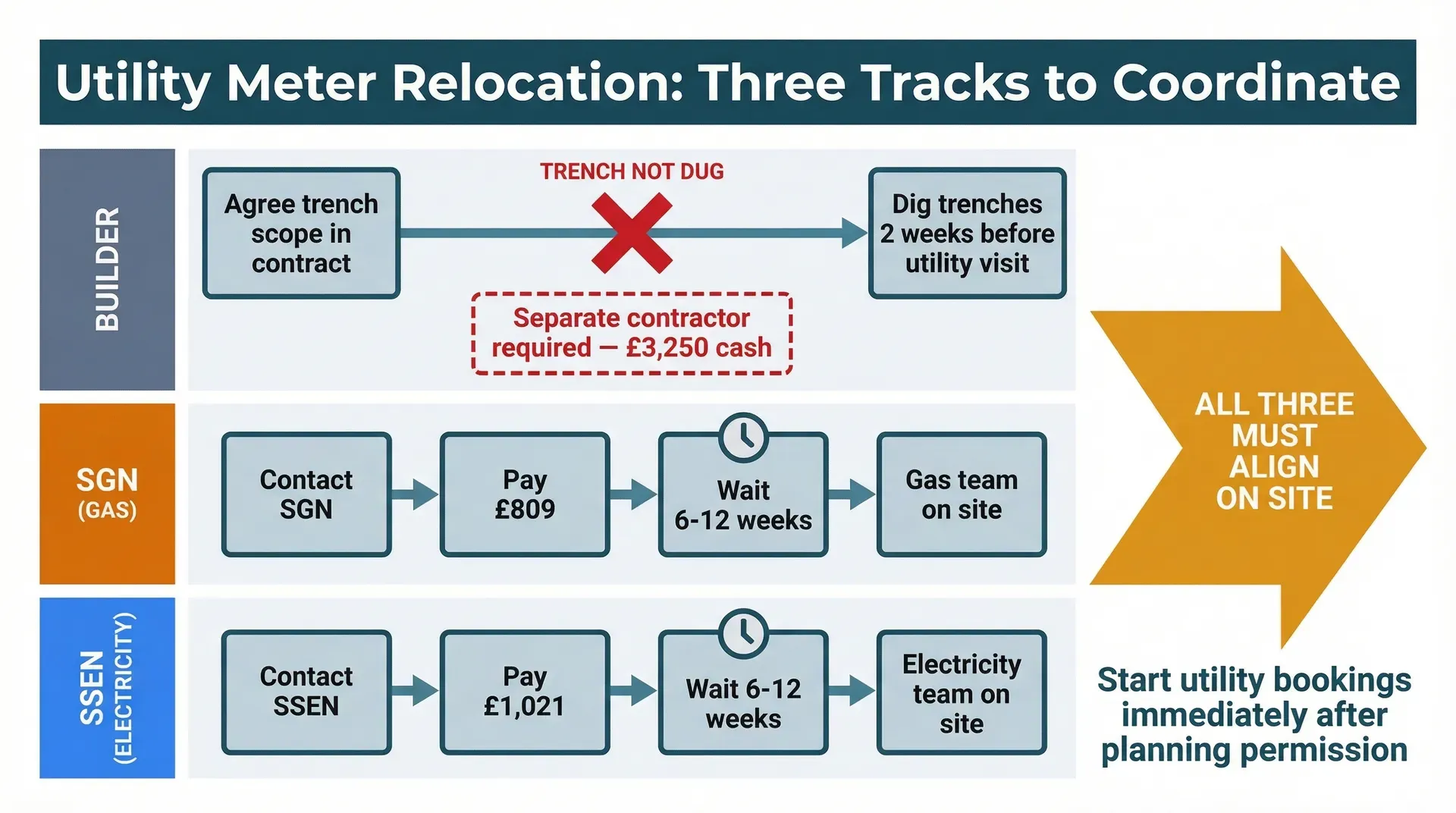

My builder agreed to dig the trenches for the gas and electric utility meter relocations. He never did.
By mid-2022, with the build well underway, I had to find a separate drainage contractor to dig the service trenches plus install a soakaway. That cost £3,250, most of it in cash. It was a job that should have been included in the builder's scope, written into the contract, and coordinated before the utility companies were booked.
The utility companies themselves (SGN for gas, SSEN for electricity) had their own lead times. SGN typically takes 6-12 weeks from payment to getting a team on site. SSEN was similar. I paid SGN £808.80 in June 2022 and SSEN £1,020.70, and both of those were service alterations: moving the gas pipe and the electricity cable. The SGN payment came back to me. A gas leak was found in the trench in July, SGN attended the same day and rerouted the pipe there and then, so the scheduled works were cancelled and refunded and the emergency reroute was invoiced at £856.67 in January 2023. One gas charge, slightly above the quote, not two. The meters on the end of the pipe and cable were moved by the suppliers on separate visits, and neither supplier charged for that.
During the gas trench dig, the contractor also discovered a gas leak. It may have been pre-existing or caused during the work. Either way, it added complexity and delay.
The lesson is blunt: write utility trench responsibility into the building contract with a specific deadline tied to the utility company booking. Don't assume verbal agreements hold. Contact utility companies as early as possible (ideally as soon as planning permission is granted) because their lead times are measured in months, not weeks.
Inspect Kitchen Deliveries Immediately. Not When the Fitter Arrives.
My kitchen was delivered in September 2022. The fitter didn't start until December. When he opened the boxes, the list of defects was painful: wrong shelf thickness, missing lights, wrong hardware, an upside-down handle, a wrong base unit, and a missing sink back panel.
A credit note and replacement order went back to the supplier in January 2023. The replacement parts arrived in February. Six weeks of delay because I didn't inspect the delivery on arrival.
German kitchens ship from the factory to the UK dealer to your house. Once the boxes are in your house, the clock on defect reporting starts. If you wait three months to open them, you're at the back of the replacement queue.
Open every box the day of delivery. Check every unit against the order list. Photograph anything that doesn't match. Report defects to your supplier within 48 hours. This is tedious. It takes a full day for a large kitchen. It saves you six weeks later.
The 14-Month Gap Between "Done" and "Signed Off"
My kitchen was near-complete in January 2023. Building control signed off in January 2024. Fourteen months between practical completion and the certificate that makes it legal.
The hold-up was certificates. Building control cannot issue a completion certificate without:
- An electrical test certificate (Part P)
- A Gas Safe certificate for the boiler
- Boiler commissioning records
My electrician provided his certificate promptly. My plumber did not provide his Gas Safe certificate for over a year. I chased. I waited. Eventually the Gas Safe Register started enforcement proceedings, and the certificate materialised.
This is not a minor administrative detail. Without a completion certificate, you may have problems selling the house, remortgaging, or making insurance claims on the extension. Your home insurer needs to know the work has been signed off.
Warning
The lesson: include a contract clause that ties final payment to receipt of all required certificates. If the plumber's last 10% is held until the Gas Safe certificate is in your hand, you will get it much faster than I did.
Winter Builds Need Active Drying Management
Screed went down in late November 2022. Plastering happened in November and December. Mist coats followed.
All of this in a half-finished building during an English winter, producing enormous amounts of moisture. The dehumidifier ran continuously. Drying was dramatically slower than expected.
You cannot paint on damp plaster. You cannot lay flooring on damp screed. Screed at 65mm thickness needs weeks to dry, even with a dehumidifier working hard. In winter, without adequate ventilation and heating, those weeks stretch into months.
If your build timeline puts wet trades (screed, plaster, mist coat) into the October-February window, budget for a commercial dehumidifier rental and a temporary heater. Factor at least four extra weeks into your schedule. The drying time is not something you can shortcut.
The Roof Needs Specialist Eyes Before the Scaffold Comes Down
Two separate roof problems on my build, both discovered after the roofer had finished and left.
First: the tile-to-window junction. The roofer didn't correctly cut tiles where they met the roof windows. The lead work was fine, but water got in through gaps between tile ends and the window frames. The same roofing specialist diagnosed the problem in October 2022 and installed expanding foam strips as a fix (£250 in labour). Simpler than re-tiling, but a problem that shouldn't have existed.
Second: the membrane. Already covered above. Cheaper membrane substituted for the specified breathable type, causing condensation that was initially misdiagnosed as a lead flashing issue.
Both problems would have been visible before the scaffold came down if someone who understood roofing had inspected the work at that point. My builder was not a roofing specialist. The roofer was his subcontractor, paid and gone.
Get an independent roofer or a building surveyor to inspect the roof before the scaffold is removed. It costs a few hundred pounds. Diagnosing and fixing roof problems from a cherry picker or by re-scaffolding costs thousands.
The Real Cost Per Square Metre
Industry sources in 2025-2026 cite £2,200-£3,300/m2 for extension construction costs. My build came in at roughly £2,221/m2 for construction only (excluding kitchen), based on a 55m2 footprint and £122,150 in construction costs.
That figure is from 2021-2022. Adjusted for today, it would sit comfortably within the current industry range. But the construction cost per square metre is a misleading metric for planning purposes, because it excludes the kitchen, the appliances, the worktops, and everything that makes the space usable.
The true all-in cost was closer to £3,308/m2. That is the number you need for realistic budgeting.
£3,308/m2
What I Would Do Differently

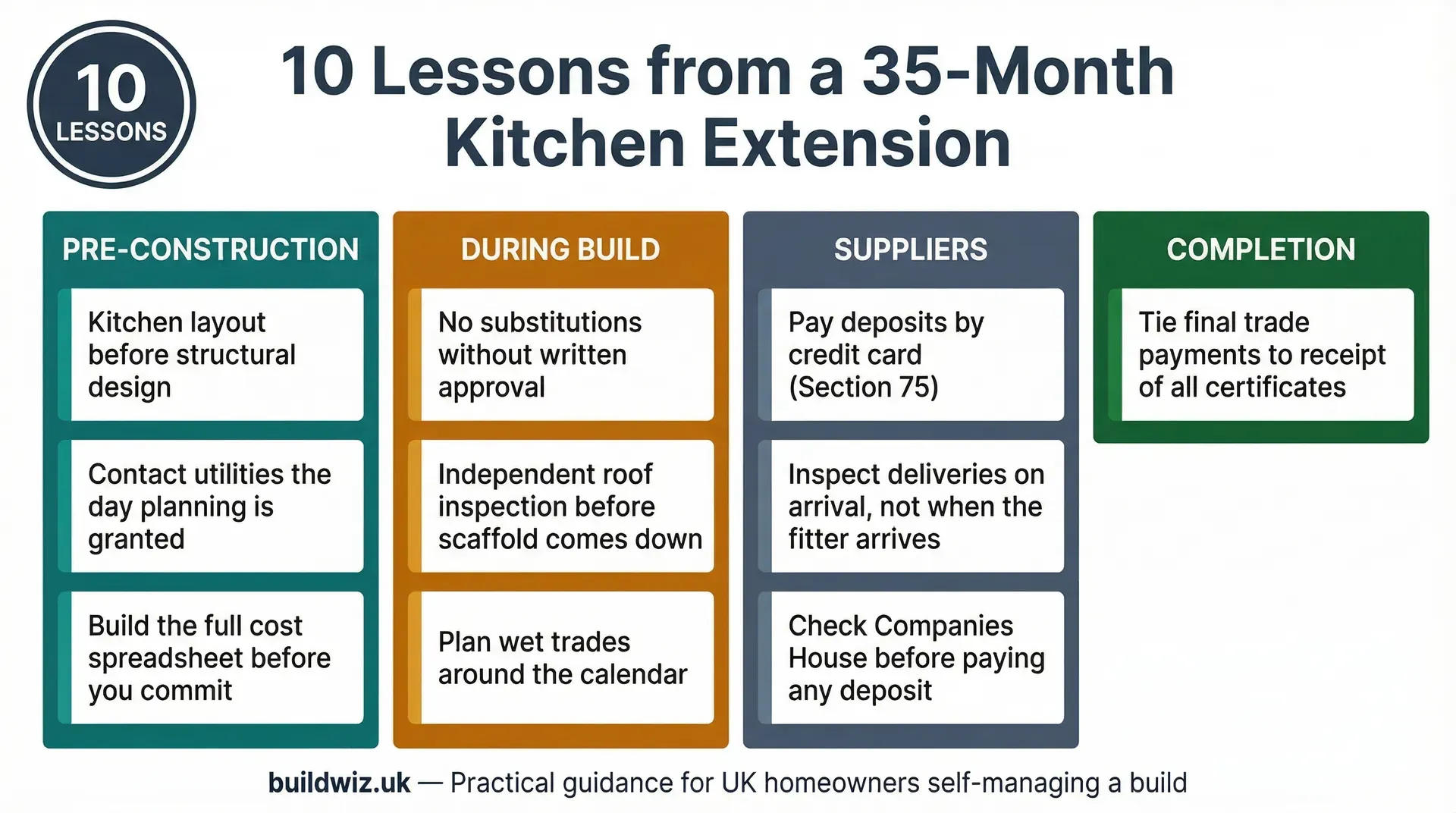

Ten things, in order of how much money they would have saved:
- Engage the kitchen designer before structural design. Saves the column removal redesign.
- Put every supplier deposit on a credit card. Section 75 returned £10,624. Without it, that money was gone.
- Write utility trench responsibility into the building contract. Would have saved £3,250 and weeks of coordination.
- Include a "no substitutions without written approval" clause. Would have prevented the timber ridge beam, the undersized rafters, and the wrong roof membrane.
- Inspect kitchen delivery on the day it arrives. Would have saved six weeks.
- Tie final trade payments to receipt of certificates. Would have cut the 14-month sign-off delay to weeks.
- Get an independent roof inspection before scaffold removal. Would have caught both the tile junction and the membrane problems early.
- Contact utility companies the day planning permission is granted. Their lead times are 6-12 weeks. Start the clock immediately.
- Budget for the true all-in cost, not the builder's quote. The builder's scope is 25-35% of the real number. Build the full spreadsheet before you commit.
- Plan wet trades around the calendar. Screed and plaster in November means drying through winter. Start four weeks earlier if possible.
Was It Worth It?
The kitchen is the best room in the house. The space is transformed. The 55m2 footprint changed how we live every day.
I don't regret doing the extension. I regret not knowing what I know now when I started. Most of these lessons are available nowhere in a single structured place. They're scattered across forum threads, magazine articles that gloss over the hard parts, and the bitter experience of people who've already made the mistakes.
That is why I built buildwiz.uk. Every lesson above maps to a specific node in the kitchen extension tree: planning, pre-construction, structure, first fix, kitchen design, second fix, completion. Each node tells you what to do, when to do it, and what goes wrong if you don't.
The builder's quote is not the cost. The timeline is not 12 weeks. And the knowledge gap between what you know and what you need to know is where the real money gets lost.
Close it before you start.
