buildwiz.uk

Gas and Electric Meter Relocation: UK Guide

Builders don't tell you about meter relocation. It's not exciting, it doesn't move bricks, and it looks like someone else's problem. So most homeowners find out about the lead time after groundwork has already started, which is precisely the wrong moment to discover it.

The gas and electric meters in your current kitchen or utility room will almost certainly need to move. The new extension footprint usually swallows the original external wall where they sit. Moving them isn't complicated. But each utility involves a network operator and a supplier's meter operator, working to their own schedules and charging their own rates, neither able to be hurried regardless of your build programme. Sequencing those two visits, and getting the trench dug in between, falls to you. The only lever you have is time. Use it early or lose it.

On one documented build, the gas service alteration was quoted at £809 and the electricity service alteration cost £1,021. Neither of those is a meter charge: they are what the networks charged to move the pipe and the cable. Moving the electricity meter itself was a separate visit by the energy supplier, and no charge for a meter move appears anywhere in the invoices. The gas job never ran as booked. A leak was found while the service trenches were being dug, the network attended the same day, and that emergency visit carried out the reroute the scheduled works had been booked to do. The scheduled works were cancelled and refunded, and the gas network charge actually paid was £857. Not because anyone was careless, exactly. Because the coordination of these things is harder than it looks, and nobody sets out the sequence upfront.

Gas Meter Relocation: The Process and What It Costs

Start with gas, because the process is less obvious.

Your energy supplier cannot deliver a major gas relocation on its own. They own the meter and the meter box, but they don't own the pipe in the ground. For any move greater than about one metre, you need to contact your Gas Distribution Network (GDN) as well as your supplier. The GDN owns the service pipe that runs from the gas main in the street into your property, and it is the only party allowed to reroute that pipe. The meter on the end of it stays the supplier's, so you need a job open with them too. Depending on the network, the meter is refitted by the supplier's meter operator (a Meter Asset Manager) on a second appointment with its own booking, or by the network itself for an extra charge, so confirm which before you book and ideally get both visits on the same day. Nobody lines those visits up for you. That third job is yours.

The four GDNs covering Great Britain are:

  • Cadent (North West, Midlands, East Anglia, North London)
  • Northern Gas Networks (North East and Yorkshire)
  • SGN (Southern Gas Networks) (South and South East England, Scotland)
  • Wales & West Utilities (South West England and Wales)

Call your energy supplier first. They'll redirect you to the right GDN, and unless the network is refitting the meter, you need a job open with them for the meter itself. Or check Cadent's and SGN's websites directly if you already know your region.

Warning

If your property is on a newer housing estate, you may be served by an Independent Gas Transporter (IGT) rather than one of the four main GDNs, and your electricity may come through an independent distribution network operator (IDNO) rather than the regional DNO. Independent networks set their own alteration charges and processes, so a quote can be far higher than the regional network's published rates. Check your bill or Cadent/SGN's postcode checker to confirm who operates your network before you assume you're getting a standard price.

What it costs

SGN's published rates for a standard domestic gas service alteration in Southern England (outside the M25) are £1,031 if SGN digs the trench, or £718 if you dig the trench yourself on your own private land. SGN's published alteration charges cover the pipe only and exclude any meter work, which is billed separately: SGN lists a meter refit charge of £132 where the meter itself needs repositioning. The SGN quote on one documented build came to £809 for the service alteration alone. That figure is consistent with a standard alteration in their South East territory. It is not what was paid in the end, though: that quote was later cancelled and refunded after an emergency callout did the same reroute, which is covered further down.

Cadent uses a standing charge plus a per-metre charge. At its current published rates, the East Midlands standing charge is £815, with £167 per metre of pipe (both including VAT). A seven-metre alteration in the East Midlands works out at roughly £1,982 if Cadent digs. If you dig your own trench on private land, Cadent takes 70% off the per-metre charge, which is a meaningful saving on longer runs.

The physical work takes one to two days. The waiting is the problem.

Cadent and Wales & West Utilities publish work windows that start after payment. SGN also arranges the date after payment. These windows exclude the time needed for enquiries, surveys, quotations and payment, and do not book the electricity DNO or supplier for you. Use 10–14 weeks from first contact as an initial planning allowance, then replace it with agreed provider dates. This is a planning estimate, not an operator service standard.

Who digs the trench?

This is where things get complicated, and where builds stall.

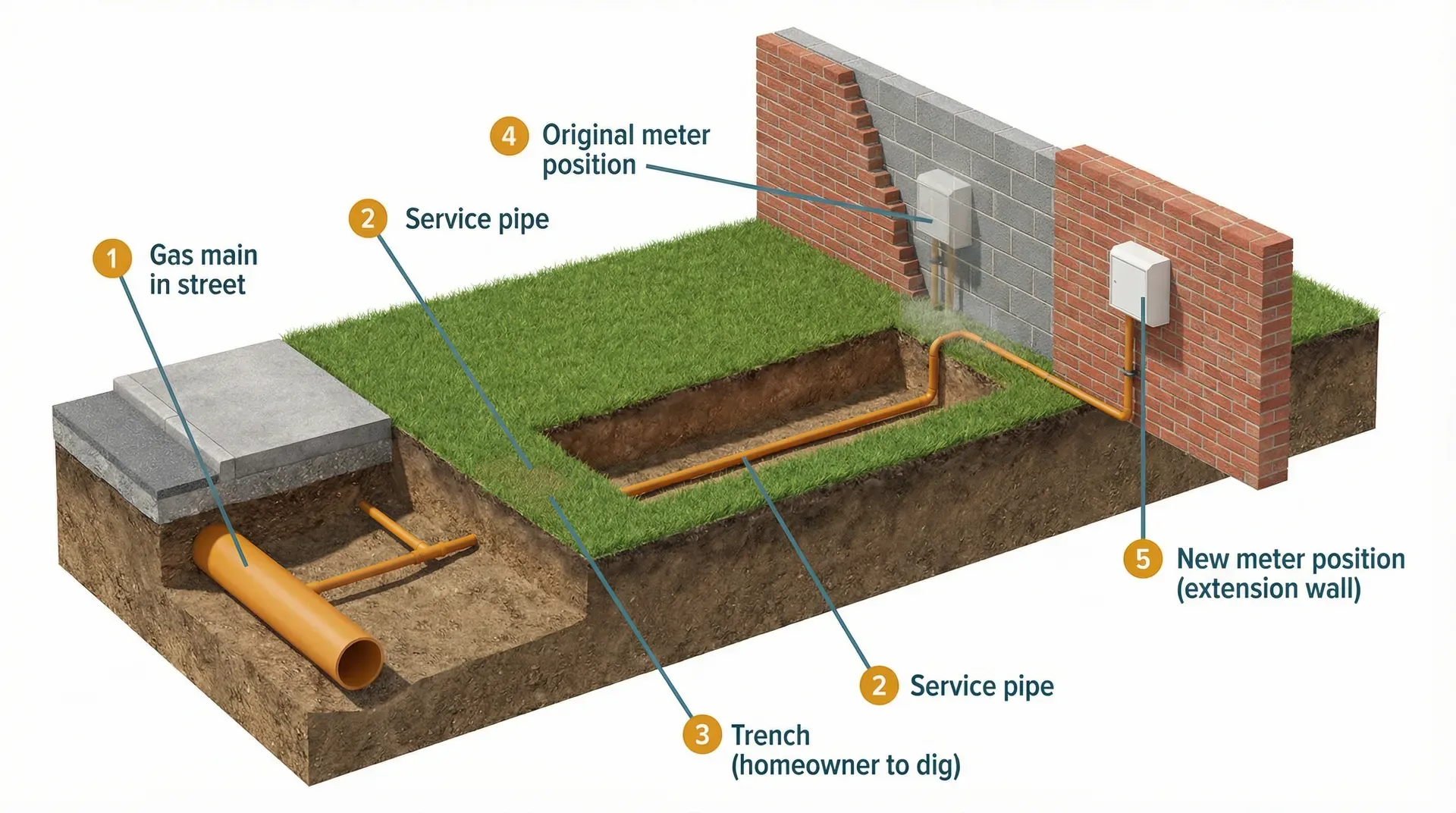

The GDN needs a clear service trench from the gas main connection point to the new meter position before they'll lay new pipework. Either they dig it, or you do. If you dig it yourself (or your groundwork contractor does), you save money. But you also take on responsibility for coordinating the excavation to be complete and ready when the GDN team shows up.

In my build, the original main contractor agreed to dig the service trenches. He never did. I ended up engaging a separate groundwork contractor eight months later to dig service trenches, install drainage, and handle the soakaway. That job cost £3,250, though it covered drainage work too, not just the meter trench. Some of that was directly tied to the meter relocation; some covered drainage work the original contractor had also failed to arrange. The point is: if the trench isn't dug when the GDN arrives, they leave. You go back to the end of the queue.

Get trench responsibility confirmed in writing before you book the GDN. If your builder agrees to dig the trench, write it into the scope of work with a specific completion date. Don't assume.

Electric Meter Relocation: The DNO Process

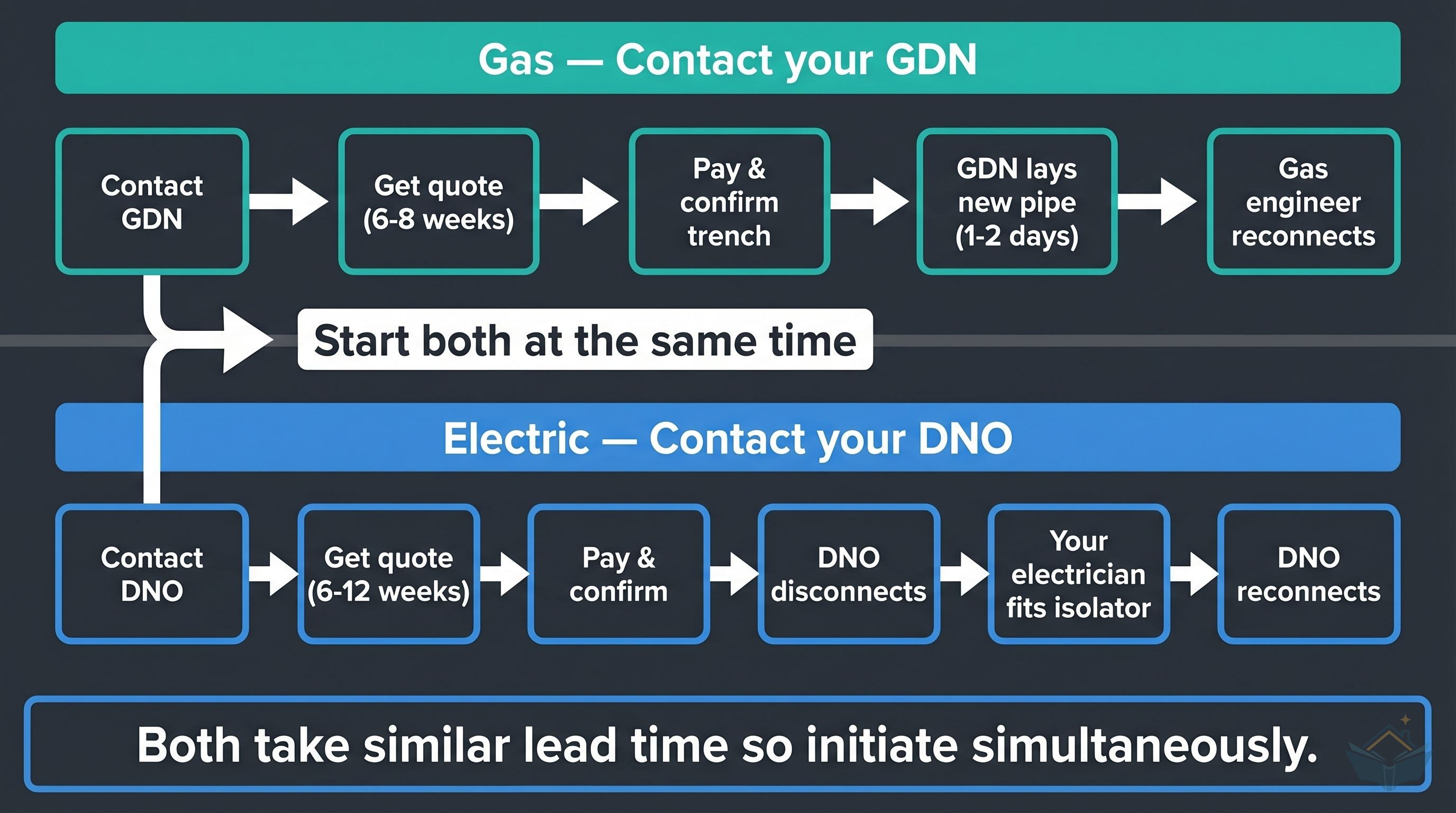

Electricity works differently from gas at the infrastructure level, but the homeowner experience is almost identical: wrong first contact, redirect, long wait.

Your energy supplier owns the electricity meter. But the cable feeding the meter from the street is owned by your Distribution Network Operator (DNO). The DNOs in Great Britain include National Grid Electricity Distribution (covering the Midlands, South West England and South Wales), UK Power Networks (South East, London, East Anglia), Electricity North West, Northern Powergrid, and SSEN (parts of South England and Scotland).

For any move of more than one metre, you contact your DNO directly as well as your supplier. The DNO reroutes the service cable and bills you for that work. Your supplier's meter operator moves the meter sitting on the end of it, as a separate appointment. Booking both and getting them in the right order is your job, not theirs.

The process runs: apply online to your DNO, receive a quote (SSEN says usually within 5 to 15 working days), accept and pay, a project manager contacts you within ten working days, works are scheduled. You must also arrange for an electrician to attend on the same day as the DNO, because the DNO reconnects the incoming supply cable but your electrician must handle the internal consumer unit reconnection.

On one documented build, the SSEN invoice for the electricity supply alteration came in at £1,021. SSEN's published base rate for an extended underground service alteration in England (outside London) is about £550 including VAT (£458 before VAT), before any digging on your land. The documented cost was higher, reflecting a longer cable run and the complexity of the supply alteration involved. Extended alterations requiring new cable runs regularly exceed the base published rates.

External resource

National Grid: Move My Electricity Supply

NGED (Midlands, South West England, South Wales) online application for electricity supply service alterations.

connections.nationalgrid.co.uk

External resource

SSEN: Moving Your Meter

SSEN (South of England and Scotland) process and current pricing for meter and supply moves.

ssen.co.uk

External resource

UK Power Networks: Moving Your Supply

UK Power Networks (South East, East Anglia, London) process for supply alterations.

ukpowernetworks.co.uk

When to Start This Process

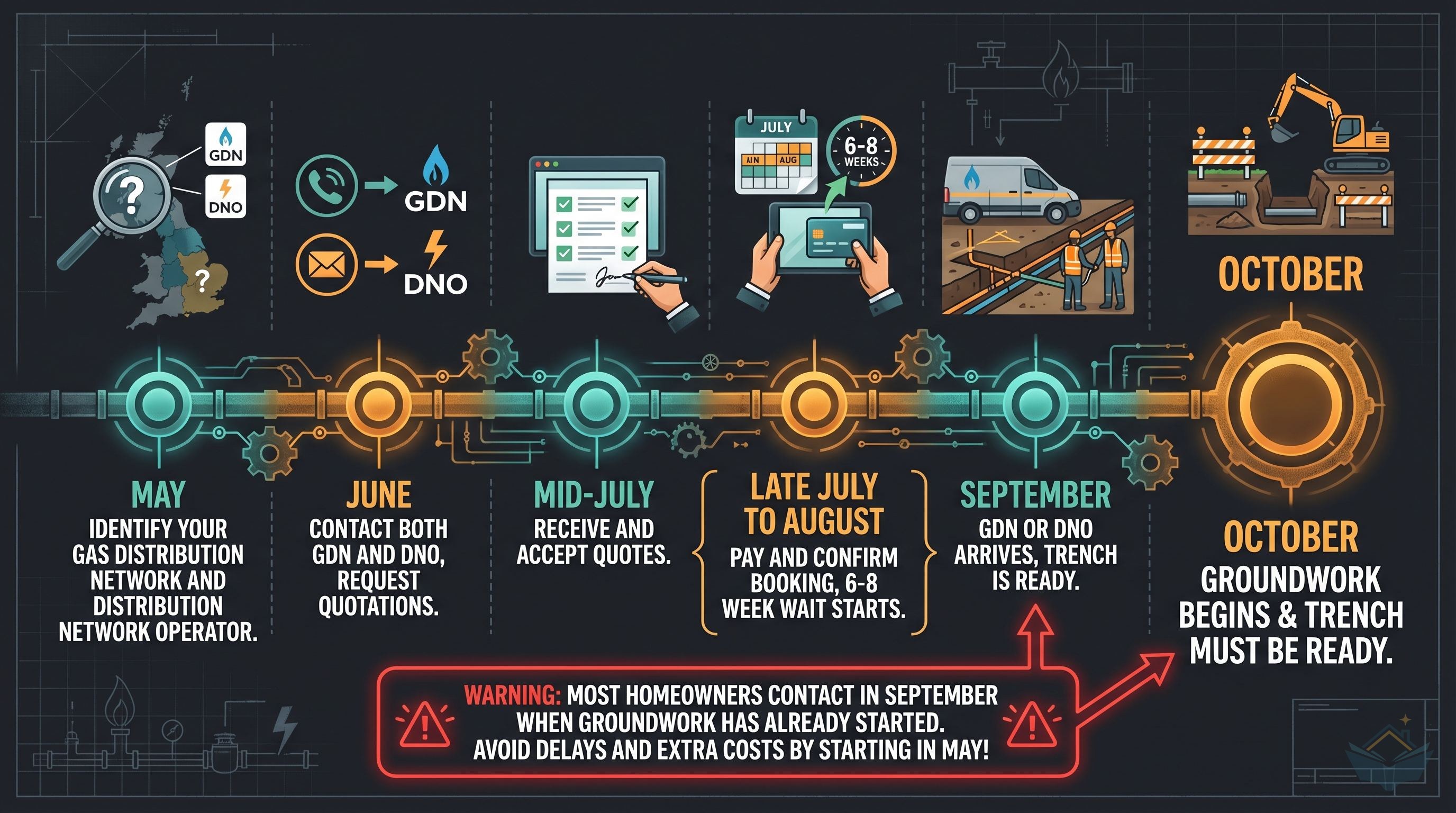

The right time to initiate both applications is at the pre-construction stage, before groundwork begins. In practice, this means once planning permission is granted and you have a confirmed builder start date. The utility meter relocation task guide shows where this sits in the pre-construction sequence, alongside drainage and site setup.

Build your meter relocation timeline backwards. If groundwork starts in October, you need the meters moved before the external walls go up (because the old meter positions are usually on the wall the extension swallows). That means works complete by, say, September. That means you need to have paid and booked by late July to allow for the network operator's confirmed post-payment works window. That means quotes accepted in mid-July. That means you need to have contacted both the GDN and DNO in June or earlier.

Most homeowners contact them in September, when groundwork has already started.

Initiate contact with your GDN and DNO at the same time you submit your building control application. You don't need final drawings. You need enough information to describe where the meter is now and where it needs to go.

Gas meter relocation (standard domestic)

£600 – £1,400

Electric meter relocation (DNO service alteration)

£300 – £1,600

What Happens When a Gas Pipe Gets Struck

This part doesn't appear in any guide to utility costs, but it should.

During groundwork on my extension, a gas leak was found while the service trenches were being dug. My groundwork contractor reported a gas leak, and SGN attended the same day. SGN attributed the leak to the builder and took his details. Whether it pre-dated the digging was never established. The emergency number is 0800 111 999. SGN sends an emergency crew, they isolate and repair the pipe.

It happened during the same trenching exercise that was supposed to prepare the ground for the meter relocation, and that is what changed the bill. The emergency crew rerouted the gas supply to its new position, which is exactly the job the scheduled alteration had been booked to do. The scheduled works were cancelled that same day, the £809 already paid in June 2022 was refunded, and the emergency reroute was charged at £857 when the invoice landed in January 2023.

So the gas network was paid £857 in total on that build, not that plus the original quote. Two things are worth taking from it. The quote is not necessarily the amount you end up paying, and an excavation find can pull the network's work forward whether you planned it that way or not.

Under Pipelines Safety Regulations 1996 Regulation 15, causing damage to a pipeline that creates a dangerous situation is a criminal offence. The liability sits with the contractor whose excavation caused the strike. The GDN (SGN in this case) will recharge all repair and emergency response costs. Your contractor's public liability insurance should cover it, but confirm this explicitly before they dig. The HSE has prosecuted contractors for striking gas pipes on domestic projects and continuing to work afterwards.

The precaution is simple and often skipped: before any mechanical excavation within 500mm of a marked gas service pipe, switch to hand digging. The network operator will provide maps of their services free of charge. Get them. Give them to your groundwork contractor before they start.

Warning

Your builder's public liability insurance must specifically cover excavation work. A standard PL policy sometimes excludes excavation activities or requires the contractor to have obtained utility service maps before digging. Confirm this with your contractor before groundwork starts, and ask to see the relevant section of their policy. If they strike a gas pipe and they're not properly insured, the financial exposure falls to you.

The Full Cost Picture

The headline network charges (gas and electric service alterations) typically come to roughly £900-£3,000 between them for a domestic extension, depending on region and run length (the two ranges above combined). That is what the networks charge to move the pipe and the cable. The meter move itself is a separate line, billed by your supplier or the network, and on this build no meter charge appeared at all. But the real cost of poor coordination is higher than any of it.

On one documented build, the complete utility-related cost broke down like this:

  • Gas service alteration (SGN): £857, charged as an emergency reroute after the leak was found in the trench. The scheduled job had been quoted at £809 and was cancelled and refunded, so this is one charge and not two
  • Electricity service alteration (SSEN): £1,021
  • Moving the electricity meter itself (energy supplier): no charge appears in the invoices
  • Groundwork contractor for service trenches (bundled with drainage): £3,250

That last figure covered more than meter-related work: drainage and a soakaway that the main contractor never delivered. But the engagement would have been smaller or unnecessary if the service trenches had been dug as agreed eight months earlier.

Utility coordination done badly isn't just an inconvenience. It's several thousand pounds you hadn't budgeted for.

Meter Relocation Action Plan

Use this sequence for every extension:

1. Identify your GDN and DNO. Check your gas bill for the network operator, or use the Cadent/SGN postcode lookup. Check your electricity bill for the DNO, or use the Energy Networks Association postcode checker.

2. Contact both simultaneously. Don't do gas first and electricity second. Both have similar lead times. Start them in parallel.

3. Get written quotes. GDNs and DNOs provide written quotes before you pay. Read them. Specifically check: does the quote include trench digging, or is that your responsibility?

4. Confirm trench responsibility in your builder's scope. If the trench is the builder's job, write it into the contract with a completion date before the GDN/DNO arrival. Do not accept a verbal agreement.

5. Pay and book before groundwork starts. Not during. Not after. Before.

6. Get utility service maps before any excavation. Call your GDN and request maps of all gas services in the area before groundwork begins. Give them to your groundwork contractor. Require hand digging within 500mm of any marked service.

7. Confirm your contractor's PL insurance covers excavation work. Do this before the digger arrives on site.

The process isn't difficult. The lead times are what catch people. Start early, confirm responsibilities in writing, and the meter relocation will happen in the background while you're dealing with everything else on your pre-construction list.

Meter relocation is one of several long-lead items that need starting months before anyone digs. The kitchen extension stages guide shows where each of them falls against the rest of the build.

External resource

SGN: Alter Your Gas Connection

SGN (Scotland and South of England) online application and current pricing for domestic gas service alterations.

sgn.co.uk

External resource

Cadent: Gas Alterations

Cadent (North West, Midlands, East Anglia, North London) indicative pricing tool and application for domestic gas alterations.

cadentgas.com

External resource

Citizens Advice: Move Your Gas or Electricity Meter

Clear overview of the legal framework: what your supplier can do vs what the GDN/DNO must do, and your rights if an appointment is missed.

citizensadvice.org.uk

General guidance for homeowners in England (and Wales where we say so), not professional advice. Every site is different: check anything that affects your build with a qualified professional, your local council or building control. Terms
