- Blinding Concrete: The 50mm Layer That Halves Your Reinforcement Cover
Blinding Concrete: The 50mm Layer That Halves Your Reinforcement Cover

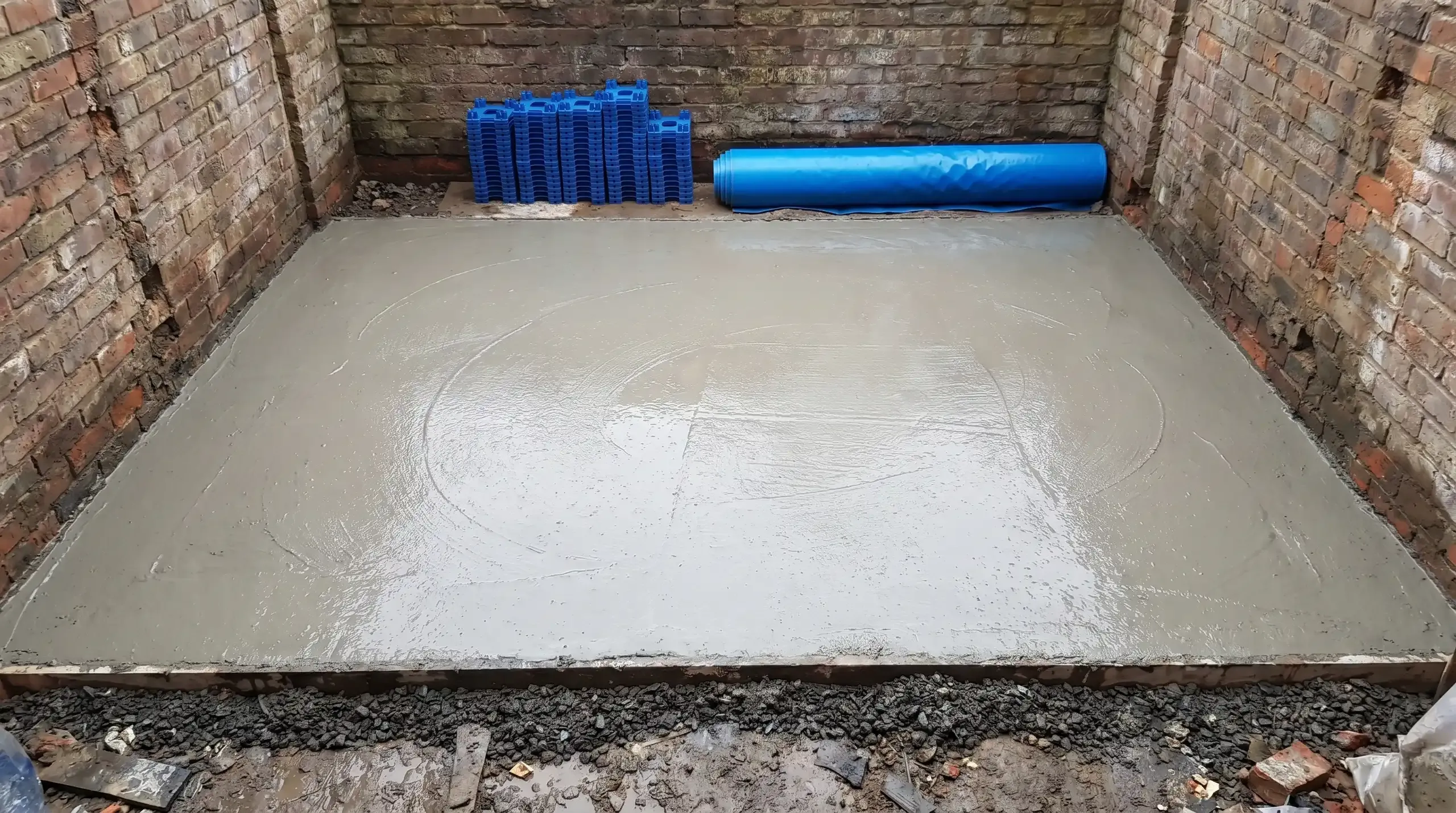

C8/10 GEN 1 blinding concrete costs £96 – £138 per m³. A working layer that turns a hardcore subbase into a working surface and cuts cover from 75mm to 40mm.
By Ian
Project managed a £182k Oxfordshire kitchen extension
Blinding concrete is easy to dismiss because it is thin, weak, and not structural. Where reinforcement is cast against it, though, it is what lets the engineer design for 40 mm of cover under the steel instead of the 75 mm needed against bare ground. Leave it out where the design assumes it and the slab no longer matches the drawings, which can mean a redesign or a re-pour.
Most homeowners have never heard of it. It is the cheap working surface that stops expensive problems before the main concrete goes in, and on the slabs that need it, blinding is the difference between passing first-time and re-pouring a floor.
What blinding concrete is
Blinding is a thin layer of weak concrete, at the specified thickness, poured over compacted hardcore (or directly onto excavated ground) to create a clean, level surface for whatever goes on top. It's not load-bearing in any structural sense. It's a working platform.
The standard grade is C8/10 GEN 1 under BS 8500 (the British Standard for specifying concrete). The "C8/10" tells you the minimum compressive strength: 8 N/mm² when tested as a cylinder, 10 N/mm² as a cube. That's roughly a third of the strength of a foundation concrete, which is exactly the point. Blinding is meant to be cheap, easy to place, and just rigid enough to walk on the next day.
Warning
C8/10 is GEN 1, not GEN 0. A surprising number of online sources, including some merchant websites, conflate the two. GEN 0 is the next grade down (C6/8) and is rarely specified for domestic blinding. When you phone a ready-mix supplier, ask for "C8/10 GEN 1, 20mm aggregate, S3 consistence". If they offer GEN 0, ask whether your structural engineer accepts it. Most don't.
You'll hear it called by several names depending on who's talking. The merchant calls it "C10". The structural engineer writes "GEN 1" on the drawing. Old-school builders call it "lean mix". Some sites just call the layer "the blinding". They all mean the same thing.
Sand blinding vs concrete blinding
Two materials carry the name "blinding". They do related but distinct jobs.
Sand blinding is a 50mm layer of sharp sand (also called grit sand or concreting sand, never building sand) laid over compacted hardcore. Its job is to fill the gaps between stones and provide a smooth bedding surface for a polythene damp proof membrane that goes on top. Without it, sharp edges on the hardcore puncture the membrane.
Concrete blinding is a thin layer of concrete to the specified mix and thickness poured over the hardcore. It does the membrane-protection job too, but more importantly it gives you a rigid, flat working surface for placing reinforcement chairs, formwork, or insulation boards on top.
The decision between them matters. For a domestic extension slab the rule is straightforward:
| Situation | Sand blinding | Concrete blinding |
|---|---|---|
| Plain (unreinforced) slab over compacted hardcore | Sufficient | Not needed |
| Reinforced slab, insulation laid on the DPM below the slab (most extension floors) | Sufficient (chairs stand on the insulation) | Not needed unless the engineer specifies it |
| Reinforced slab with the mesh chaired directly on the blinding (no insulation below the slab) | Not adequate (chairs sink) | Required |
| Hardcore is irregular or has voids that could let fines escape | Marginal (DPM puncture risk) | Confirm base preparation and blinding with the designer |
| Heavily loaded slab (garage, workshop) | Not adequate | Required |
| Speed matters and there is no reinforcement | Quicker, no curing time | Adds 24 hours to programme |
The community forums get this wrong constantly. BuildHub threads cycle through the same debate every few months: do I need concrete blinding or is sand fine? The answer comes down to one question. What will the reinforcement chairs (the small plastic or steel supports that hold the mesh at the correct height) stand on? On most insulated extension floors the build-up is hardcore, sand blinding, DPM, insulation, then the reinforced slab, so the chairs stand on the insulation and 50mm of sharp sand under the DPM does the job. If the mesh is chaired directly on the blinding, with no insulation under the slab (insulation laid above the slab, or an uninsulated garage or outbuilding floor), you need concrete blinding. Chairs on sand sink under the weight of a worker placing the mesh. By the time the structural concrete arrives, the chairs have settled, the mesh is too low, and the cover is wrong.
Why the cover-reduction matters
This is the technical reason a reinforced slab or footing cast straight onto soil needs far more cover than one cast on blinding, and it's almost entirely missing from homeowner-facing content.
Concrete cover is the depth of concrete between the outside face of the slab and the steel reinforcement inside. Cover protects the steel from corrosion (which would split the concrete from inside), gives it bond to develop strength, and provides fire resistance. Get cover wrong and the slab has reduced design life, possibly catastrophically reduced. BS 8500 sets cover for durability, and Eurocode 2 (BS EN 1992-1-1, clause 4.4.1.3(4)) sets a minimum according to the surface the concrete is cast against.
For concrete cast directly against soil, that minimum is 75 mm of cover. That's a thick chunk of concrete protecting the rebar.

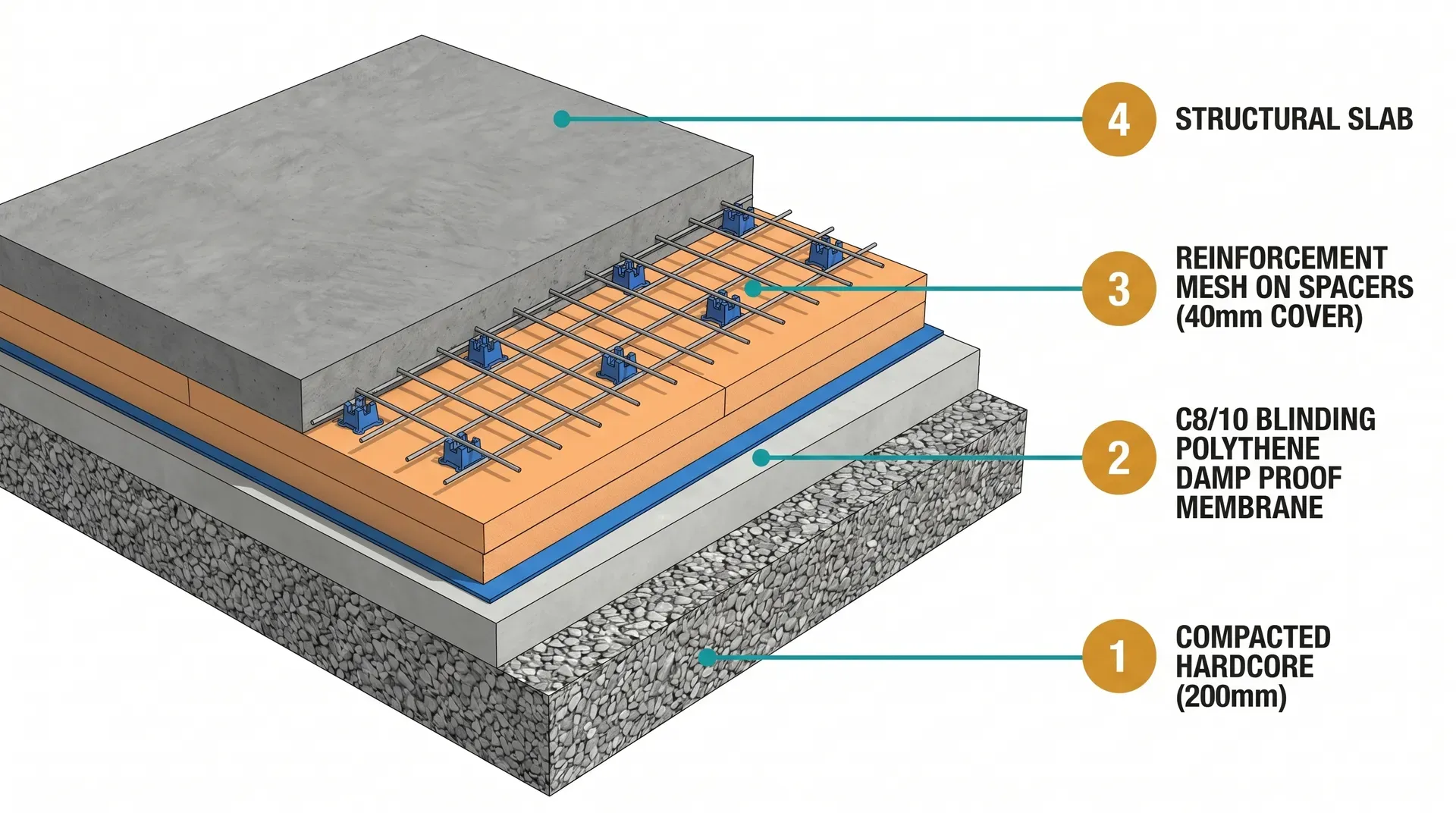

For concrete cast on prepared ground, including blinding, the minimum drops to 40 mm, because the surface under the steel is flat and predictable.
75mm to 40mm
That 35mm difference matters in two ways. It saves concrete on every cubic metre of slab. More importantly, it makes the cover achievable on site. Holding 75mm of cover over a lumpy hardcore surface is genuinely difficult. Holding 40mm over a flat blinding layer with castle spacers is straightforward.
The structural engineer's calculation assumes 40mm cover. That assumption only holds if the blinding or other prepared base is in place. Skip it and the engineer's design no longer matches what you've built.
How thick should it be
Use the thickness on the project specification. The Concrete Society’s guidance on blinding gives a typical depth of 50-100mm. That is guidance, not a universal minimum or maximum for every site.
The same guidance distinguishes ordinary working-platform blinding from blinding designed as an additional protective measure (APM4) against sulfate attack. For APM4 it describes at least 50mm of concrete with the same quality as the foundation. Have the designer specify whether that function is needed and the required mix; ordinary weak blinding is not automatically suitable.
For volume calculation, multiply your slab footprint by the layer thickness. A 30m² rear extension at 75mm of blinding needs 30 x 0.075 = 2.25m³. Round up to 2.5m³ to allow for the hardcore eating some of the depth on the high spots.
Blinding is one layer of several under a ground-bearing floor. The Floor Build-Up and Oversite Estimator works out the hardcore, DPM, insulation and slab concrete for the same footprint. It assumes 50mm of sand blinding, the normal choice under an insulated slab, so if your slab needs concrete blinding, swap that line for the volume you worked out above.
Interactive calculator
Floor Build-Up and Oversite Estimator
Estimate the hardcore, sand blinding, DPM, PIR insulation, and concrete you need for a ground-bearing extension floor, by floor area and layer depths, with an all-in cost.
Where blinding fits in the build sequence
There's a fixed order to the work between excavation and the structural slab pour, and it matters because building control inspects parts of it and the rest cascades from those inspections.
Before the first spade goes in, check the boundary. If your excavation will come within 3 metres of a neighbour's building and go deeper than the bottom of their foundations, or within 6 metres and cut below a line drawn down at 45 degrees from the bottom of their foundations, the Party Wall Act requires you to serve notice first. Factor a party wall agreement into the programme well before the dig, because the notice periods run into weeks.

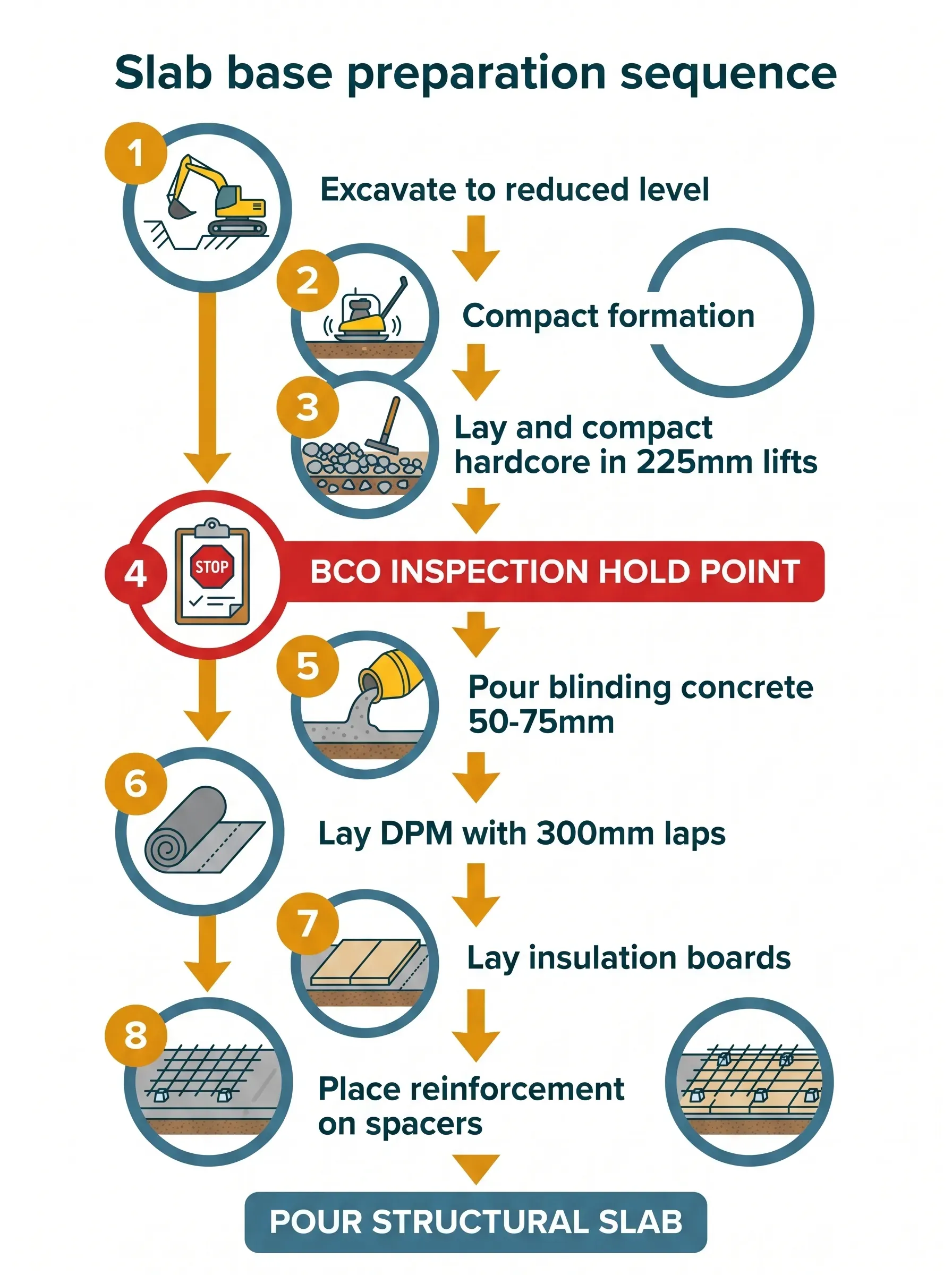

- Excavate to the reduced level specified on the drawings, accounting for slab thickness, insulation, hardcore, and blinding.
- Compact the formation (the natural ground at the bottom of the excavation) using a wacker plate. Soft spots get dug deeper and re-filled.
- Lay and compact hardcore in lifts no thicker than 225mm before each pass of the compactor. Deeper lifts cannot compact fully and leave voids.
- Building control inspection of the formation, hardcore, and oversite preparation. The BCO has 24 hours' notice from your builder and they verify subbase suitability before anything goes on top.
- Pour blinding (concrete or sand depending on what the slab requires).
- Lay DPM with 300mm laps and 150mm turn-up at perimeter walls onto the wall DPC.
- Lay insulation (typically 100-150mm of PIR for Part L compliance) directly on the DPM.

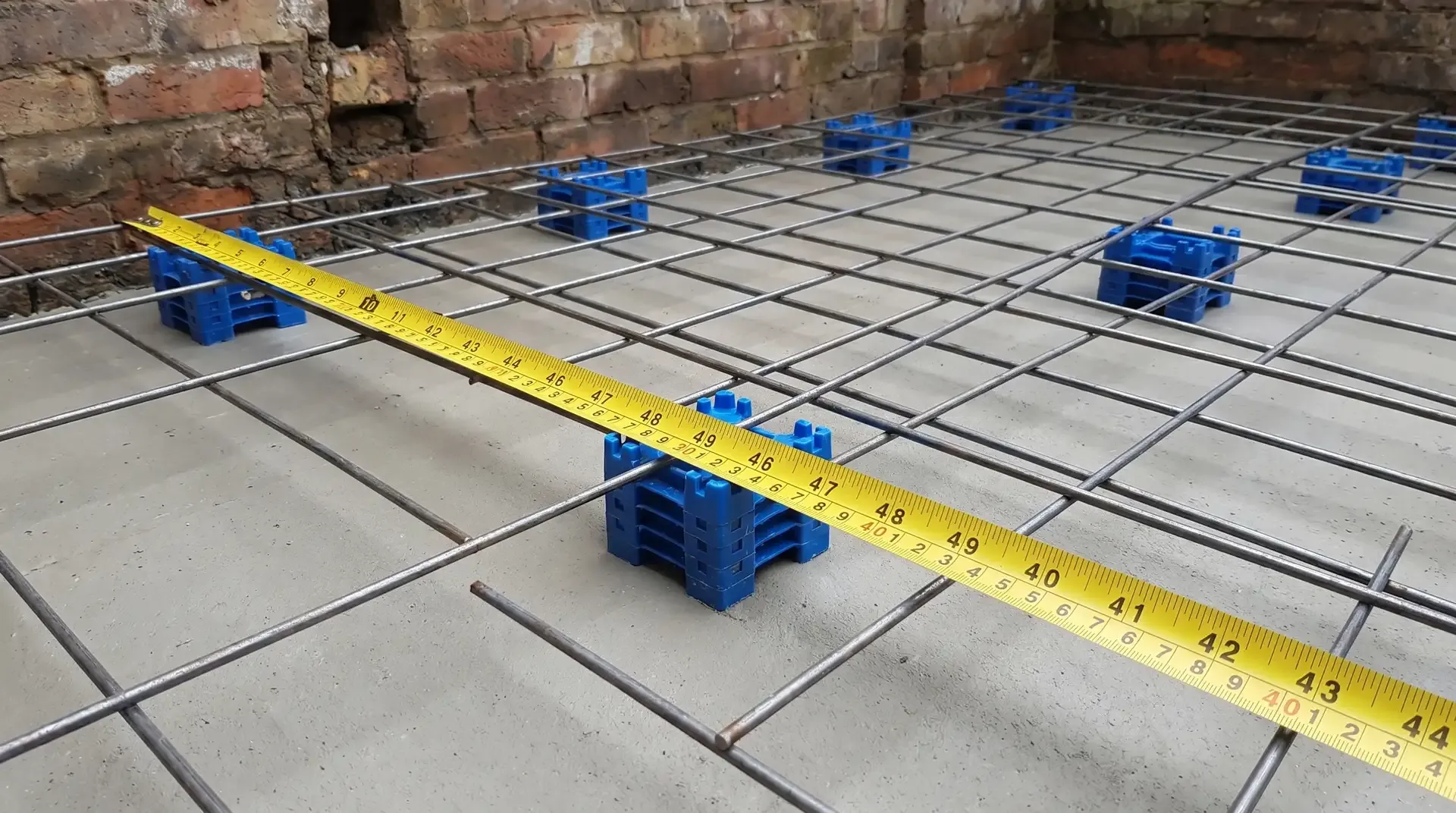

- Position reinforcement on castle spacers achieving the engineer's specified cover.
- Pour structural slab in a continuous operation.
The blinding sits between two hold-points: the BCO inspection of the oversite is the hard stop before it goes down, and the DPM lays directly on top of it. Skip the BCO inspection and pour the blinding too soon and you're at risk of being told to dig out and start again. Pour the blinding when it's raining and you'll have standing water under your DPM.
How to order it
Blinding concrete is ordered the same way as any other ready-mix grade, with one wrinkle: the volumes are usually small enough to trigger a short-load surcharge.
The ordering specification, written out in full, is: GEN 1 designated concrete to BS 8500-1, strength class C8/10, S3 consistence, 20mm maximum aggregate. You don't need to recite all of that on the phone. "C8/10 GEN 1, 20mm agg, S3" gets you there. S3 consistence is the slump class, meaning a wet, easily workable mix. For blinding you want it wet enough to flow and self-level rather than needing aggressive screeding.
Most ready-mix plants run a 6m³ standard barrel truck. A typical blinding pour for a 30m² extension is 2-3m³, well below the standard threshold. You have three options.
Option 1: Standard ready-mix with short-load surcharge
Order from a national supplier (Tarmac, Hanson, Cemex, Breedon) or a regional plant via your builders' merchant. The truck arrives with your 2-3m³, you discharge in 20 minutes, and you pay a short-load surcharge on top.
C8/10 GEN 1 blinding (national average)
£96 – £138
Short-load surcharge (under 4-5m³)
£40 – £150
For a 2.5m³ pour at the national average rate shown above, expect to pay roughly 2.5 times the per-m³ figure for the concrete itself, plus the short-load surcharge listed alongside. London and the South East run noticeably higher per m³ across the board. Some suppliers (Mister Concrete is a known case) impose a flat minimum charge regardless of volume, which makes them poor value for blinding pours specifically.
Option 2: Volumetric mixer
A volumetric truck carries cement, aggregate, and water separately and mixes on site as the chute runs. You pay only for what's dispensed. There's no minimum order, no short-load surcharge, and no 90-minute clock running from batching to discharge.
The per-m³ price is typically 20-35% higher than the standard ready-mix rate shown above. For a 2.5m³ blinding pour, the maths often comes out roughly even with a short-load standard delivery, with the volumetric option giving you no waste risk and unlimited time on site. Bell Concrete, Base Concrete, and a long list of regional volumetric specialists run these trucks across the UK.
For any blinding pour under 3m³, get a quote from both. Volumetric usually wins.
Option 3: Site-mixed from bags
Possible for very small pours (under 0.5m³) but rarely worth it. Site-mixing 1m³ of C8/10 needs around 7-8 bags of cement at £6.50 – £8.50 each (C8/10 GEN 1 uses only 180kg of cement per m³, which is why it's called a lean mix), plus about 2 tonnes of all-in ballast, plus a hire mixer at £20 – £40 per day. The labour-hours and quality risk push it out of contention against ready-mix delivered. Reserve it for a tiny isolated pour (a 0.2m³ mass-fill behind a manhole, say) where ordering a truck doesn't make sense.
Tip
For any blinding pour between 0.5 and 4m³, phone two volumetric suppliers and one standard ready-mix plant. Compare the all-in delivered price including any minimum charges and surcharges. Volumetric wins on small pours nine times out of ten and removes the time pressure entirely.
How to place it properly
Blinding is the easiest concrete pour you'll ever attend. It's also the one that gets done sloppily because nobody treats it as important. Three things matter on the day.
The base must be clean and damp, not wet. Sweep the hardcore free of loose stones, dust, and debris. Lightly damp it down with a hose if the weather has been hot and dry, because bone-dry hardcore sucks moisture out of the mix and makes it crumbly at the bottom. Standing water is the opposite problem. Do not pour blinding onto a puddled surface; the water dilutes the concrete locally and creates weak spots. If it has rained the night before, mop out any standing water before the truck arrives.
The level matters more than the strength. Blinding's whole purpose is providing a flat surface for the next layer. Spread the concrete with a rake, then strike it off with a screed board (a straight piece of timber dragged across two pre-set rails). For an extension footprint with no specific gradient, set up two parallel timber rails at the desired blinding height, fill between them, and screed off. Do not power-float blinding; a basic tamped finish is correct because you actually want some surface texture for the next layer to bond against.
Don't bother curing it. Blinding doesn't need 28-day strength to do its job. By the next morning it'll be hard enough to walk on, place chairs on, and lay DPM over. If the weather is hot and windy, drape it with polythene overnight to slow surface drying, but otherwise just leave it alone.
You don't need a power float, a vibrating poker, or any of the kit that goes with a structural slab pour. Two people with rakes, a screed board, and a bull float (or just a piece of straight timber) can place 2-3m³ of blinding in 30-40 minutes.
Cold weather
Don't pour blinding when air temperature is below 5°C or when frost is forecast within 24 hours. The concrete won't reach the strength it needs to support DPM laying within the next day or two, and the surface can spall. Above 8°C is fine. Between 5 and 8°C, cover with insulating blankets after pouring and accept a slower programme.
What about not using blinding at all
This comes up on every BuildHub thread and the answer is "depends on what's going on top".
For a plain ground-bearing slab, a designer may specify sand blinding over compacted hardcore to protect the DPM. Follow that floor build-up; this guide does not certify compliance with a particular NHBC clause.
Reinforced slab with insulation laid on the DPM underneath it, the usual extension build-up. Sand blinding under the DPM is normal here, because the mesh chairs stand on the insulation, not on the blinding. Follow the engineer's drawing if it says otherwise.
Reinforced slab with A142, A193, or A252 mesh chaired directly on the blinding, with no insulation under the slab. You need concrete blinding. There is no safe shortcut here. Castle spacers on sand will sink. Mesh laid directly on hardcore will rest on high stones and miss its design height. The cover requirement set by your engineer cannot reliably be met without a blinding layer.
Contaminated, sulfate-rich or made-up ground needs a site-specific design. Do not assume it automatically calls for an APM blinding layer, or that adding one resolves every ground risk. See the protective-blinding distinction above.
Trench-fill or strip foundation. Where the engineer specifies blinding to provide a working surface, follow the specified thickness and mix, including any protective requirements.
What to check on delivery and afterwards
The driver hands you a delivery ticket. For blinding, three things on it matter.
The grade should read C8/10 GEN 1 or some clear equivalent (some tickets just say "C10", the cube strength of the same C8/10 mix; there is no "C10/12" strength class). If the ticket says GEN 0 and your engineer specified GEN 1, refuse the load. The cost of refusing wrong concrete is much smaller than the cost of pouring it.
The batch time should be within 90 minutes of arrival on site, the standard window for ready-mix to retain workability. Volumetric deliveries don't have this issue, because the mix is fresh by definition.
The plant should hold QSRMC or BSI Kitemark certification, indicated on the ticket. This is the third-party quality verification that building control inspectors look for. Your delivery ticket is your evidence the concrete met spec.
Keep the ticket. Building control don't always ask, but when they do, having no record is a problem you don't need.
After the pour, the surface should be flat to within 5-10mm under a 2m straightedge. Anywhere that exceeds this needs to be levelled before the next layer goes on, either by skimming additional concrete, sanding back high spots, or accepting a thicker DPM packing layer.
Common mistakes
Pouring before the BCO has inspected the hardcore. Building control inspect the oversite preparation specifically. Concrete poured before they've seen the hardcore can be ordered out, exposing whatever is underneath. The inspection takes 15-30 minutes and costs nothing extra. Do not let your builder skip it to save half a day.
Using GEN 0 instead of GEN 1. Some suppliers will offer GEN 0 (C6/8) as a cheaper alternative for "non-structural blinding". Most structural engineers won't accept it for a slab they've designed. Check the engineer's drawings and specify what's there.
Ordering a different thickness from the design. Calculate the volume from the specified layer and check changes with the designer. Do not reduce a specified protective layer to save concrete, or assume that a 100mm layer is always unnecessary.
Building sand instead of sharp sand for sand blinding. Building sand is too fine, clumps when damp, and washes out under groundwater. Every BuildHub thread on the topic carries this warning. If you're doing sand blinding, ask for sharp sand (also sold as grit sand or 0-4mm washed concreting sand). Building sand is for mortar above DPC, not for blinding.
Pouring blinding onto frozen hardcore. Frozen ground reflects pour temperature, the concrete sets uneven, and the surface flakes off the next day. If frost is forecast, postpone.
Letting the truck dump and leaving the screed for later. Blinding wants screeding while it's still wet. Once it starts to stiffen, levelling becomes harder and the surface ends up rough. Two people on the screed board, working from one end to the other immediately as the concrete is placed, gives you a clean platform.
Where you'll need this
- Foundations and footings: blinding to the bottom of trenches before placing rebar cages, where specified by the structural engineer.
- Building control inspection: drainage and oversite: the BCO inspects the hardcore and oversite preparation before any blinding is poured. The inspection is a hard stop in the build sequence.
- Damp proof course: DPM lays directly on the blinding layer, with a 150mm turn-up onto the wall DPC at the perimeter.
- Walls and blockwork: first course of blocks bears on the foundation strip; blinding to the trench base is the platform that sets the rebar cage at correct cover.
These tasks appear in the groundwork stage of any extension or renovation project that involves a reinforced floor slab or trench foundations, not just extensions. The cover-reduction story applies wherever Eurocode 2 design rules are used: a side return, a garden room with a structural raft, a garage conversion with a new floor, or a basement build will all run the same calculation.
