Your Extension Specification Schedule: What to Choose and Order Before First Fix

Build a specification schedule for a rear extension: PC and provisional sums, long-lead items, order-by dates and the Part L glazing allowance before you order.

8 min read6-10 hours of decisions, supplier questions and building the scheduleUpdated 2026Free with email

An extension can stall halfway without anything going wrong with the building. It stalls on a decision. The doors can't be made because nobody signed off the sizes, and the tiler is booked while the tiles are still a shortlist.

A builder can only order what you've chosen. Anything you haven't chosen either stops the trade waiting for it or comes back later as a variation, priced at a point when you can't shop around.

The builder needs your product choices to price the work and plan when to order it, and most quotes leave the finishes as prime cost or provisional sums until you choose. The choices are yours. Unless the contract says otherwise, so are the deadlines. The specification schedule is where both live.

The Building Regulations points below are for England. Wales has its own Approved Documents and Scotland uses Technical Handbooks.

Do this first

Two decisions feed this schedule. The furnished plan from laying out a rear extension fixes the socket, drain, radiator and extract positions, and heating a rear extension fixes the heating approach and, with it, the floor build-up. The dates come from your builder's construction programme.

What goes on the schedule

Keep it in one spreadsheet, not a folder of brochures and email threads. Each line is one product, and every line answers the same questions:

ColumnWhat goes in it
ItemOne product: the garden doors, the kitchen floor tile, the WC pan
ChoiceMake, model, size, finish and colour, precise enough to order from
SupplierWho supplies it, and whether you or the builder places the order
QuantityA count or an area, checked against the drawings
Lead timeThe supplier's written date, not a range from a website
Needed byThe programme week the trade needs it

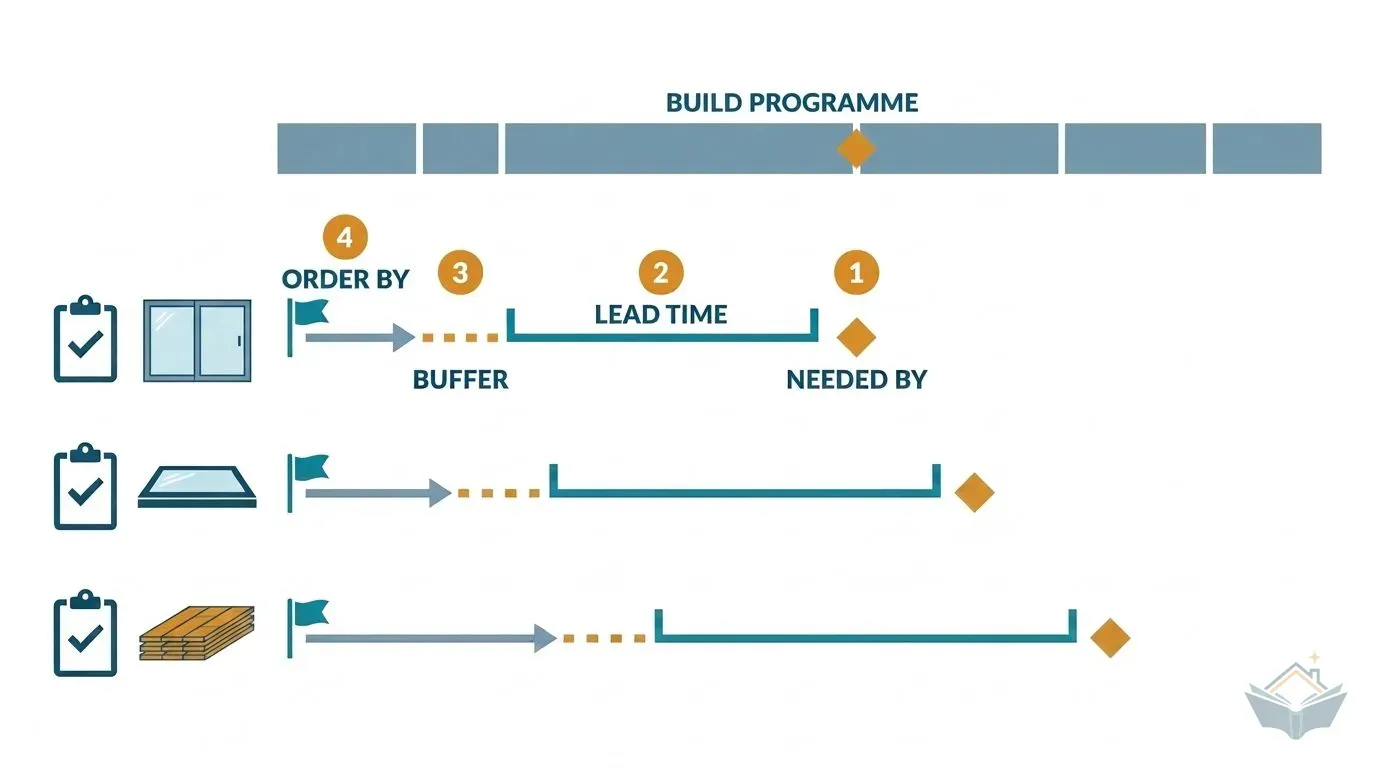

Order byNeeded by, minus the lead time, minus a buffer
DecidedYes or no. "Nearly" is a no
In the quote asFixed price, prime cost sum or provisional sum
OwnerWho signs the choice off
Depends onWhat has to be fixed first, such as an opening size or the finished floor level

The last three columns earn their place. "In the quote as" shows which choices still carry price risk. "Depends on" catches the chains: bifolds that can't be ordered until the floor build-up is settled, radiators that can't be sized until the heat loss is calculated.

Prime cost and provisional sums are open lines

Most quotes price the shell firmly and leave the finishes as allowances, of two kinds. A prime cost (PC) sum covers an item whose quantity is known but whose specification isn't: the floor area for tiles is fixed, the tile isn't chosen. A provisional sum covers work that hasn't been designed yet, such as a kitchen with no layout. Neither is a price. Each is replaced by the real cost once the choice is made.

The trap is the size of the allowance. A low PC sum makes a quote look cheaper without making it cheaper, because the difference comes back once you pick the product you actually wanted. Suppose one builder allows for a basic tile and another for the porcelain you've already shortlisted. The first quote wins on paper and is no cheaper once the tile is bought.

The builder's margin sits on top. Self-Build.co.uk puts the usual uplift for overheads and profit at 10-20% of the prime cost and says to agree the mechanism at tender. That's one publisher's indication, not a market rate, so get your builder's figure in writing before you sign. Too many open allowances leave the total open too, which defeats the point of a fixed price.

Every allowance is a schedule line marked "not decided". Turn as many as you can into named products before signing, and compare the rest by what each one buys. Getting quotes and comparing has the side-by-side method, and Rate My Quote shows what each quote includes, so the allowances and gaps are easier to spot.

What this guide covers

  1. 01The lines, in the order they fall due
  2. 02Long-lead items
  3. 03Work back from the programme
  4. 04Check the glazing allowance before you order
  5. 05Who signs off, and what a late decision costs

Free guide, just enter your email

The remaining 5 sections are free too: enter your email and confirm it to open them. Includes The lines, in the order they fall due, Long-lead items and Work back from the programme. We'll also email you when we publish a new blog post.

No spam. Unsubscribe anytime.

General guidance for homeowners in England (and Wales where we say so), not professional advice. Every site is different: check anything that affects your build with a qualified professional, your local council or building control. Terms

Frequently asked questions

Reference guides for this task

Free guides to the tools, materials and terms this step involves.

Background reading
