Managing Your Builder: Communication and Expectations

How to communicate with your builder, keep a site diary, spot warning signs early, handle disputes, and manage the relationship that determines whether your extension succeeds or fails.

20 min readUpdated 2026Free with email

Builders don't stop returning your calls because they're bad people. They stop because they're on another site, they've overpromised their diary, or they're avoiding a conversation about a problem they haven't solved yet. The frustration this causes is real. Community forums are full of homeowners at breaking point because their builder hasn't been on site for a fortnight and won't answer the phone.

But here's what those forums also show: the homeowners who come through it with a finished extension, a reasonable final bill, and their sanity intact are the ones who set up communication rules from day one, kept records, and escalated at the right moment. Not too early (which makes you the difficult client). Not too late (which lets the project drift past recovery).

This is the guide for that. Not the theory of project management. The practical, week-by-week reality of working alongside a builder for six months to a year on the most expensive thing you've done since buying the house.

Do this first

Everything below assumes you've signed a proper contract with a stage payment schedule, as covered in contracts and payment schedules, and verified your builder's insurance, as covered in insurance and liability. If those aren't done, stop here and do them first. It all depends on having a written contract and verified cover.

Set the Rules Before a Single Brick Is Laid

The conversation most homeowners skip is the one that matters most. Before your builder starts work, sit down and agree four things.

Who talks to whom. If the builder runs a team, you need a named day-to-day contact. It might be the owner, a site foreman, or a project lead. That's fine, as long as they can make decisions. On your side, one person communicates with the builder. Not you and your partner giving different instructions on different days. Mixed messages from the client are one of the most common causes of disputes that builders cite.

How you'll communicate. WhatsApp works for daily updates, photos, and quick logistics. It creates a timestamped record with images, and builders already use it. Email is for anything involving money, specifications, changes, or complaints. Phone calls are fine for quick questions but follow up in writing: "As discussed on the phone, we've agreed to move the socket from the left wall to the island. Please confirm." That one sentence is evidence.

A weekly site walk. A fixed time each week where you and the builder (or their site lead) walk the site, review progress, and talk about the week ahead. Friday afternoons work well because it frames the next week's plan. Fifteen minutes is enough. This isn't a formal meeting. It's the habit that catches problems at £200 instead of £2,000.

How scope changes work. Say it out loud even though it should be in the contract. "Any change to the agreed scope gets priced and confirmed in writing before anyone starts work." Builders who resist this aren't necessarily dishonest. They're used to clients who say "just do it" and then argue about the bill.

Tip

Create a shared WhatsApp group for the project. Include your builder, your partner if relevant, and anyone else making decisions. Every photo, every agreement, every discussion is timestamped and searchable. Six weeks from now when there's a disagreement about where a radiator was supposed to go, the answer is in the chat history.

The Site Diary

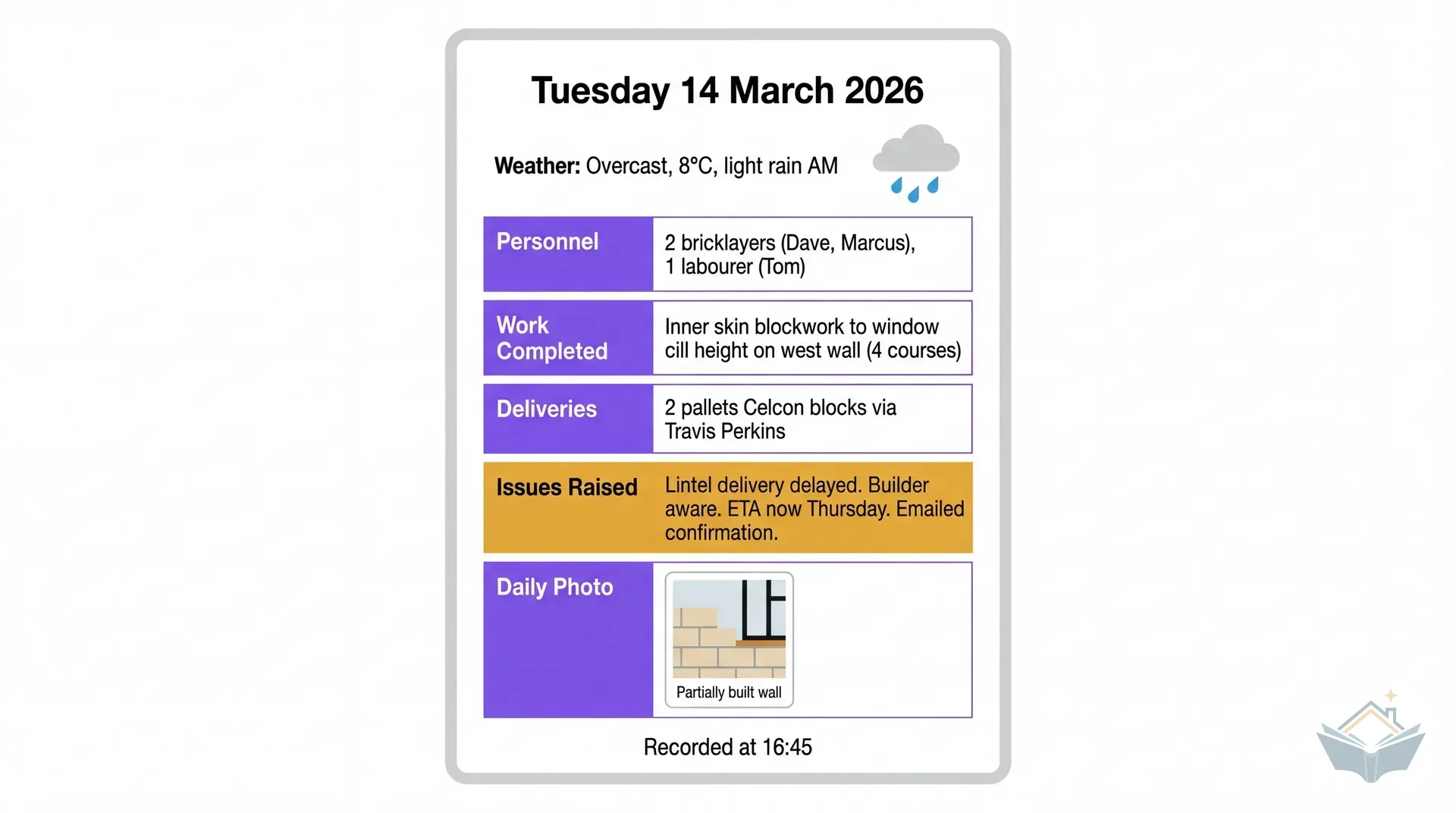

A site diary is the single most valuable thing you can do as a homeowner managing a build. Five minutes a day. It creates bargaining power you can't buy retroactively.

Record six things each day:

  • Who was on site (names and trades, not just "two blokes turned up")
  • What work was completed
  • Any deliveries or materials arriving on site
  • Weather conditions (matters for concrete, brickwork, roofing)
  • Any instructions, decisions, or conversations
  • One photo minimum, more if anything notable happened

Your phone's photo timestamps are evidence. A photo of the insulation before it's boarded over, the drainage connections before they're backfilled, the reinforcement in the foundations before concrete is poured. You'll never see these things again. If a problem surfaces months later (a damp patch, a cold spot, a blocked drain), your photos show what was actually installed.

You don't need special software. A notes app works. A cheap A5 notebook works. A spreadsheet works. The format is irrelevant. The consistency isn't.

Warning

In builder disputes, the party with better records almost always wins. A contemporaneous diary (written at the time, not reconstructed from memory weeks later) carries weight in mediation and court. "I have a diary entry from 14th March showing your team didn't attend site for three consecutive days" is the kind of statement that shifts a negotiation. Start the diary on day one and don't skip a single day.

A site diary entry doesn't need to be long. Five minutes at the end of each day creates the paper trail that wins disputes.

Printable

Weekly Site Diary Template (printable)

Printable weekly template with columns for date, personnel, work completed, deliveries, issues, decisions, and photo log. One sheet per week.

Spreadsheet

Site Diary Spreadsheet (.xlsx)

The spreadsheet version: enter your build start date and every daily row dates itself, weekends shade automatically, and the log is filterable. A second tab holds the weekly summary. Works in Excel, Google Sheets, and Numbers.

What this guide covers

  1. 01The Weekly Rhythm
  2. 02The Start Date Problem
  3. 03When Your Builder Disappears
  4. 04Unauthorised Decisions
  5. 05Scope Creep Will Eat Your Budget
  6. 06The Weather Excuse
  7. 07The Christmas Gap
  8. 08Materials Disappearing
  9. 09Payment as a Management Tool
  10. 10When Things Go Wrong
  11. 11The Final 10%
  12. 12Building Control Is Your Ally
  13. 13Protecting the Relationship
