Phase 6 · First Fix · Task 05 of 06
Underfloor Heating in Your Extension
Wet UFH planning, installation, and screed for single-storey extensions: pipe spacing, the liquid-versus-sand-and-cement screed decision, floor build-up, and the screed cost surprise most homeowners never see coming.
Check the screed specification behind your builder's allowance before booking the pour. The liquid screed budget example is £2,000 – £3,000 for 50m², but your quote must cover the actual depth, access, pumping and preparation. Compare it with a sand-and-cement quote on the same basis rather than assuming a fixed price gap.

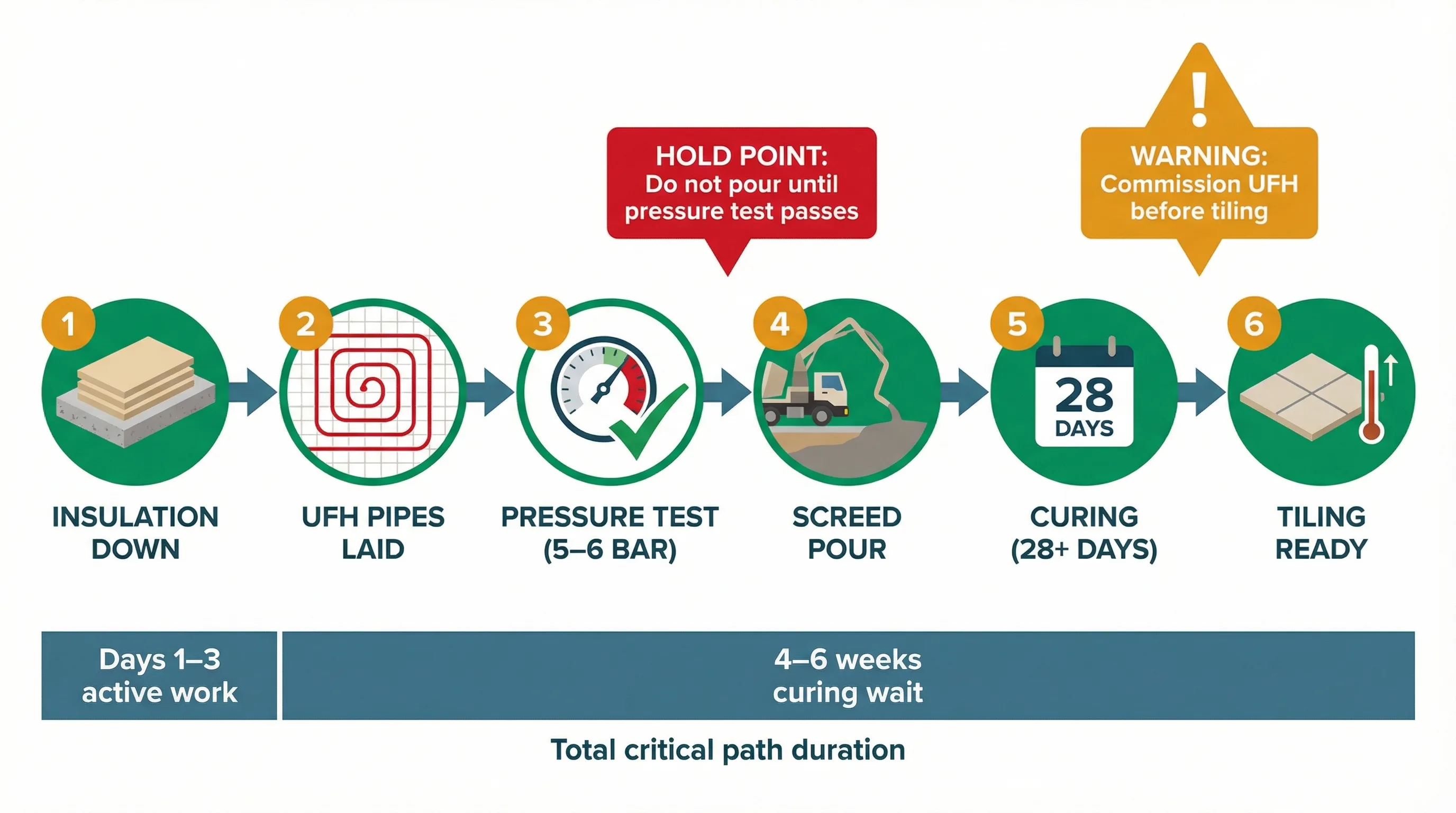

Wet underfloor heating is the right choice for a single-storey extension. It's more efficient than radiators, invisible once installed, and gives you even heat across an open-plan space with no cold spots near bifold doors. But the installation itself is a coordination exercise involving your plumber, your builder, and a specialist screed company, all working to a tight sequence where one delay cascades into weeks of lost time.
Here's the full process: what goes into the floor, who does what, when screed gets poured, and the specific hold points where you need to check the work before it disappears under 50mm of liquid concrete.
What this guide covers
- 01Wet vs Electric: One Decision, No Contest
- 02What Goes Into the Floor
- 03The Screed Decision
- 04Timing: The Three-Day Window
- 05The Pressure Test: Your One Chance
- 06Floor Level: The Problem Nobody Mentions Until It's Too Late
- 07After the Pour: Curing, Commissioning, and Laitance
- 08Floor Coverings: What Works and What Doesn't
- 09Screed Edges and Expansion Joints
- 10What It Costs
- 11Building Regulations and Controls
- 12Commissioning Documentation
- 13Key External Resources
Premium content: included with an Access Pass
This guide is part of the buildwiz.uk Access Pass. Get full access to every project guide, planning through to completion.
Get Access Pass£49, paid once. 24 months access.
Already bought the Access Pass? Sign in
General guidance for homeowners in England (and Wales where we say so), not professional advice. Every site is different: check anything that affects your build with a qualified professional, your local council or building control. Terms
