A builder walking off a job rarely looks like a walk-off. It looks like a quiet week. Calls go to voicemail, texts sit unread, and the site stays exactly as it was left. Most homeowners burn two or three weeks treating the silence as a scheduling hiccup before accepting that something has actually gone wrong.
Whether your problem is silence, a defect, a substitution you never agreed to, or a job running months late, the response that protects you follows the same steps in the same order. Skipping ahead, usually by withholding money in anger, is the single most common way homeowners convert a strong position into a weak one.
What Going Wrong Actually Looks Like
Disputes with builders cluster around four patterns: work that is defective, changes you never authorised, a programme that has quietly stopped moving, and a builder who has stopped answering.
The second one deserves more fear than it gets. On one documented build, a 30m² kitchen extension in Oxfordshire, the builder substituted a timber ridge beam where the structural design specified steel. Nobody mentioned it. Building Control caught it at inspection, not the homeowner, and the wider steelwork problem it belonged to took over 11 months to fully resolve. That build ran 35 months against the 9-15 months a well-managed kitchen extension should take, and unresolved problems like that one are a large part of why.
The step-by-step playbook for handling each pattern lives in the task tree under dealing with builder disputes. What follows is the shape of it, and the legal ground it stands on.
The Five-Step Response
1. Put it in writing
Everything before a written complaint is legally a conversation. The Consumer Rights Act 2015 puts three terms into your contract whether the paperwork mentions them or not: the work must be done with reasonable care and skill, within a reasonable time if no date was fixed, and for a reasonable price if no price was fixed. A written complaint is how you start relying on those rights.
Be specific. Name each defect or failure, say what you want done about it, and give a deadline. Fourteen days is the convention, and Citizens Advice publishes free template letters if you want a starting point. Send it by email and keep a copy. Vague unhappiness gets vague responses; a dated list with photographs attached gets taken seriously, partly because it shows the builder you're building a file.
2. Give them a reasonable chance to fix it
The Act gives you a right to repeat performance: the builder must put defective work right at their own cost, within a reasonable time and without significant inconvenience to you. Only if they can't or won't do that does the right to a price reduction take over.
This step is also where most disputes should end, because a fix from the original builder is faster and cheaper than anything a court will ever give you. On the Oxfordshire build, a mid-build gas leak connected to the works cost £856.67 to put right. No claim, no solicitor. It was settled as a negotiated deduction through the payment schedule and the job carried on. That's what a working dispute process looks like: documented, proportionate, boring.
3. Do not rashly withhold payment
Withholding money feels like your strongest card. Played early or played too big, it's the opposite.
Warning
Withholding the entire balance over a partial defect can put you in breach of contract, hand the builder a counterclaim, and legally justify them leaving site. Which? also warns it can affect your credit record where the work is financed. Withhold only a specific, evidenced, proportionate amount tied to named defects, and send the builder the itemised deduction in writing before you hold anything back.
Tradespeople's forums are full of the mirror-image story: builders who walked off jobs after a client withheld payment over a variation that was only ever agreed verbally. Undocumented changes burn both sides. If you owe money for work done properly, pay it. Your dispute is with the defective part, and your paperwork should say so precisely.
4. Gather evidence, including an independent report
If the dispute survives steps one to three, stop arguing and start documenting. Photograph every defect with timestamps. Pull together the contract, the quote, every payment, and every text or email where work was instructed or changed.
Then get independent eyes on it. Two things carry weight: a written quote from another builder to rectify or finish the work, which becomes the figure your claim is built on, and a surveyor's report on the defects themselves. A one-off inspection report typically runs £300-1,500 depending on depth, using RICS survey tiers as the guide. That feels expensive until you're in front of a judge with your photos against the builder's twenty years of experience. If the case escalates far enough to need a formal expert witness, construction experts average £147 an hour, which is its own argument for settling earlier.

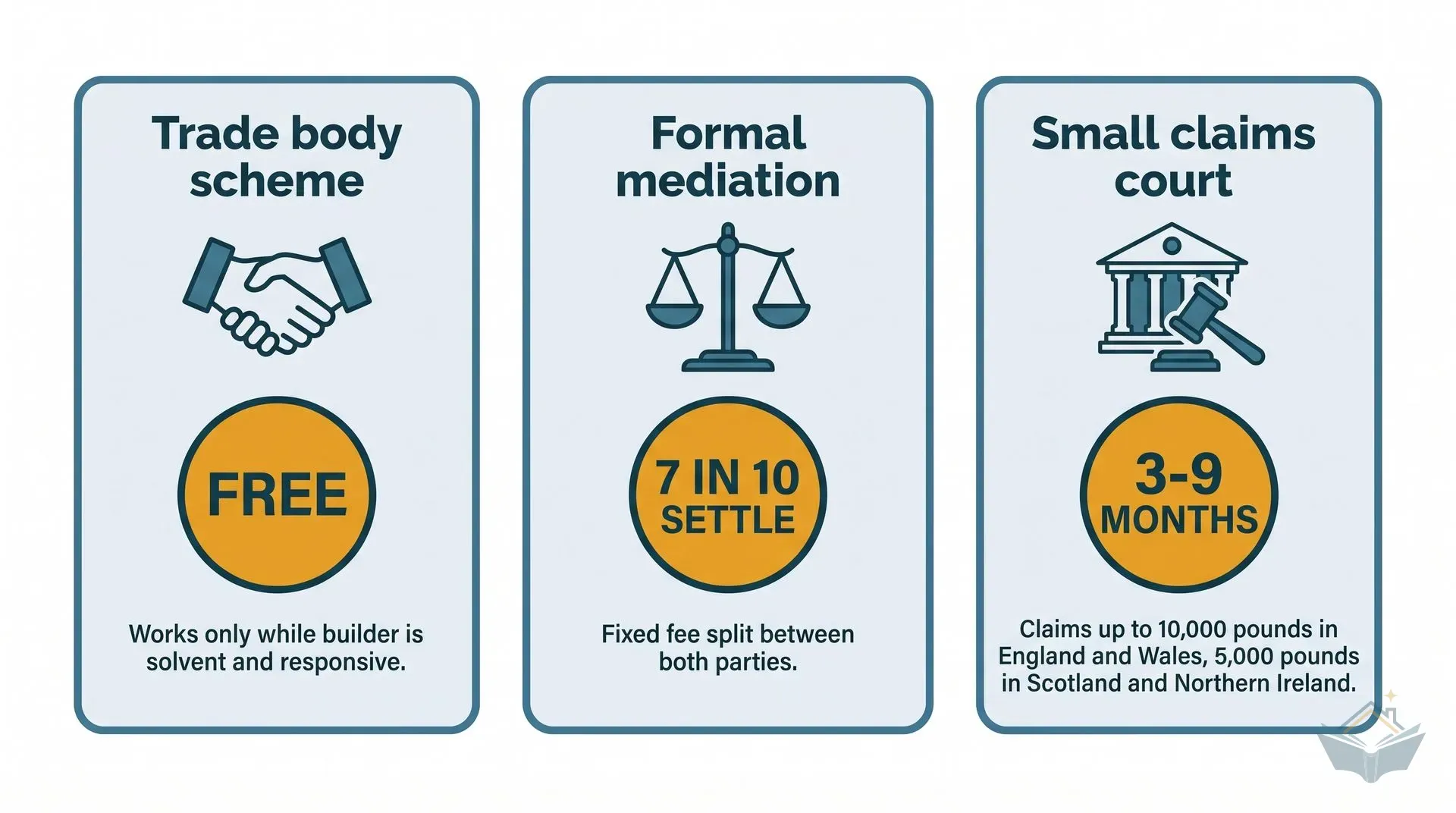

5. Escalate: ADR first, small claims last
Courts expect you to try alternative dispute resolution before issuing a claim, and it's genuinely cheaper. But know what each route can and cannot do before you lean on it.
One thing commercial builders have that you don't: statutory adjudication, the fast-track 28-day process from the Housing Grants, Construction and Regeneration Act 1996, excludes contracts with residential occupiers under section 106. As a homeowner you have no automatic right to adjudication. Your ADR options are voluntary or contractual:
- Trade body schemes. The FMB's dispute service is free where your builder is a member, and TrustMark-registered traders come with ombudsman access. Be clear-eyed about the limits: reviews consistently describe the FMB process as slow correspondence-relaying, and both schemes offer nothing once a builder is unresponsive or has gone bust. The ombudsman explicitly excludes businesses in liquidation. These schemes work on a solvent builder who wants to keep their membership, and not otherwise.
- Formal mediation. RICS runs a homeowner mediation service at £400 plus VAT for disputes up to £5,000 and £1,000 plus VAT up to £25,000, split between the parties. RIBA offers fixed-fee mediation from £180 including VAT under the right contract. Around 70% of mediated cases settle without going near a court, which makes the fee good value against months of claim-and-defence.
- Small claims. Before issuing, send a formal letter before action: the basis of your claim, the amount, and 14 days to respond. You can write it yourself for nothing; a solicitor will charge £150-400 for the same letter, and that fee isn't recoverable in small claims even if you win. Then claim through Money Claim Online. Court fees run £35-£455 on a sliding scale, the small claims limit is £10,000 in England and Wales (£5,000 in Scotland and Northern Ireland), and a defended claim now goes through the free HMCTS mediation service before it gets a hearing. Expect 3-9 months end to end.
Tip
Winning a judgment and collecting the money are different problems. A county court judgment against a builder with no assets, or a company dissolved before enforcement, is a piece of paper. Before spending months on a claim, check the builder's company status at Companies House, and if any part of your payment went on a credit card, pursue the card provider first: Section 75 of the Consumer Credit Act makes them jointly liable, and it pays out faster than any court.
Delay: A Missed Finish Date Does Not End the Contract
The most common misreading of a builder dispute is the deadline one. Your contract said 16 weeks, it's now week 30, so the builder has breached and you can throw them off and hire someone else. Except UK courts do not treat time as "of the essence" in building contracts by default. A missed date alone doesn't let you terminate, and acting as if it does can make you the party in breach.
There is a route. Serve written notice giving the builder a further reasonable period to finish, commonly around 14 days for the remaining work, and state that time will then be of the essence. If they still fail to complete, termination becomes defensible. Until you've served that notice, your remedy for delay is compensation for the losses it causes, not a locked gate.
When the Builder Is Gone for Good
Sometimes there is no dispute left to resolve, just an empty site and a dead phone. Don't keep paying, don't touch the workmanship until it's photographed, and get a second builder's written quote to complete the job, because that quote quantifies your loss. Check Companies House before deciding whether a claim is worth it: pursuing a dissolved company or an individual with nothing to enforce against recovers nothing, and unsecured creditors of a liquidated firm typically see none of their money. The same triage applies when it's a supplier rather than the builder who folds mid-job, which has its own recovery routes covered in dealing with supplier failure.

The Part Solicitors Skip: Making Disputes Rare
Every consumer-rights page tells you what to do after it goes wrong. Almost none of them tell you that the homeowners who avoid disputes altogether do three unglamorous things before and during the build.
A written contract. A JCT Homeowner or FMB contract costs almost nothing to put in place (a legal review runs £0 – £120 at most) and turns every later argument into a question of what the document says. The clauses that earn their keep: a deposit capped at 10-15%, a 5% retention held until the end of a 12-month defects period, and a line requiring written approval for any structural material substitution. That last clause is the one that would have surfaced the timber-for-steel ridge beam swap before it was built in rather than at inspection. The contracts and payment schedules guide walks through each clause.
Staged payments tied to inspected stages. Money is your control system. Pay for work that exists and has been looked at, never for work that's promised, and keep the payment schedule aligned with building control inspection points so someone qualified has seen each stage before it's paid for. Sized correctly, a deposit is legitimate, and there's a worked example with real first-week numbers showing what it should cover. A builder who is never owed less than the value of remaining work has every incentive to finish; one who is paid ahead has none.
A paper trail. Self-builders who keep a dated site diary and confirm every verbal instruction by text or email afterwards report shorter, cheaper disputes than those who ran on handshakes, and it's not close. The gas-leak deduction above settled quickly for exactly this reason: the payment schedule and the correspondence around it left nothing to argue about. Ten minutes a day of notes is the cheapest legal protection available to a homeowner, and it's the core habit in managing your builder relationship.
The other half of prevention happens before the contract exists at all: a properly compared set of quotes removes the ambiguities that become disputes, and verifying the builder's insurance tells you early whether you're dealing with someone who runs their business on paperwork or on promises. Defective workmanship is never an insurance claim anyway; it's a contract and retention problem, which is why the contract matters more.
Where This Fits in Your Build
Dispute-proofing isn't a separate project. It's a handful of tasks inside the pre-construction phase, sitting alongside quotes, contracts, insurance and party wall notices, and they only work if they happen in the right order. You can browse the full kitchen extension task tree for free to see every task in sequence. The Kitchen Extension Access Pass opens the working detail on all of them, dispute playbook included, for £49.
Frequently Asked Questions
Can I withhold payment from my builder?
Yes, but only a proportionate amount tied to specific, evidenced defects, with an itemised deduction sent to the builder in writing first. Withholding the whole balance because you're generally unhappy risks putting you in breach of contract, invites a counterclaim, and gives the builder legal cover to leave site.
What is ADR in a builder dispute?
Alternative dispute resolution: settling the dispute outside court through a trade body scheme, an ombudsman, or paid mediation through RICS or RIBA. Homeowners have no right to the statutory adjudication commercial construction uses, because section 106 of the Housing Grants, Construction and Regeneration Act 1996 excludes residential occupiers, so ADR is voluntary. Courts still expect you to attempt it before issuing a claim.
Can I take my builder to the small claims court?
Yes, for claims up to £10,000 in England and Wales or £5,000 in Scotland and Northern Ireland, filed through Money Claim Online with court fees between £35 and £455. Send a letter before action giving 14 days to respond first. Budget 3-9 months, and check the builder has assets or an active company before you start, because enforcing a judgment against someone with nothing recovers nothing.
How do I stop this happening again?
Three habits cover most of it: a written contract with a capped deposit, a retention clause and a ban on unapproved substitutions; staged payments released only after each stage has been inspected; and a dated paper trail confirming every instruction and variation in writing. Builds run this way still hit problems, but the problems settle in days through the payment schedule instead of months through a court.
