Plate Compactor (Wacker Plate): The Complete Guide for UK Extension Work
Everything you need to know about hiring and using a wacker plate: layer thickness limits, passes, technique, HAVS risk, and when the building inspector cares.
Your groundworker fills the footprint with 200mm of hardcore and runs the wacker plate over it once. It looks solid. Building control attends for the foundations inspection and tells you the sub-base needs doing again properly. The concrete pour has to wait. Your groundworker charges you for extra time on site. The plate compactor is straightforward to use correctly, but the number of extension sub-bases that fail inspection due to inadequate compaction is not small. Understanding what the tool actually does, and what it doesn't do, is worth thirty minutes of your time before the groundwork starts.
What it is and when you need one
A plate compactor (universally known as a wacker plate in the UK, after the German manufacturer Wacker Neuson whose machines became the generic name) is a petrol or electric-powered machine with a flat steel plate on the underside. An eccentric weight inside the engine housing spins at speed, generating vibration that the plate transmits directly into the ground. That vibration forces air and water out of the gaps between aggregate particles, causing them to lock together under load. The result is a dense, stable layer that won't shift under the weight of a concrete slab or whatever sits above it.
What the plate cannot do is compact material deeper than about 75–100mm in a single pass. The vibration energy dissipates rapidly with depth. Fill a trench with 300mm of hardcore and run the plate over it, and the top 75mm will be compacted while the material below stays loose. The slab above settles. Cracks follow. This is the single most important thing to know about the tool.
On an extension project, you'll use a plate compactor at three points. The first is compacting the sub-base: the layer of hardcore or MOT Type 1 that sits beneath the concrete oversite slab across the footprint of the extension. The second is backfilling around drainage runs, where a plate compactor (or its close relative, the trench rammer) firms the material around and above pipes without displacing them. The third is any ancillary groundwork: paths, driveways, patio sub-bases, or the area outside the extension footprint that was disturbed during excavation.

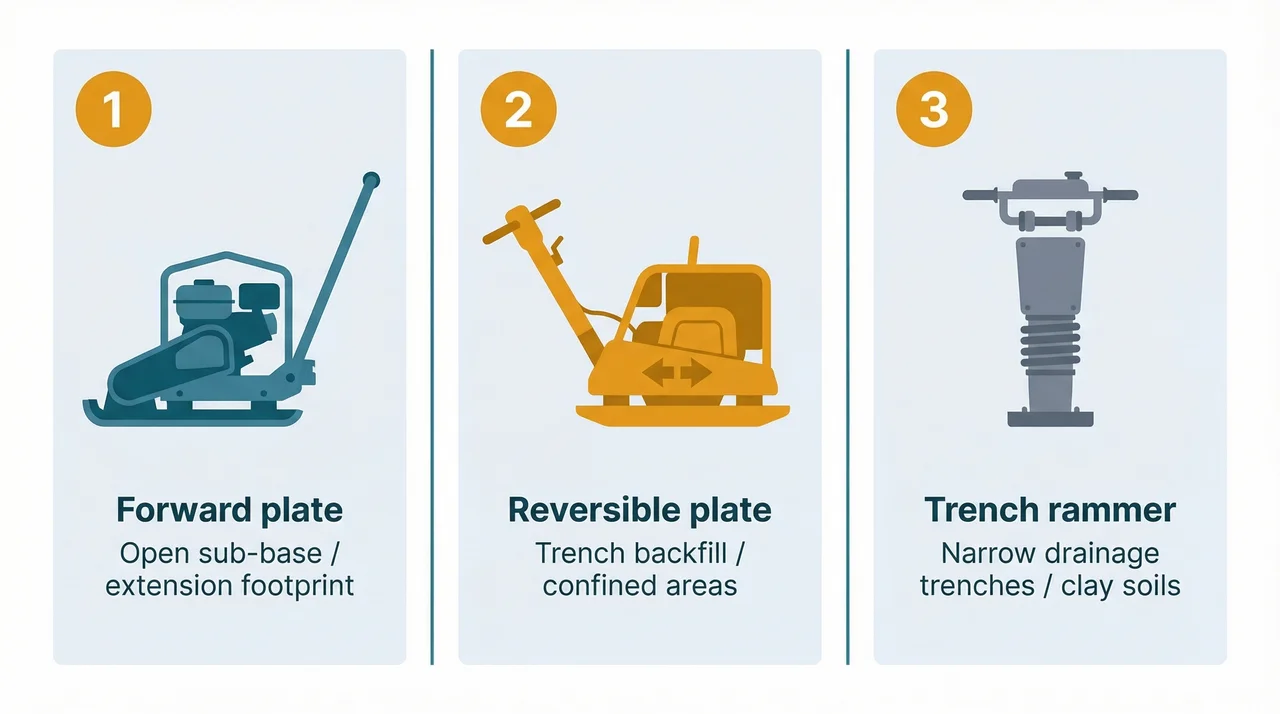

Forward plate vs reversible plate: which to hire
Most hire depots stock two types of plate compactor and it's worth knowing the difference before you book.
| Type | How it moves | Best for | Hire rate |
|---|---|---|---|
| Forward plate (standard) | Self-propels forward when throttle is opened. Does not reverse; you lift and carry to reposition. | Open sub-base areas: extension footprint, paths, driveways, shed bases | Standard day rate from local hire |
| Reversible plate | Can travel forward and backward under power. More manoeuvrable in tight spaces. | Drainage trench backfill, confined spaces, working close to walls and obstacles | Typically 10–20% higher than forward plate at most depots |
For the standard extension sub-base across an open footprint, a forward plate is the right hire. It's lighter, simpler to use, and covers ground efficiently. The reversible plate is worth the upgrade if you're compacting backfill in a drainage trench or working in a confined area where you can't easily reposition by hand.
A third machine type, the trench rammer (also called a jumping jack), uses an impact mechanism rather than vibration and is designed specifically for narrow drainage trenches. Hire depots stock them as a separate item. If your drainage involves deep, narrow trenches and clay soil, a trench rammer is more effective than trying to angle a plate compactor over the edges of a trench.
How to use it properly
The hire company will have demonstrated the machine before you left the depot. Here's what matters for an extension sub-base, including the things most demonstrations skip.
Before you start
Check the fuel. Petrol models need the correct fuel (unleaded petrol, not diesel) and the engine oil level should be visible through the sight glass. A wacker plate running low on oil damages the engine. Hire companies service their machines, but check anyway, particularly if the machine has had a rough day before yours.
Inspect the plate itself. It should be clean and flat. Any cement or aggregate buildup on the underside reduces compaction efficiency and the weight distribution changes. If it's badly fouled, ask the hire depot to replace it.
Mark any underground services. Before you start, identify where any buried drainage, electrical cables, or gas pipes run. The plate compactor will not burst a properly bedded plastic drain pipe (more on this below), but knowing where the services are prevents you from working blindly.
Set up PPE before starting. This is not optional. Engine noise from a plate compactor is above the 85 dB(A) threshold that triggers mandatory hearing protection under the Control of Noise at Work Regulations 2005. Ear defenders, eye protection against flying aggregate fragments, steel-toecap boots (the plate is heavy enough to cause serious injury if it catches your foot), and work gloves. The machine self-propels when the throttle opens; keep your feet clear of the plate.
Prepare the material
Moisture content matters for compaction quality. Completely dry hardcore doesn't bind well. Saturated material is too mobile to compact cleanly. The target is damp but not wet. The test: grab a handful of the sub-base material and squeeze it. It should hold together without water dripping from it. "Water is a fantastic compaction aid," as the BuildHub community reliably notes. If the material has been sitting dry in hot weather, dampen it before compacting.
Spread the material in even layers before compacting. The maximum layer thickness for a standard hire plate (around 12kN centrifugal force) is 75–100mm per lift. For an extension sub-base where you want the highest quality result and the building inspector is attending before the concrete pour, work in 75mm lifts. Spreading the full 150mm of sub-base in one go and running the plate over it once only firms the top half. The bottom half stays loose.
Starting and operating the machine
The starting procedure varies by model but the principle is the same: set the throttle to idle (the "tortoise" position on the throttle dial on most hire machines) before pulling the cord. This prevents the machine from lurching forward immediately on start. Once running, let it warm for thirty seconds at idle. Then open the throttle fully; the machine will vibrate more intensely and begin to self-propel forward.
Walk at the machine's natural pace. Do not try to slow it down by resisting it; this fatigues you and reduces compaction consistency. If you need to move more slowly, close the throttle slightly.
Work in straight, overlapping passes. Cover the area in lines, overlapping each pass by about 30%. Finish the area, then rotate 90 degrees and repeat the pass pattern. Working at 90 degrees on the second set of passes gives you more even compaction than running the plate in the same direction twice. Minimum four passes total across the whole area; six passes on the areas directly beneath where the slab will bear on structural elements.
At the edges and corners, the self-propelling plate tends to drift. At walls and existing structures, slow the machine to idle to maintain control. Compact right up to the edge; loose material at the perimeter is the most common cause of slab edge settlement.
When you're done, let the engine idle for two minutes before shutting it off. This allows the engine to cool gradually, which prolongs engine life.
Add a rubber pad (available separately at most hire depots for £5–10) to the underside of the plate if you're compacting paving stones, block paving, or any surface you don't want to mark. The rubber cushion transmits compaction without scratching or cracking the paving surface.

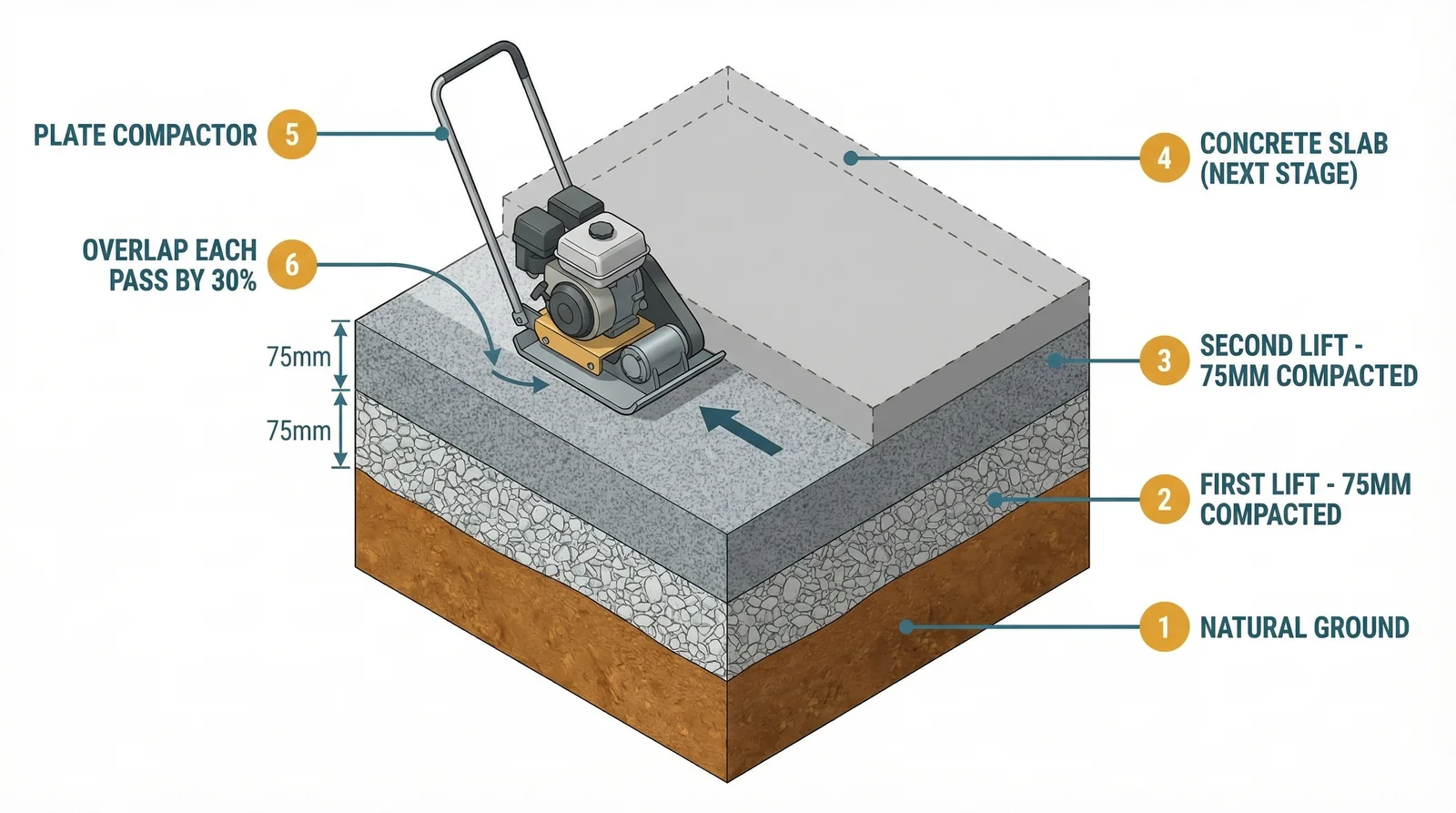

Layer sequence

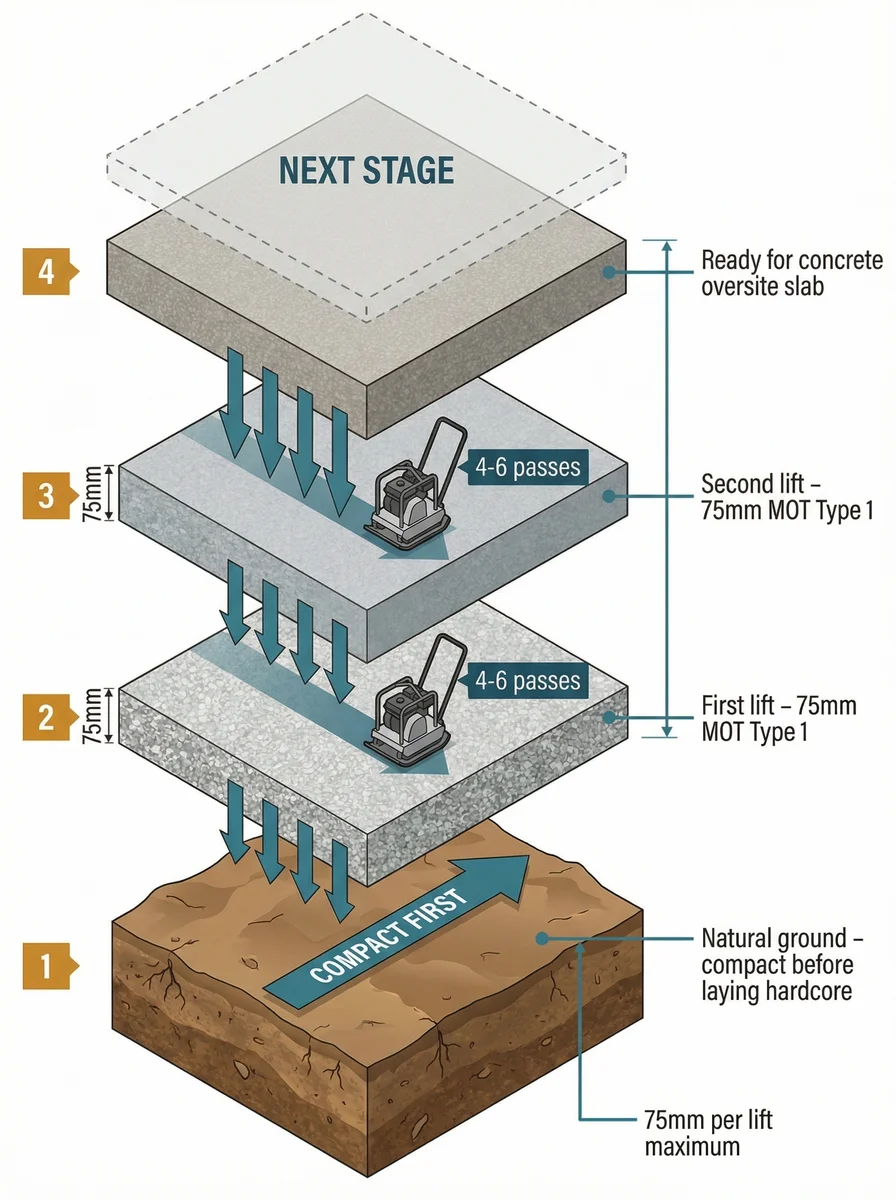

For a typical extension sub-base:
- Compact the natural ground first, before any hardcore goes down. Particularly important if the ground has been disturbed by excavation machinery.
- Lay first 75mm lift of hardcore or MOT Type 1. Compact with four to six passes.
- Lay second 75mm lift. Compact again with four to six passes.
- If total sub-base depth exceeds 150mm (for example, on disturbed or soft ground where the structural engineer has specified a deeper sub-base), add further 75mm lifts with compaction between each.
- Final surface should be stable underfoot. Walk on it. If your boot sinks or the surface moves, it's not compacted enough.
Compacting near drains and pipes
This question comes up on every extension project with drainage and the community answer is consistent: modern plastic pipes that are properly bedded are not at risk from a standard plate compactor.
The key condition is "properly bedded." A plastic drain pipe sitting loose in aggregate is a different proposition from a pipe bedded in pea gravel (single-size 10mm or 20mm gravel) with a minimum 150mm pea gravel layer above the pipe crown before any compacted hardcore is placed. With that bedding detail in place, the plate compactor vibration dissipates through the gravel layer before reaching the pipe. Clay pipes are less forgiving than plastic, but on any extension built since the mid-1990s, plastic (PVC-U or PPs) is almost certainly what's under there.
If your drainage has been installed without pea gravel bedding, do not compact directly above the pipe runs with a plate compactor. Hand-tamp that area instead and keep the plate away from directly above the pipe line.
The building control connection
Sub-base compaction for an extension is a formal hold point. Building control must be notified before the concrete oversite slab is poured. The inspector may attend to check that:
- The sub-base is at the correct level and depth
- It is visually firm (does not shift underfoot)
- The material is suitable (clean hardcore or MOT Type 1, free of topsoil and organic material)
You cannot pour the concrete until this inspection is either attended or waived. Skipping the notification because "it looks fine" is how you end up with a slab you can't certify at completion stage. Give building control a few working days' notice before you want to pour, more in busy periods.
Do not compact organic material such as soil or topsoil into the sub-base. Organic material continues to decompose after the slab is poured, causing ongoing settlement long after the extension is built. If there is any doubt about whether excavated material includes organic content, remove it entirely and bring in clean MOT Type 1.
Hire: cost, process, and what to expect
Plate compactors are almost always hired, not bought. A typical extension project uses one for a single day or at most two.
Local plant hire companies and builders' merchant hire desks (Jewson, Buildbase, Travis Perkins tool hire) are the best value:
Local hire, day rate
£35 – £50
National chains (Speedy Hire, HSS, National Tool Hire) are more convenient if you need online booking, guaranteed availability, or delivery:
National chain hire, day rate
£60 – £75
If your groundwork spans a full week with both sub-base work and drainage backfill:
Week rate
£55 – £150
At some national chains, the week rate is actually lower than the day rate (National Tool Hire lists their week rate at £73 versus £60/day). Check before assuming the day rate is cheaper.
The hire process at most depots follows a standard pattern. You'll need two forms of identification. A security deposit is held on your card and refunded on return of the machine in the same condition. Most depots ask for proof of insurance for hired plant, though for a one-off domestic extension, a credit card deposit is usually sufficient for a wacker plate. If you're unsure, call ahead. The hire controller will demonstrate starting and stopping the machine before you take it away.
Fuel: most national chains supply the machine with a full tank. Some local depots charge a small top-up fee of around £10 if you return it empty. Confirm when you book.
Transport: a standard 320mm or 400mm forward plate compactor weighs 60–80kg. It fits in the boot of a large estate car or an SUV with the rear seats folded, or in any transit-size van. A ramp or two people is needed to load it. Most hire depots have staff who will help load it. For delivery to site, expect an additional charge on top of the hire rate.
Buying makes no sense for a one-off extension. Entry-level plate compactors start at around £330–400 (Buffalo, Hyundai, Scheppach), but the quality of a basic bought machine is lower than what you'll get from a hire depot's maintained professional stock. Hire the good machine, return it when the job is done.
HAVS and vibration exposure
HAVS (Hand-Arm Vibration Syndrome) is a permanent and progressive condition caused by prolonged exposure to vibrating tools. The legal framework (Control of Vibration at Work Regulations 2005) applies to employers, not to domestic users, but the physical health risk from vibration is the same regardless of your employment status.
Standard hire plate compactors produce vibration at around 4.5 m/s². At that level, you reach the Exposure Action Value (EAV, the level at which protective action should begin) after approximately three hours of continuous use. The Exposure Limit Value (ELV) is not reached until after around six to ten hours.
For a domestic extension sub-base, most people will be operating the machine for one to two hours in a single session. That's within safe limits provided you take breaks. The practical guidance: step away from the machine for ten to fifteen minutes after each hour of operation. Keep your hands warm (cold temperatures accelerate vibration damage). Wear gloves. If you feel tingling or numbness in your fingers, stop for the rest of the day.
The HAVS risk on a wacker plate is significantly lower than on an SDS breaker or a kango hammer, and domestic extension use is brief enough that the risk is manageable. Don't ignore it, but don't treat it as a reason to hand-tamp 30m2 of hardcore.
Never run a petrol plate compactor indoors or in a partially enclosed space such as a garage or underbuilding. The exhaust fumes contain carbon monoxide. Electric models (110V or 240V) are the correct choice for any indoor compaction work. If you need to compact a floor sub-base inside an existing structure, ask the hire depot specifically for the electric model.
When you don't need one
A plate compactor is not always necessary. If you're compacting a small area (a metre square or less), a hand tamper (a heavy steel plate on a handle) is adequate and spares you the cost of a day's hire. Hand tampers are inexpensive and available from any builders' merchant.
If the ground is already undisturbed, firm, and has not been excavated, you may not need to compact it at all before laying hardcore. The key test: does it move underfoot? If not, it's compact enough as a starting point. Your structural engineer's notes or the building control officer will confirm what's required for your specific site.
On very small patios and paths (under about 3m²), a hand tamper and careful manual work can achieve adequate compaction. On anything larger, the plate compactor is faster, more consistent, and more reliable. The PistonHeads forum community consensus on this is blunt: the hired machine is "significantly faster and more effective" for any area over 2–3m².
Alternatives
For larger areas (a full driveway, or a particularly large extension footprint), a vibrating roller covers ground more quickly than a plate compactor. Vibrating rollers are also hire items. The distinction matters for speed, not for technique; the same layer thickness limits and pass counts apply.
For drainage trench backfill in narrow trenches, the trench rammer (jumping jack) is more appropriate than a plate compactor. Its narrow footprint fits a trench; the plate compactor spans across it.
Where you'll need this
Plate compactors appear in the groundwork phase of any extension or renovation project:
- Foundations and footings - compacting sub-base before the concrete oversite slab is poured; a formal building control hold point
- Groundwork - compacting prepared ground and hardcore fill across the extension footprint
- Drainage - compacting backfill above drainage runs, with correct pea gravel bedding over pipes
- Damp-proof course - compacting sub-base beneath the DPC and concrete slab before the damp-proof membrane is laid
