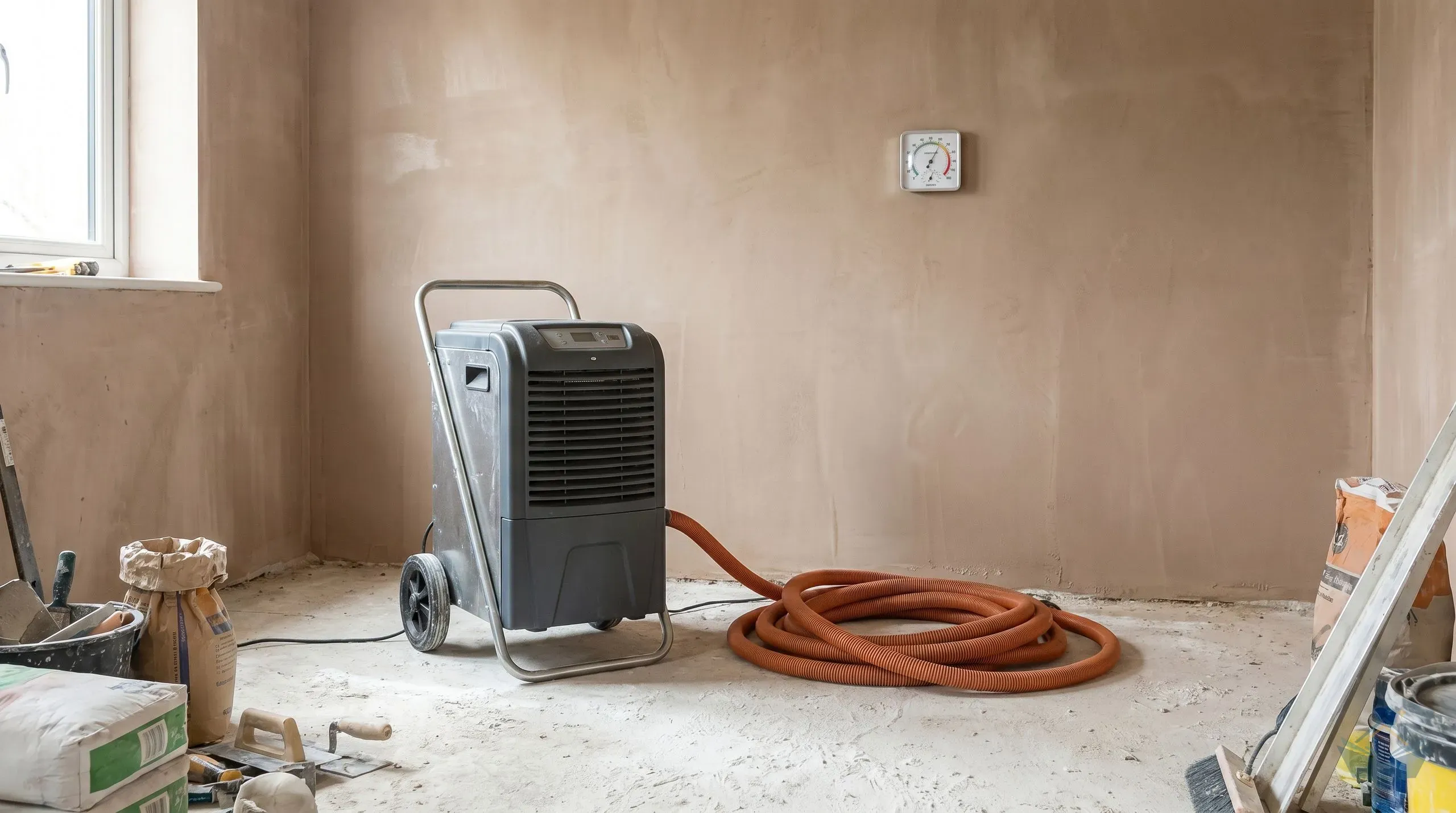

buildwiz.uk

Construction Dehumidifiers: How to Speed Up Plaster and Screed Drying

What a dehumidifier does, the difference between compressor and desiccant models, the conditions each handles best, and why hiring one beats buying for a single build.

By Ian

Project managed a £182k Oxfordshire kitchen extension

Fresh plaster can delay decorating when the substrate is not ready for paint. A dehumidifier may help control the drying environment where the plaster manufacturer permits assisted drying. It cannot guarantee a completion date or replace the required curing period and moisture checks.

The decision is whether assisted drying is suitable for the material and conditions, which type of unit to use, and when the manufacturer permits it to start.

What a dehumidifier is and what it does

A dehumidifier is an electric appliance that removes water vapour from the air. The dry air it produces then absorbs moisture from wet surfaces (plaster, screed, timber) faster than the moisture would naturally migrate to outdoor air through ventilation. The water it captures collects in an internal tank or drains continuously through a hose to a sink or external drain.

Two technology types dominate the UK market.

Compressor dehumidifiers work by passing room air over a refrigerated coil. Moisture in the air condenses on the cold coil, drips into the tank, and the now-dry air is reheated and returned to the room. Compressor units work best in warm, humid conditions (above 16°C). They struggle below 10°C because the cold coil ices over and stops working effectively.

Desiccant dehumidifiers work by passing room air through a rotating wheel of moisture-absorbing material (typically silica gel or zeolite). The wet wheel is then heated, the moisture released as vapour, and condensed in a separate stream. Desiccant units work effectively in cold conditions (below 10°C) and at low humidities, where compressor units fail. They use more electricity than compressors at warm temperatures.

For a UK extension build, the choice between the two depends on the season and the building's state.

ConditionsBest technologyWhy
Spring/summer, weatherproofed extension, plaster freshly appliedCompressorRoom is warm, plaster is releasing high moisture; compressor extracts efficiently
Winter, partially weatherproofed shell, low ambient temperaturesDesiccantCold rooms, the only technology that works below 10°C
Sealed room with screed dryingEitherBoth work; compressor cheaper to run if temperature is above 15°C
Pre-decoration drying, mid-spec kitchenCompressorStandard hire shop default; works for the typical use case

For most extensions plastered between April and October, a compressor dehumidifier is the right hire. For winter builds or unheated rooms, a desiccant unit is the right call. Hire shops stock both; tell them the conditions and they'll recommend the matching unit.

Why drying matters at every plaster and screed stage

Plaster and screed need suitable curing and drying conditions. The waiting period depends on the product, thickness and site environment; check its instructions and the requirements of the finish that follows.

If the next trade lays a finish over a still-drying substrate, two failure modes are common:

Painted plaster crazes and stains. Paint applied over wet plaster traps moisture against the surface. The moisture finds its way through the paint film over time, leaving stains, blisters, and crazed paint patterns. The fix is stripping the paint, allowing the plaster to dry, and repainting.

Flooring laid before the substrate is ready can fail. Follow the chosen floor and adhesive manufacturers' moisture limits and test method. A dehumidifier does not establish readiness by itself.

A dehumidifier can help manage drying conditions where the material manufacturer allows it. Do not promise a fixed programme saving: material, thickness, temperature, ventilation and initial moisture all affect the result.

When to switch on the dehumidifier

The conventional advice is to wait until plaster has set properly before introducing aggressive drying, then ramp up the drying gradually. Forcing fresh plaster to dry too quickly causes shrinkage cracks and surface dusting because the surface dries faster than the underlying material.

For plaster, follow the plaster and coating manufacturers' instructions on curing, ventilation and assisted drying. Do not use a generic day-by-day dehumidifier schedule for either gypsum or sand-and-cement plaster. Confirm that the substrate meets the coating requirements before decorating; elapsed days or a surface feeling dry are not proof.

For screed, follow the maker's curing and drying instructions before using a dehumidifier. Traditional sand-and-cement screed commonly needs about 7 days curing under polythene. For Gyvlon calcium sulphate screed, ventilation can start after 48 hours, but dehumidifiers must wait until at least 72 hours. These are different stages: permission to ventilate does not mean permission to force-dry. Other proprietary screeds may differ. Choose the drying equipment for the room temperature and use it only once the screed supplier permits it.

Tip

Pair the dehumidifier with a small fan circulating air around the room. Air movement equalises moisture across surfaces and prevents corners or low spots developing as wet patches. An inexpensive oscillating fan from any homeware store does the job.

Hire vs buy

For a single extension build, hiring is the obvious choice.

OptionCostWhen this makes sense
Hire compressor unit (Ebac CD30 or similar)Weekly hire rate from HSS, Brandon, SpeedyStandard 2-3 week plaster drying; the typical homeowner hire
Hire desiccant unitCheck the hire rate and power consumptionCold conditions within the unit's stated operating range
Hire long-term (4+ weeks)Discount typical, ask for monthly rateScreed drying jobs that span 6-12 weeks
Buy compressor unit (domestic 12L/day capacity)Retail purchase (Meaco, EcoAir, Pro Breeze)Building several extensions, or also wanting to use unit at home for damp control later
Buy industrial unit (Ebac CD30P or similar)Many times the cost of a hireTrade builders running multiple builds at once; not justified for one homeowner project

Ask the hire supplier to size a unit for the room volume, temperature and amount of moisture to remove. Agree when assisted drying may start with the material manufacturer or installer, and review the hire duration against actual conditions rather than a fixed plaster-drying schedule.

For winter builds, give the hire depot the expected room temperature and ask for a unit rated for those conditions. A desiccant unit can suit cold rooms. The Ebac BD150 is a refrigerant/compressor dehumidifier with reverse-cycle defrost, not a desiccant model; check its operating range and extraction performance before choosing it.

Domestic-grade dehumidifiers (Meaco and EcoAir) work but extract less per day than the trade units. A 12-litre-per-day domestic unit takes longer to dry the same room than a 30-litre trade unit. Cost-effective only if you also want a unit for general home damp control after the build.

How to set up the unit

Two practical considerations beyond which type to hire.

Drainage. Compressor units fill their internal tank quickly when working hard; a 30-litre-per-day unit fills its 5L tank in 4 hours. Manually emptying the tank multiple times a day is impractical. Almost every trade unit has a continuous drain port; rig a hose from the port to a sink, washing machine waste, or external drain. Keep the hose end below the tank level so gravity pulls the water through.

Power. Industrial units draw 500W to 1000W continuously. Plug the unit into an RCD-protected socket, either directly or through a single heavy-duty 13-amp lead. If the lead is on a cable reel, unwind it fully: a coiled reel is rated far lower than its unwound rating and can overheat under a continuous load. Don't run a 1000W unit through a daisy-chain of cheap extension leads.

Door and window position. A dehumidifier only works on the air in the room it's in. Open doors and windows let the dry air it produces escape and let moist outside air in. Close all doors and windows during dehumidifier operation. Open briefly only when emptying tanks or moving the unit.

Warning

Keep the dehumidifier's air inlet and outlet unobstructed and follow its instructions for clearances, placement and operating temperature. Keep combustible materials away as directed by the manufacturer; exhaust temperature and clearance requirements vary by model.

Where you'll use it

Dehumidifiers come out at multiple drying stages:

  • Plastering for managing drying conditions where the plaster manufacturer permits it
  • Screeding for accelerating screed drying before flooring
  • Underfloor heating commissioning, where dehumidification combines with the UFH heating cycle for fastest possible screed drying
  • Decoration for ensuring substrates are dry enough for paint and any moisture-sensitive finishes
  • Building extension during winter where ambient drying is too slow to be practical

Review the hire period against measured conditions and the finish requirements. Return the unit when it is no longer needed; do not use its runtime as proof that a substrate is ready.

Common mistakes

Switching the dehumidifier on too early. Wait until the material manufacturer permits assisted drying. Starting before the required curing stage is complete can damage the finish.

Running the unit with windows or doors open. The dehumidifier dries the air in its room. Open doors and windows let dry air out and moist air in; the unit then runs constantly and achieves nothing.

Using a compressor unit in cold conditions. Below 10°C the compressor coil ices over and the unit stops working effectively. In winter or unheated rooms, hire a desiccant unit instead.

Forgetting the drainage hose. Manually emptying a 5L tank four times a day is impractical. Run a hose to a drain. Most hire shops include a hose with the unit.

Underspecifying the unit capacity. A small domestic 6L/day unit cannot dry an entire kitchen extension's worth of fresh plaster. The trade units at 30L/day or 50L/day are the right size for residential extension work.

Ignoring power requirements. A 1000W unit running for weeks on a flimsy or coiled extension lead overheats the lead. Use a single heavy-duty 13-amp lead, fully unwound, from an RCD-protected socket.
