buildwiz.ukbuildwiz.uk

Cavity Boards: The Mortar-Catching Tool That Stops Damp Bridging Your Walls

UK guide to cavity boards: what they are, how to make one, why mortar in your cavity causes damp years later, and what building control will check at the structure inspection.

Three years after the extension was signed off, a damp patch appears on the inside of the new wall. A surveyor opens up the plaster and finds the cause: a mortar shelf wedged across two wall ties, channelling rainwater from the wet outer brickwork straight into the inner blockwork. The remedy is to cut out a section of the inner leaf, clear the cavity, repair the wall, and redecorate. Cost: low thousands. Cause: a bricklayer who didn't bother with a cavity board on a Friday afternoon when the foreman wasn't looking. This is one of the most under-discussed failure modes in UK extension construction, and the prevention is a piece of timber and a length of rope.

What it is and what it's for

A cavity board (also called a cavity batten, mortar catching board, or cavity cleaning board) is a flat strip of material sized to span the full width of a cavity wall, dragged upward through the cavity as the bricklayer builds. Its job is to catch mortar droppings before they land on the wall ties below or accumulate at the bottom of the cavity. It sits across the wall ties on the most recent course, gets pulled up by rope or wire handles every two or three courses, and the mortar that has fallen on it is tipped off and the board cleaned before being lowered back into position for the next lift.

You will not find cavity boards on the shelves at Wickes or B&Q. There is no mainstream branded product. The standard UK approach is for the bricklayer to make one on site from offcuts of timber batten, drill a couple of holes through it, and thread stiff wire or builders' string through to form handles. It costs effectively nothing and works perfectly. A specialist plastic kit exists (see below), but it is priced for trade housebuilders building dozens of plots, not for a homeowner running a single extension.

The reason cavity boards matter is that mortar in a cavity is not cosmetic. Mortar landing on a wall tie creates a continuous physical bridge between the wet outer leaf and the dry inner leaf. Water travels along that bridge by capillary action and reappears as damp on the inside wall, sometimes years later. Mortar piled up at the base of the cavity at DPC level forms a shelf that bypasses the DPC entirely, allowing rising damp to climb past the barrier you paid for. Mortar landed on the top edge of cavity insulation conducts moisture from the outer leaf through the insulation into the inner leaf. None of these failures is theoretical. All of them are documented as common defects in NHBC and LABC inspection literature.

Why a clean cavity is a regulatory requirement

The legal hook is Building Regulations Approved Document C, Requirement C2: walls must "adequately resist the passage of moisture to the inside of the building." The technical means of compliance are set out in Section 5 of Approved Document C, which specifies that cavities must be kept clear of mortar droppings and that wall ties must be cleared of mortar and debris as work proceeds. This is not advisory. It is the route to compliance with the regulation.

NHBC Standards 2025, Chapter 6.1.11, goes further. The standard explicitly references the cavity board technique: "a board can be positioned on wall ties and raised as work proceeds, catching mortar droppings for easy removal." NHBC inspections of new builds check cavity cleanliness directly. Local Authority Building Control (LABC) inspections of extensions do the same at the structure inspection stage. The inspector looks into the cavity through any open joint, opening, or unfinished course and confirms that the cavity is clean, that wall ties are not buried in mortar, and that the bottom of the cavity has no mortar shelf at DPC level.

Where the extension wall adjoins a neighbour's property (semi-detached and terraced houses), Approved Document E (sound insulation) becomes relevant. Robust Details Ltd identifies mortar accumulation in cavities as "the most significant cause of impaired sound insulation performance affecting cavity masonry separating walls." A failed sound test on a separating wall can require the wall to be opened up and rebuilt. Cavity cleanliness is not just a damp issue; it is a noise issue too.

For full-fill cavity insulation, BS 6676: Part 2: 1986 (now withdrawn but still referenced in manufacturers' BBA certificates) specifically requires the use of cavity battens to keep the junctions of mineral wool batts and the wall tie surfaces free of mortar. Without this, mortar between the batts saturates the insulation and renders it ineffective, both thermally and as a moisture barrier.

What gets damaged when you skip it

Three failure modes turn up repeatedly in inspection reports and damp surveys:

Mortar bridges across wall ties. A wall tie is a stainless steel strip that ties the inner and outer leaves of the cavity together for structural stability, embedded at least 50mm into each leaf and spaced at maximum 900mm horizontal x 450mm vertical centres. Each tie is engineered with a downward slope toward the outer leaf and a drip in the centre of the cavity, so any water on the tie runs off into the outer leaf, not into the inner one. Mortar dropped on the tie reverses this. It fills the drip, levels the slope, and creates a continuous wet path across the cavity. A Kingspan study cited by NHBC found "extremely large mortar droppings engulfing wall ties" caused directly by the absence of a cavity board during construction.

Mortar shelf bridging the DPC. The DPC sits at the bottom of the cavity, two or three courses above external ground level, with at least 150mm clearance above finished ground. Below the DPC, ground moisture is allowed to migrate into the brickwork. Above the DPC, it must not. If mortar accumulates at the base of the cavity until the pile reaches and crosses the DPC, the entire damp protection of the wall is bypassed. The mortar shelf creates a moisture path that climbs from below the DPC to above it, and the wall behaves as if the DPC were never installed. This shows up later as inexplicable rising damp on a new-build extension that "should not have rising damp" because it has a DPC.

Mortar contamination on insulation. Cavity insulation is fitted as either partial fill (boards fixed against the inner leaf with a clear cavity in front) or full fill (batts that completely fill the cavity). For partial fill, mortar sitting on the top edge of the boards transmits moisture from the outer leaf wall onto the inner leaf wall, creating localised damp patches. For full fill, mortar between batts and on tie junctions saturates the mineral wool, destroying the air pocket structure that gives the insulation its thermal performance. Saturated insulation does not dry out. It stays wet, transmits cold and damp inward, and may need to be replaced wholesale.

How to make a cavity board

The standard DIY method is the same on every UK site that uses one. The dimensions are not critical, but the construction is consistent.

Materials per board:

  • One length of softwood batten, typically 50x25mm (sometimes referred to as "2 by 1") or 100x25mm if you want a wider catch surface. Length: about 600-800mm, enough to span the cavity comfortably with overhang at each end. Offcuts from structural timber on the build are normally adequate.
  • Two lengths of stiff galvanised wire, builders' string, or thin rope, each long enough to reach from the cavity board position up past the top course of the working wall and out by another 200-300mm so you can grip the handles comfortably. Plan for the full eventual height of the wall.
  • A scrap of polythene sheet (optional but recommended) to wrap the timber, preventing mortar bonding to the wood.

Construction:

  1. Cut the batten to length so it sits cleanly across the cavity, resting on the wall ties of the inner and outer leaf without forcing.
  2. Drill two holes through the batten, roughly 100mm in from each end, large enough to thread your wire or rope.
  3. Thread the wire or rope through each hole and tie a stopper knot or twist a loop on the underside, so the handles cannot pull out under load.
  4. Wrap the batten loosely in polythene if you are using it. Tape the polythene at each end so it stays put.
  5. Tie a small loop at the top of each handle so the bricklayer can grip them quickly without searching.

For an extension with cavity walls running, say, 12 metres in total perimeter, two or three boards lets the bricklayer leapfrog them along the run. One board per wall section is enough if the bricklayer is conscientious about lifting it as work proceeds. If you are paying day rates and your bricklayer is moving at pace, having a few prepared in advance prevents the "I haven't got time to make one now" excuse.

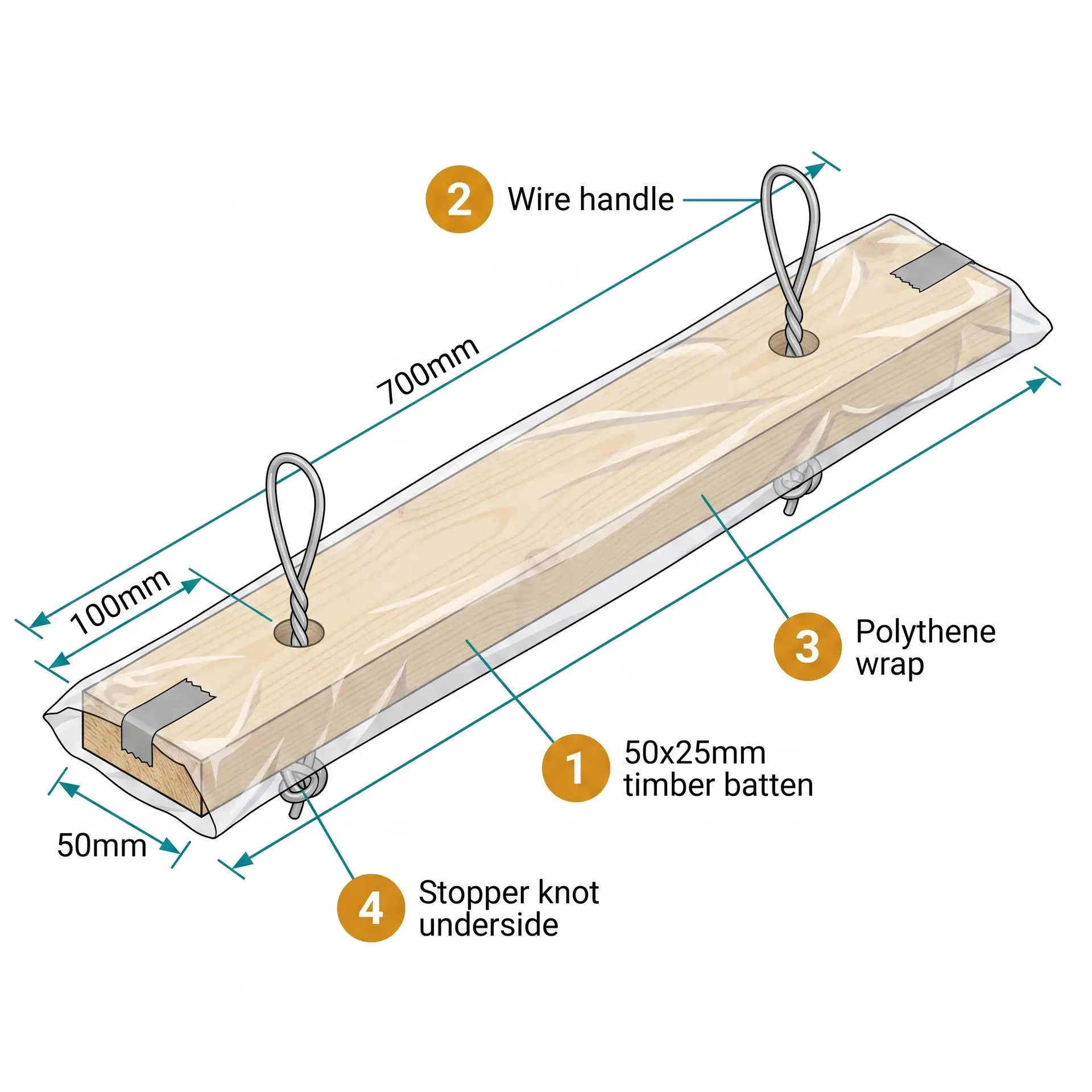

A finished DIY cavity board made from timber batten, galvanised wire, and polythene wrap

How it gets used during bricklaying

The technique is straightforward. The discipline is in doing it consistently.

  1. Before the first course of cavity wall is laid above DPC, position the cavity board across the lowest course of wall ties, level or angled very slightly toward the inner leaf so droppings collect rather than rolling off. The wire handles run upward and lay over the top of the working courses.
  2. As the bricklayer lays the next two or three courses of both leaves, mortar inevitably falls into the cavity. Some lands on the board. Some squeezes out of bed joints onto the back face of the outer leaf. The board catches the airborne droppings.
  3. When the working level reaches the next set of wall ties (typically every 450mm), the bricklayer pulls the board up by the wire handles. Whatever has landed on the top comes with it.
  4. The board is tipped to one side over the cavity edge or removed completely, the mortar tipped off, the surface tapped clean.
  5. The board is repositioned across the new top course of wall ties, below the new working level. The wires are draped over the top of the wall again.
  6. The cycle repeats every two or three courses for the full height of the cavity.
Tip

Lift the board sooner rather than later. Mortar that has been sitting for an hour is loose. Mortar that has been sitting overnight has cured to the timber and is harder to clean off. If the bricklayer is taking a break for tea or lunch, lift and clean the board first.

Warning

Never leave the cavity board in position overnight with a load of mortar on it. The mortar cures, bonds to the timber and wall ties below, and creates exactly the kind of mortar bridge the board is meant to prevent. The end-of-day routine is: lift the board, tip the mortar out, remove the board entirely, store it for the next day. If the bricklayer is leaving site, the board comes out.

A good bricklayer also minimises mortar entering the cavity in the first place through trowel technique: chamfering the bed joint slightly away from the cavity, filling perpends from the face rather than the back, not over-buttering. The board is a backup for inevitable droppings, not a substitute for careful work. If you are watching your bricklayer flick mortar wildly into the cavity and "the board will catch it," you have a problem the board cannot solve on its own.

What to ask your bricklayer

Most homeowners cannot tell from the outside whether a cavity is being kept clean. The bricklayer's habits during the build determine the answer. Five questions establish whether the right things are happening:

  • Are you using a cavity board, and from which course? (Answer should be: yes, from course one above DPC.)
  • How often are you lifting and cleaning it? (Every two to three courses, or whenever wall ties are reached.)
  • What happens to it at end of day? (It comes out completely, no mortar load left in the cavity.)
  • Are you leaving any access bricks for end-of-day cavity inspection? (Loose-bedded "sand bricks" every two metres at low level allow rodding and inspection before the cavity is closed.)
  • Can I look into the cavity at the end of each day? (The answer should be yes, and the cavity should look clean.)

A bricklayer who reacts defensively to these questions is telling you something. A bricklayer who says "I always do this anyway" and walks you to the wall to show you is the one you want. The best bricklayers are quietly proud of clean cavities and will explain their technique without being asked.

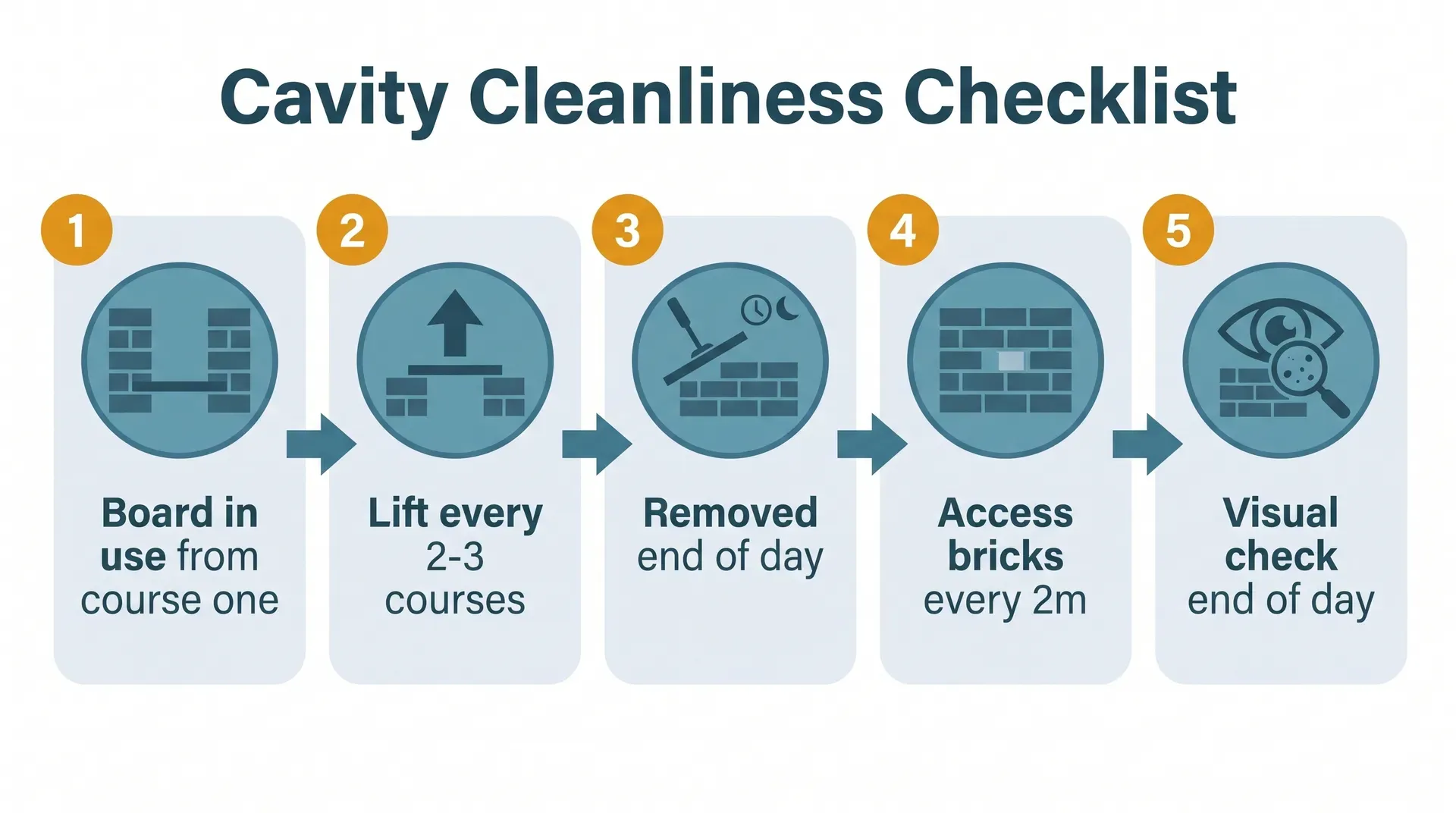

Five questions to ask your bricklayer about cavity cleanliness - and what the answers should be

What building control will check

Building control inspects at the structure stage, after the walls are up to plate level but before the roof goes on, and at the DPC stage if your build phases the inspections. The cavity is one of the things the inspector looks at directly. They cannot see the full height because the cavity is mostly closed by then, but they can look down from the top, look in through any incomplete openings, and look up from any access points the bricklayer has left.

Specifically, the inspector is checking:

  • Cavity is at least 50mm clear (with insulation in place if partial fill).
  • No mortar droppings sitting on wall ties.
  • Wall ties sloping correctly toward the outer leaf, not flat or sloping inward.
  • No mortar bridging at DPC level.
  • Insulation top edges are free of mortar.
  • Weep vents are clear (at the bottom of the cavity, allowing any moisture to drain out).
  • Cavity trays at abutments are correctly installed and not blocked by mortar.

If the inspector finds mortar contamination, the typical outcome is to require the bricklayer to clean the cavity before sign-off. In severe cases, where mortar is bridging the DPC and there is no access to remove it, the inspector can require the wall to be opened up. A cavity that has been cleaned during construction with a board is essentially never the cause of a structural inspection failure. A cavity that has been built without one frequently is.

Cost: there isn't really one

For the DIY method, the cost of a cavity board is the cost of a length of timber batten and a few feet of wire or rope. Most bricklayers use offcuts from the build itself. A merchant length of 50x25mm sawn softwood is a few pounds; you only need a metre of it. The total real cost is essentially negligible.

If you wanted to buy a manufactured product, the only mainstream UK option is the Cavity Tray Cleaner (cavitytraycleaner.co.uk), a modular plastic system designed specifically for the cavity tray zone around DPC level. It is reusable across multiple builds.

Cavity Tray Cleaner reusable kit (10m)

£150£200

That price tag is calibrated for trade housebuilders running multiple plots, not for a single extension homeowner. The amortised cost across, say, 20 plots is reasonable. For a one-off extension homeowner, the kit is hard to justify when a piece of 2x1 timber with rope handles does exactly the same job. Manufactured polystyrene or foam pre-cut versions exist informally, in the price range below, but no major UK builders' merchant stocks them.

Cavity board (manufactured, per board)

£5£15

The honest answer for almost every homeowner is: you do not buy a cavity board. Your bricklayer makes one, or you make one and hand it to them. If you want to be useful on site for an hour, this is a job a homeowner can genuinely do.

Alternatives and complementary techniques

Cavity boards are the primary control, but they are not the only one. Three other techniques get used alongside or instead of a board:

Mortar-free trowel technique. The cleanest cavities come from bricklayers who barely drop any mortar in the first place. Beds chamfered slightly away from the cavity, perpends filled from the face, no over-buttering. This is what experienced contributors on BuildHub and DIYnot consistently say: "a good brickie should not really be putting so much mortar down that it is squeezing out enough to fall constantly." A skilled bricklayer with no cavity board will produce a cleaner cavity than a careless one with a board. Use both for best results.

Access bricks for end-of-day rodding. Some bricklayers prefer to leave loose-bedded "sand bricks" or "rodding bricks" every two metres along each run at low level, near DPC. At the end of the day or before closing the bottom of the cavity, the bricks are removed and a stiff length of timber lath or batten is pushed along the cavity to knock down any mortar lumps clinging to the inner face of the outer leaf. The droppings are raked out through the openings before the bricks are bedded back permanently. This is a separate technique from a cavity board and addresses a different problem (mortar snots stuck to the back face of the outer leaf, which a board cannot reach).

Mortar net products. US-style "Mortar Net" mesh strips that sit at the base of the cavity to prevent mortar piling at DPC level are available in the UK but not widely used. They are a backup for the DPC zone specifically, not a replacement for a cavity board catching droppings during construction.

The Cavity Tray Cleaner kit (mentioned above). A proprietary modular plastic system for the cavity tray zone. Trade-priced. Useful where multiple plots are being built; uneconomic for one-off extensions.

For full-fill cavity insulation specifically, BS 6676 and the dampchat technical commentary recommend building the outer leaf as the leading skin (working from the outside face up, with the inner leaf following behind). This contradicts the dominant UK site practice of working from the inner leaf and raises the bar for cavity board discipline. If your specification calls for full-fill mineral wool batts in the cavity (Rockwool, Knauf DriTherm), this is worth a conversation with your bricklayer before they start. Most domestic extensions use partial fill, where the issue is less acute.

Where you'll need this

A cavity board is in continuous use throughout the cavity wall construction phase, from the first course above DPC to the closing course at eaves or wall plate level.

  • Walls and blockwork - cavity board in use from the first course above DPC, lifted every two to three courses to keep wall ties and insulation free of mortar
  • Damp proof course - keeping the bottom of the cavity clear so no mortar shelf bridges the DPC at construction or in the years following

These touch points apply across any extension or renovation project that uses cavity wall construction, not only kitchen extensions. Loft conversions involving new external walls, garage conversions extending into new build, and side-return extensions all use the same technique.

Common mistakes

Not using one at all. The most common failure. The bricklayer is on day rate, the homeowner doesn't know to ask, and the cavity fills up with droppings over the course of the build. The mortar bridges show up years later as damp patches that the homeowner has no easy way to trace back to the cause. Prevent this by asking before the bricklayer starts work, not after.

Leaving the board in overnight with mortar on it. The mortar cures to the timber, the wires get stuck in mortar at the wall tie level, and pulling the board up the next morning either tears the wires off or pulls a chunk of fresh masonry with it. The board has to come out at end of day, every day.

Using a board that's too narrow. A board that does not span the full cavity width allows mortar to fall past it on either side. The board needs to fit snugly across the cavity, edge to edge, leaving as little gap as possible against the inner and outer leaves.

Letting mortar build up between lifts. A board lifted every two courses catches small amounts of mortar that are easy to clean off. A board lifted every six courses is carrying a heavy load that the wires were not designed for, the board flexes, and droppings spill onto the wall ties below as the board is lifted. The fix is more frequent lifts, not a stronger board.

Confusing it with a cavity tray. A cavity tray is a permanent preformed component installed at abutments and lintel positions to redirect cavity moisture back outside through weep vents. It is a different product with a different function. The cavity board is a temporary tool used during construction. Both are needed. They do not substitute for each other.

Removing the board for the day with mortar still on top of the DPC. If the board is lifted but mortar has already dropped past it onto the DPC, simply removing the board does nothing about the existing pile. Where mortar has bypassed the board, it has to be raked out through access bricks or knocked down before the cavity is closed at the top. This is the rodding technique, and it complements the board. It does not replace the discipline of using one in the first place.
