Lead Flashing: Codes, Costs and What to Specify for Your Extension Roof

Everything UK homeowners need to know about lead flashing: codes explained, correct application by type, how to check your roofer's work, and when lead-free alternatives make sense.

A single poor joint where your extension roof meets the existing house wall will let water in for years before anyone notices. The stain appears inside on a bedroom ceiling two floors up. By then the timber behind the wall is saturated, the plaster is blown, and a repair that should have cost £300 in materials is now a £300 strip-out. Lead flashing is the material that prevents this. It's been used on UK roofs for centuries, it's specified in every building standard that matters, and when installed correctly it will outlast the tiles it sits alongside. But the wrong code, the wrong length, or a missing soaker turns a lifetime material into a five-year problem.

What it is and what it's for

Lead flashing is rolled sheet lead cut and shaped to weatherproof the junctions on a roof where water would otherwise find a way in. Every point where a roof slope meets a vertical wall, wraps around a chimney, or runs along a valley needs flashing. On an extension, the critical junction is the abutment: where the new roof butts up against the existing house wall.

The lead is manufactured to BS EN 12588, which defines thickness, weight, and mechanical tolerances for each "code" (a grading system from Code 3 through Code 8, with higher numbers being thicker and heavier). Over 95% of construction lead in the UK comes from recycled sources. Both major UK manufacturers, Midland Lead and Calder Lead, produce to this standard and offer guarantees of 50 to 60 years.

Lead works because it's soft enough to dress tightly around complex shapes (tile profiles, chimney corners, pipe penetrations) yet durable enough to withstand decades of thermal cycling without cracking, provided the pieces are kept short enough. That last point is where most failures start.

The primary installation standard is BS 6915:2001+A1:2014. NHBC (the warranty body for new-build and many extension projects) sets out specific requirements in Section 7.2.20 covering minimum codes, upstands, laps, chase depths, and piece lengths. Building control inspectors check these during the roof-covering inspection.

Types, codes, and specifications

Lead codes are a colour-coded thickness system. Each code has a coloured stripe on the roll so you can identify it on site without measuring. The ones you'll encounter on domestic roofing work are Codes 3, 4, and 5.

CodeColourThicknessWeight per m2Primary use
Code 3Green1.32mm14.97 kgSoakers (hidden pieces tucked under tiles at abutments). Sheltered locations only.
Code 4Blue1.80mm20.41 kgStep flashings, cover flashings, abutment flashings, pitched valley gutters, dormers. The standard for any exposed flashing.
Code 5Red2.24mm25.40 kgParapet gutters, high-exposure locations, flat roof bays. Rarely needed on a standard extension.

Code 4 is the industry standard for exposed flashings on domestic work. NHBC requires a minimum of Code 4 for cover flashings and step flashings. Code 3 is acceptable for soakers in sheltered or moderate-exposure locations because soakers sit hidden beneath the cover flashing and tiles, protected from direct weathering.

Code 4 is roughly 37% thicker and 36% heavier than Code 3. The extra mass gives it better resistance to thermal movement (the expansion and contraction that happens as the lead heats up in summer sun and cools overnight). This movement is the reason lead flashings must never exceed 1.5m in any single piece. Longer pieces crack within months as the accumulated expansion has nowhere to go.

Standard roll widths

Lead flashing comes in rolls of various widths. For extension abutment work, you'll typically need:

  • 150mm - narrow flashings, pipe penetrations
  • 240mm - step flashings at standard abutments (the most common width for extension work)
  • 300mm - wider step flashings, apron flashings at the base of a chimney or wall
  • 450mm - back gutters behind chimneys, valley linings
  • 600mm - wide valley gutters, parapet details

Standard roll lengths are 3m and 6m. The 6m rolls are far cheaper per metre. A Code 4 roll at 150mm width costs around £4-£8 for 3m (about £4-£8/m) from Wickes or Trade Store Online, but 6m rolls from Roofing Superstore bring the per-metre cost down to around £4£8 depending on width. For 240mm Code 4 (the typical extension abutment width), expect to pay £4£8 per metre from a 6m roll.

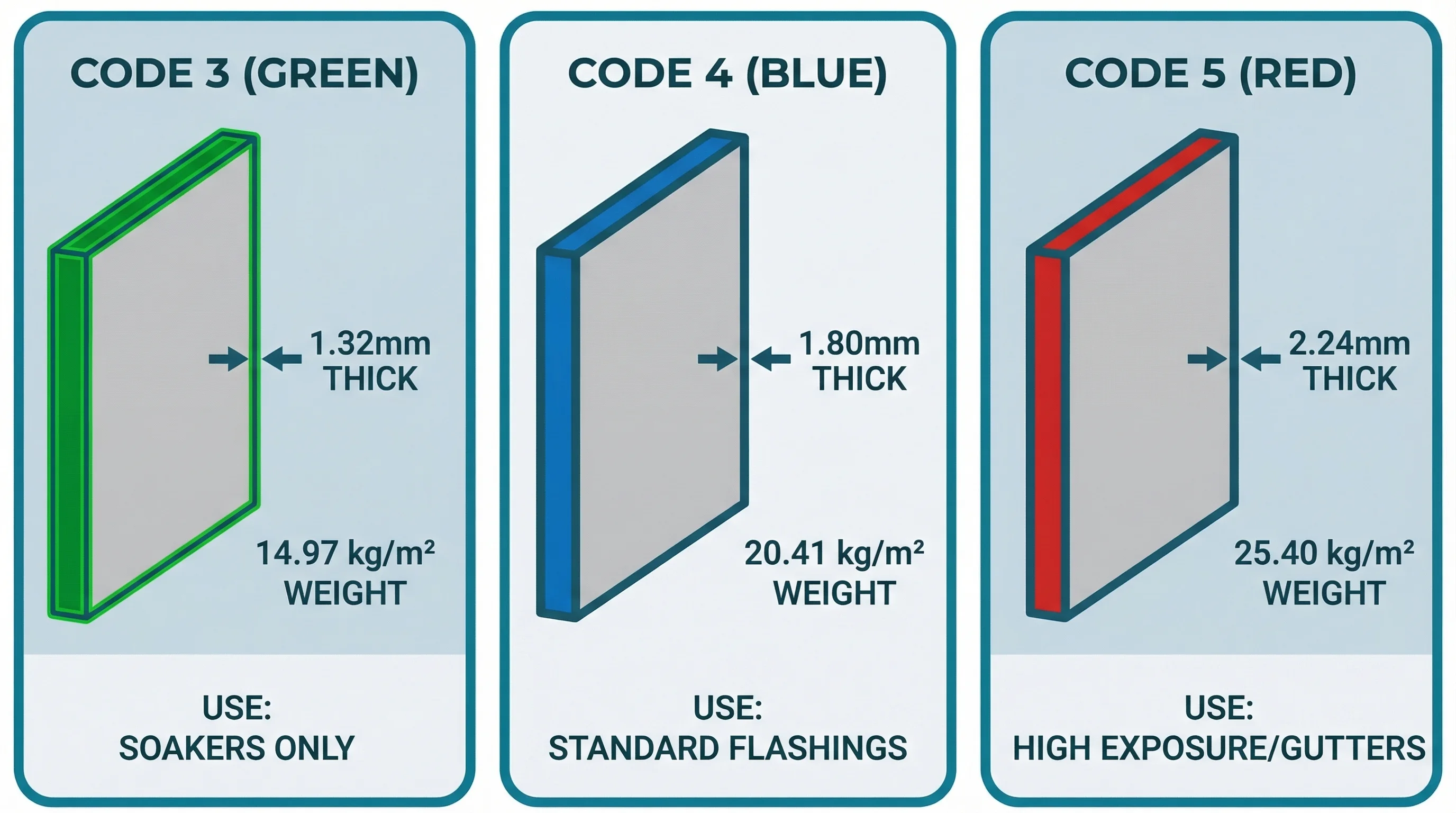

Lead codes use colour stripes to identify thickness: green for Code 3, blue for Code 4, red for Code 5

How to work with it

You won't be installing lead flashing yourself unless you're experienced at working at height and confident with lead dressing techniques. But understanding how it goes on means you can spot problems before your roofer leaves site.

The soaker and step flashing system

This is the detail most commonly botched on domestic extensions, and the one most homeowners don't understand.

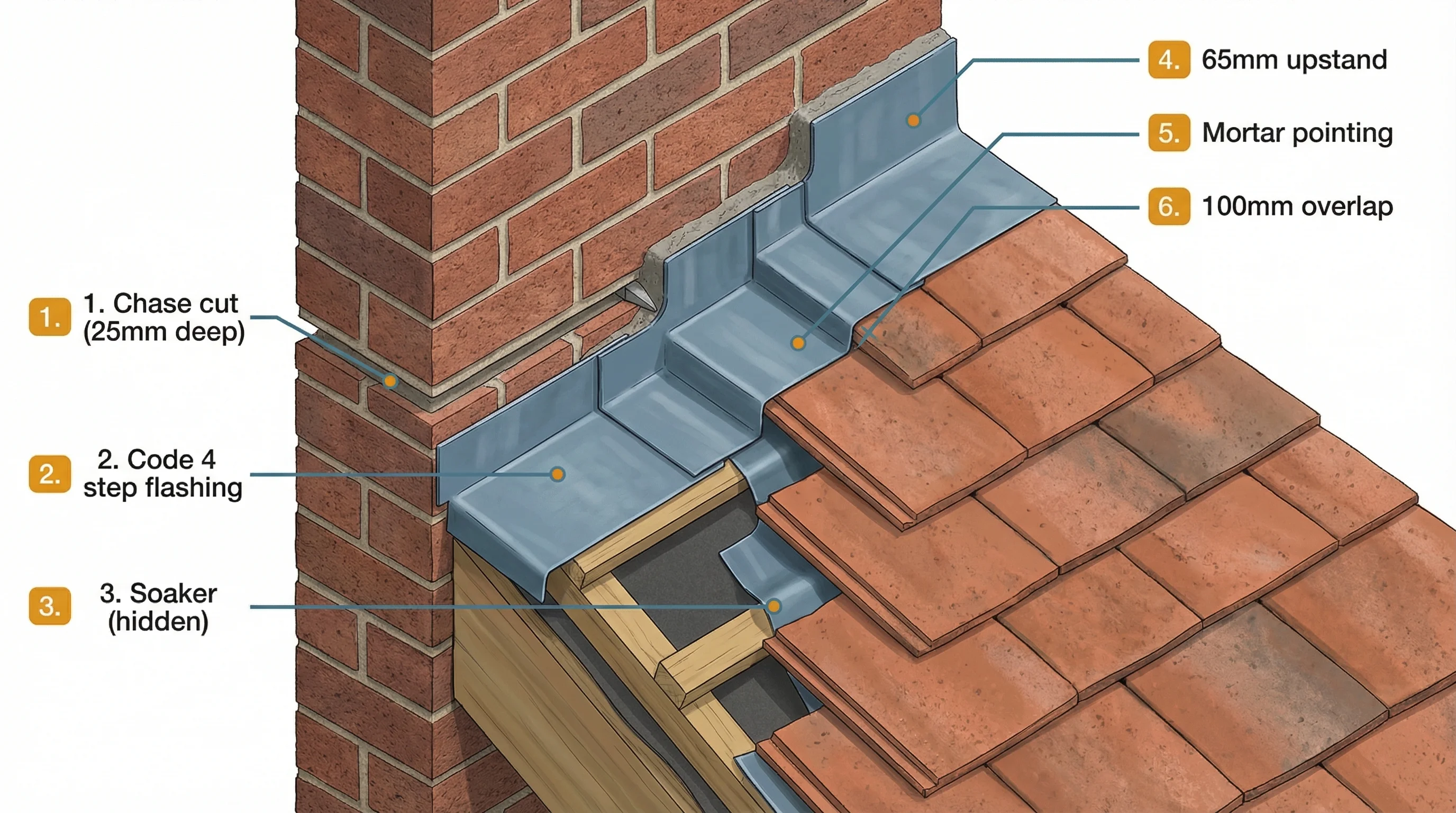

At a side abutment (where a sloping roof meets a wall), you need two layers of lead working together. Soakers are individual pieces of Code 3 lead, one per tile course, tucked under each tile and turned up against the wall behind the step flashing. They're hidden. You never see them on a finished roof. Each soaker is cut to the tile gauge (the spacing between battens) plus 65mm plus 25mm for the overlap, giving a piece roughly 180 to 200mm tall for standard interlocking tiles.

Step flashings (also called cover flashings) are the visible pieces. Made from Code 4 lead, they sit over the soakers, turned into a chase (a slot cut into a mortar joint in the wall) at the top and dressed down over the tiles at the bottom. Each piece overlaps the one below by at least 65mm at each tile course step.

Why do you need both? A single wide piece of flashing pressed against the wall and over the tiles looks like it should work. It doesn't. Wind-driven rain pushes up under the flashing at the tile edge through capillary action (water being drawn into narrow gaps). Soakers block this path because they extend under the tile itself, creating a second line of defence that the water can't reach. LABC (Local Authority Building Control) specifically flags the use of cover flashing without soakers as a common defect.

If your roofer installs a single piece of wide lead flashing at the abutment without individual soakers under each tile course, the junction will leak. This is one of the most common shortcuts on extension roofing work. Every tile course needs its own soaker. No exceptions.

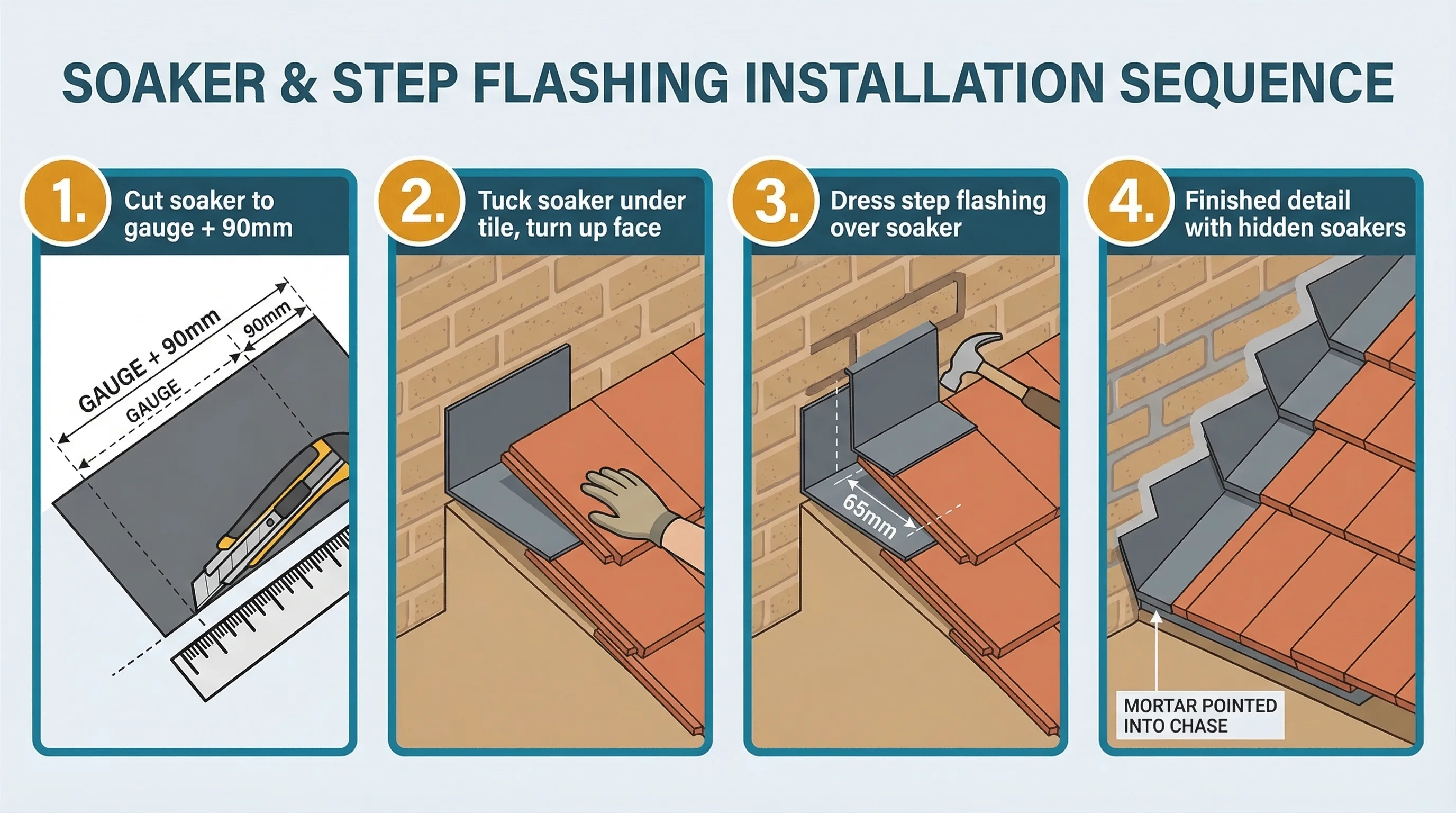

Four stages of soaker and step flashing installation at a side abutment

Chase cutting and fixing

The top of each step flashing turns into a chase cut into a mortar joint (not the brick face) in the existing wall. The chase must be at least 25mm deep. The lead is held in place by lead wedges driven in at maximum 450mm centres, then the chase is pointed up with mortar to seal it.

If the wall is rendered rather than brick, the chase needs to be cut 35mm from the face of the render to allow a 30mm turn on the flashing inside the slot.

Patination oil

New lead is shiny and will develop white carbonate staining (a chalky white deposit) within weeks of installation. This staining washes down onto the brickwork and tiles below, creating unsightly white streaks. It's cosmetic, not structural, but it alarms homeowners and is entirely preventable.

Patination oil is a thin coating (white spirit, silica, soya alkyd resin) applied to the lead surface on the same day it's installed. One even coat with a clean cloth in dry conditions. It allows the lead to develop its natural dark grey patina evenly without the white bloom.

Ask your roofer whether they'll apply patination oil to the new lead. Many don't bother unless prompted. A tin costs under £20 and takes ten minutes to apply. If white staining appears on your brickwork within months of the extension being finished, missing patination oil is almost certainly the cause.

Key installation rules

These come from BS 6915, NHBC 7.2.20, and the Lead Sheet Association:

  • Maximum individual piece length: 1.5m (longer pieces crack from thermal movement)
  • Minimum upstand on wall face: 75mm above the roof surface
  • Minimum cover over tiles: 150mm horizontally
  • Minimum lap between pieces: 100mm (sheltered), 150mm (exposed)
  • Chase depth: minimum 25mm into a mortar joint
  • Wedges/clips at maximum 450mm centres, minimum one per step
  • Use stainless steel or copper clips and wedges only (ferrous fixings corrode and stain)
  • Never nail or screw through the lead sheet (restricts movement, causes fatigue tears)

How much do you need

For a standard extension abutment, the calculation is straightforward.

Measure the length of the abutment (where the new roof slope meets the existing wall). This is the sloping length, not the horizontal distance.

Step flashings (Code 4): Divide the abutment length by 1.4m (allowing for 100mm laps between pieces within the 1.5m maximum). Multiply by the piece length (typically 1.5m). Add 10% wastage. The typical width is 240mm for a standard abutment.

Soakers (Code 3): Count the number of tile courses along the abutment. You need one soaker per course. Each soaker is cut from the same width as the tile gauge plus overlap, from a strip roughly 170 to 200mm wide.

Worked example: a 5m abutment on a single-storey extension with interlocking tiles at 345mm gauge.

  • Step flashings: 5m / 1.4m = 3.6, round up to 4 pieces at 1.5m each = 6m of Code 4 lead at 240mm width. Plus 10% = 6.6m. One 6m roll plus a short offcut from a 3m roll covers it.
  • Soakers: 5m / 0.345m gauge = 14.5, round up to 15 soakers. Each soaker is roughly 435mm long (345mm gauge + 65mm + 25mm overlap) cut from 150mm-wide Code 3 strip. Total Code 3 needed: 15 x 0.435m = 6.5m of 150mm-wide strip.

Buy one extra metre of each code beyond your calculation. Lead offcuts from cutting soakers and step pieces are oddly shaped and you'll waste more than you expect. Leftover lead has scrap value, so nothing is truly wasted.

Cost and where to buy

Lead prices fluctuate with the London Metal Exchange (LME) spot price, which in early 2026 sits around TBC per kg. This means the price of any given roll changes week to week. The figures below reflect early 2026 retail pricing.

ProductRoll sizeApprox. price (inc VAT)Per metre
Code 4, 150mm wide3m roll~£42 (Wickes)~£14/m
Code 4, 150mm wide6m roll~£29 (Roofing Superstore)~£4.80/m
Code 4, 240mm wide6m roll~£51 (Roofing Superstore)~£8.50/m
Code 4, 300mm wide3m roll~£91 (Trade Store)~£30/m
Code 4, 300mm wide6m roll~£59 (Roofing Superstore)~£9.80/m
Code 3, 150mm wide3m roll~£19 (The Lead Lads)~£6.20/m
Code 3, 150mm wide6m roll~£35 (The Lead Lads)~£5.80/m

The pattern is clear: 6m rolls are dramatically cheaper per metre than 3m rolls. For an extension where you need 6 to 8 metres of Code 4, buying two 6m rolls is better value than buying three 3m rolls, even if you have offcuts.

For the abutment on a typical single-storey rear extension (5m sloping length), materials cost roughly £80£150 for the lead alone. Add patination oil (under £20), lead wedges, and mortar for pointing the chase, and you're looking at £80£150 in materials.

Lead flashing materials for a 5m extension abutment (total)

£100£180

Installed by a roofer as part of the roof covering, lead flashing labour is included in the overall roofing price. If you're paying separately for leadwork (chimney re-flashing, for instance), expect £200£300 per day for a specialist leadworker, with most abutment jobs completed in half a day.

Chimney flashings replaced, no scaffold (total)

£350£600

Chimney flashings replaced, with scaffold (total)

£700£1,000

Where to buy

Roofing Superstore, The Lead Lads, and JJ Roofing Supplies are specialist online suppliers with competitive per-metre pricing on 6m rolls. Wickes carries Calder Lead in standard widths and codes. Travis Perkins and Jewson stock Midland Lead and Calder Lead but you'll need to order in rather than expecting it on the shelf.

Both Midland Lead (50-year guarantee on rolled, 60-year on machine cast) and Calder Lead are BS EN 12588 certified UK manufacturers. Stick with one of these. Budget imported lead of uncertain provenance occasionally appears on eBay and Amazon at suspiciously low prices. Avoid it. Non-compliant lead may not meet the thickness tolerance required by BS EN 12588, and your NHBC warranty (if applicable) depends on compliant materials.

Alternatives

Lead-free flashings exist and they're getting better. The main products are Ubiflex B3 (3.5mm thick, 25-year guarantee, BBA certified), Ubiflex Extreme (2.5mm, 30-year UV tested, Class A fire rating), and Wakaflex (butyl rubber with aluminium mesh, 10-year guarantee, stretches up to 50% lengthwise).

They cost roughly the same per metre as lead (£8£15/m for 300mm-wide Ubiflex B3) and they're lighter, easier to cut, and don't require specialist dressing skills. No patination oil needed, no lead health precautions, no scrap value to attract thieves.

Lead (Code 4)Ubiflex B3Wakaflex
Lifespan50-60 years (guaranteed)25 years (guaranteed)10 years (guaranteed)
Theft riskHigh (scrap value)NoneNone
DIY-friendlyNo (specialist dressing)Yes (cut with scissors)Yes (self-adhesive options)
BBA certifiedYesYesYes
NHBC acceptedYes (Code 4 minimum)Case-by-caseCase-by-case
Listed buildingsUsually requiredMay not be acceptedMay not be accepted
Sharp cornersExcellent (malleable)Poor (rigid composite)Poor (flexible but no sharp dress)
Cost per metre (300mm)£8-25 depending on roll£8-15£6-12

The honest answer: for a standard extension where you want it done once and never thought about again, specify lead. The 50-year guarantee is real and lead has centuries of proven performance on UK roofs. For a property in a high-theft area (ground-floor flat roofs, isolated rear extensions), Ubiflex is a serious option because a lead-free roof nobody steals outperforms a lead roof that gets stripped every few years.

Building control will accept lead-free products where they carry BBA certification, but NHBC warranty inspectors are more conservative. If your extension is under an NHBC or equivalent warranty scheme, check with them before specifying an alternative.

Do not let your roofer use self-adhesive "flash band" (butyl tape) as a permanent flashing at any abutment or chimney junction. It's a temporary repair material with a lifespan of a few years. It has no BBA certification for permanent use. If you see silver or grey tape pressed onto brickwork instead of lead dressed into a chase, that's flash band, and it needs replacing with proper flashing.

Checking the finished work

Your roofer has finished the lead flashing. Before you sign off and pay the final retention, check these ten points. You don't need to climb on the roof. Most can be verified from ground level with binoculars or from a first-floor window looking down at the extension roof.

  1. Soakers visible at each tile course. Look at the abutment from the side. You should see a small triangle of lead emerging from under each tile where it meets the wall. If you see one continuous strip of lead instead of individual pieces at each course, soakers are missing.

  2. Step flashing pieces are short. Count the visible steps. Each piece should cover no more than two or three tile courses (1.5m maximum). If you can see one unbroken sheet of lead running the full length of the abutment, it's too long and will crack.

  3. Lead dressed tight to tiles. The flashing should follow the contour of the tile profile with no gaps between lead and tile. Gaps let vermin in and allow wind-driven rain to penetrate.

  4. Chase neatly pointed. The mortar joint where the lead enters the wall should be cleanly pointed. No lead visible above the pointing line. No cracked or missing mortar.

  5. No nails through the lead. Any visible nail or screw heads punched through the lead sheet are a defect. Lead must be held by wedges in the chase and clips, never perforated.

  6. Patination oil applied. New lead should have a slightly oily sheen, not be bright and shiny. If it's gleaming silver, ask your roofer whether they applied patination oil.

  7. Laps go the right way. Water flows downhill. The upper piece must overlap the lower piece, so water sheds off the outside, not behind the flashing. Reverse laps are a serious defect.

  8. 75mm upstand on the wall. The lead should extend at least 75mm up the wall face above the roof surface at every point.

  9. 150mm cover over tiles. The lead should extend at least 150mm horizontally over the tile surface.

  10. No flash band. Look for silver or grey self-adhesive tape anywhere on the abutment. It doesn't belong there.

Safety

Solid lead sheet in roll form is low risk to handle during normal installation. You can pick it up, carry it, and cut it with tin snips with minimal exposure risk. The health hazard comes from lead dust and fumes, which are generated when you cut lead with a grinder, sand it, or heat it with a torch.

Under the Control of Lead at Work Regulations 2002 (CLAW), anyone working with lead must follow basic precautions:

  • Wash hands thoroughly before eating, drinking, or smoking
  • Don't eat or drink in the work area
  • Wear disposable gloves when handling lead
  • If cutting or grinding lead, wear an FFP3 mask (the dust is the danger, not the solid sheet)
  • Change out of work clothes before going home

For a homeowner handling a few offcuts or inspecting finished work, common sense applies. Wash your hands after touching lead. Don't let children handle it. Don't sand or grind it without respiratory protection.

Where you'll need this

  • Roof covering - weatherproofs the junction where the extension roof meets the existing house wall, with Code 4 lead for abutment step flashings and Code 3 for soakers

Lead flashing appears wherever a pitched or flat roof meets a vertical surface. On any extension or renovation project, that means abutments, chimneys, dormers, soil vent pipe penetrations, and valley gutters. The principles are the same regardless of project type.
