buildwiz.ukbuildwiz.uk

Dry Verge Systems: How They Work, What to Buy, and How to Spot a Bad Install

Complete UK guide to dry verge systems for pitched roofs: BS 8612 compliance, brand comparison from £2 – £4 per unit, installation sequence, and homeowner inspection checklist.

Your roofer finishes the gable verge and bills you for the job. Eighteen months later you walk down the side of the house and see a thin grey dribble down the brickwork from the verge line, and one of the verge caps is hanging off in the wind. The roofer either bedded the original verge in mortar that's already cracked, or fitted a dry verge system over old mortar without removing it, and now the units are catching the wind and ripping free. Both are common, both are easy to avoid, and both leave you with staining on the gable wall that needs the verge stripping and refitting properly. On a new extension, a mortar-only verge will also fail building control sign-off under BS 5534. Knowing what a correct dry verge installation looks like saves you from paying for the same job twice.

What it is and what it's for

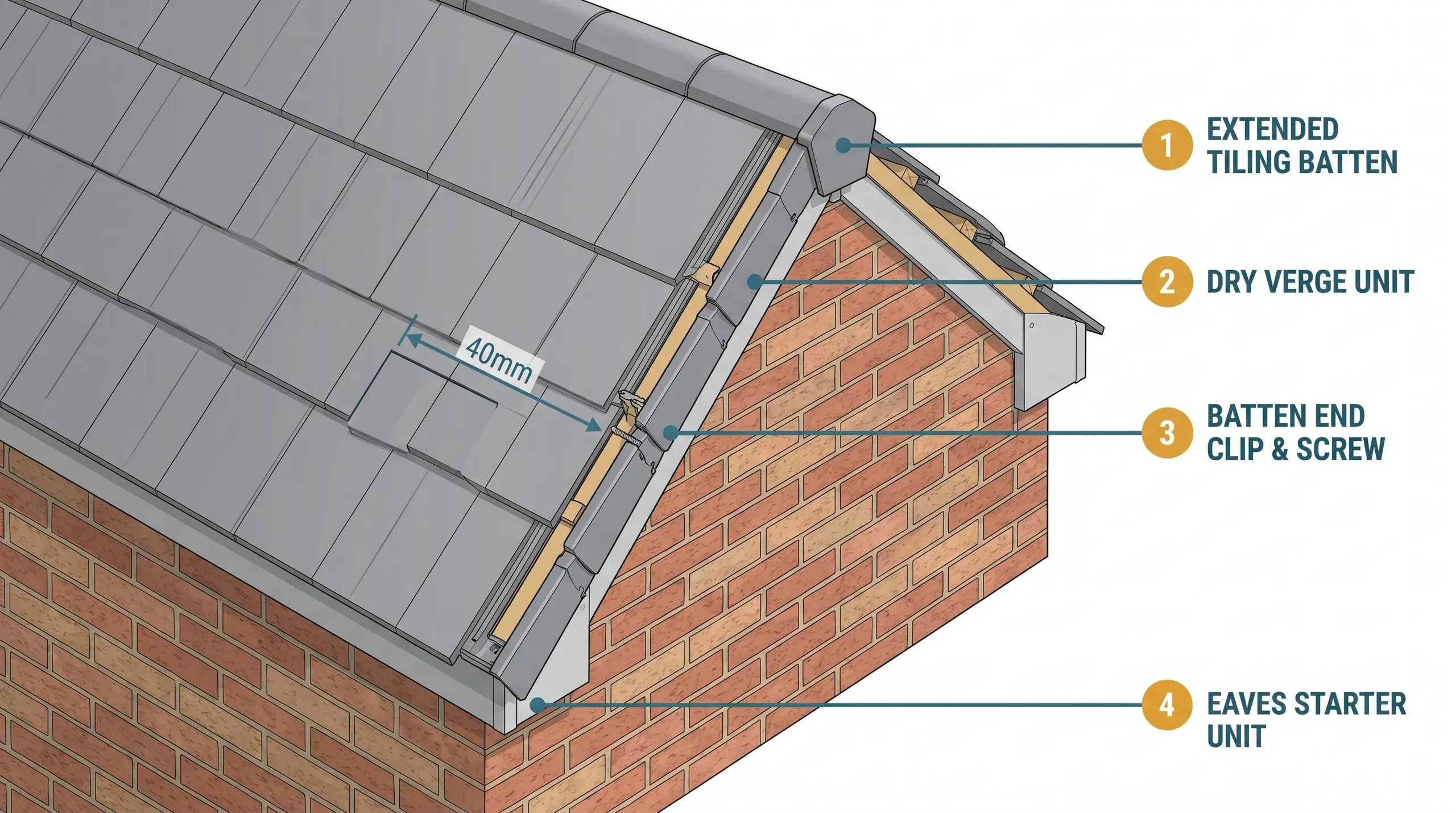

A dry verge system is a kit of plastic or aluminium caps that finishes the gable verge of a pitched tile roof, mechanically fixed to the timber battens and replacing the traditional mortar bedding and undercloak detail. The "verge" is the sloping edge of the roof where the tiles end at a gable wall, the triangular end of the house that the roof slopes down to. Each cap clips over one tile course, the whole run sits against the brickwork or bargeboard, and a continuous drainage channel on the underside discharges rainwater out into the gutter rather than down the gable wall.

For most of the twentieth century, verges on UK pitched roofs were finished with a strip of fibre cement undercloak bedded onto the gable brickwork, with the edge tiles laid on top and the gap pointed up with sand-and-cement mortar. That mortar always fails. Thermal movement, frost cycles, wind loading, and building settlement crack it within five to fifteen years. Once it cracks, water tracks behind the undercloak, edge tiles loosen, and the whole verge needs repointing or rebuilding. A dry verge system removes the mortar entirely. Each cap is held on by a stainless steel screw through a metal clip into the end of a tiling batten, and the system flexes with the building rather than cracking against it.

On any new build or extension, building control expects mechanical fixing at the verge. Mortar alone is not acceptable.

Dry verge vs dry ridge: which one are we talking about?

Homeowners conflate these constantly. A dry ridge system caps the horizontal apex at the top of the roof where two sloping sides meet. A dry verge system finishes the sloping gable edges where the tiles end at the gable wall. Different products, different installation techniques, different positions on the roof. A standard pitched roof with a gable end needs both: dry ridge along the apex and dry verge down each gable slope. If your roofer specifies one but not the other, you'll have mechanical fixing at the top and crumbling mortar at the sides.

Why it's now required

The governing standard is BS 5534:2014+A2:2018, the code of practice for slating and tiling. Since February 2015, this standard has required all ridge, hip, and verge tiles to be mechanically fixed. Mortar alone is no longer acceptable as the primary restraint at any of these positions.

A companion standard, BS 8612:2018, sets the specific performance requirements that any dry verge product must meet. There are four:

  1. Wind load resistance. The system must stay in place under the predicted local wind uplift.
  2. Gap closure. It must close the gap between the tiles and the gable wall or bargeboard top, blocking driven rain, insects, and birds.
  3. Water drainage away from the gable wall. Water that lands on the verge must shed into the gutter, not run down the brickwork.
  4. Mechanical fixing of the verge tile. The unit must act as one of the fixings holding the edge tile in place.

BS 8612 also explicitly bans nailing into the end grain of a tiling batten. End-grain nails pull out under wind load. Fixings must engage with the side or face of the batten via a metal end clip, or use stainless steel screws specified by the manufacturer. Any verge product on the UK market that complies with BS 8612 satisfies the BS 5534 requirement. Look for the BS 8612 compliance statement on the product packaging or datasheet before ordering.

BS 5534 + BS 8612

What about period properties?

There's no formal exemption in BS 5534 for listed buildings or conservation areas, and the standard treats new and re-roofing work the same in principle. In practice, building control bodies have discretion on heritage projects. On a Victorian terrace with a slate roof and lead flashings, plastic dry verge units can look out of place, and your conservation officer may push back on the appearance. A hybrid approach (mortar bedding with discreet mechanical fixings underneath) can satisfy the standard while preserving the look.

If you're working on a listed building or in a conservation area, talk to your local building control and the relevant heritage authority (Historic England, Cadw in Wales, Historic Environment Scotland) before specifying. On standard 1930s-onwards housing stock, dry verge is fine and now expected.

Types of dry verge system

There are three configurations on the UK market. Picking the wrong one for your tile profile is the second most common installation mistake.

Individual interlocking units. Plastic caps roughly 400-500mm long, one per tile course, that clip end-to-end up the gable from an eaves starter unit to a ridge end cap. Most flexible system: works on irregular rooflines, retrofit jobs, and a wide range of tile profiles. The dominant choice for new builds and extensions in the UK. Brands include Klober Uni-Click, Manthorpe SmartVerge, Hambleside Danelaw HDIDV, Glidevale Protect Universal, and Marley Universal.

Continuous PVC strip. A long flexible strip (typically 5m or 6m lengths) that runs the full height of the gable in one piece. Suited to smooth, low-profile rooflines: slate, fibre cement slates, plain tiles, sarking board details. Looks neater than individual units on these roofs because there are no joint lines. Not suitable for high-profile pantiles or double Roman tiles, where the strip can't seal against the tile peaks. Brands include Klober Uni-Line, European Plastics Type R/S.

GRP (glass-reinforced plastic) continuous systems. Heavier-duty continuous lengths used mainly on commercial and high-exposure projects. Typically face-fixed to the bargeboard. Hambleside Danelaw HDL DV6 and DV8 are the common references. Rarely needed on a domestic extension.

For 90% of domestic extension and re-roofing projects, individual interlocking units are the right choice. Continuous strip is worth considering only if you have a slate or low-profile tile and want the cleanest possible appearance.

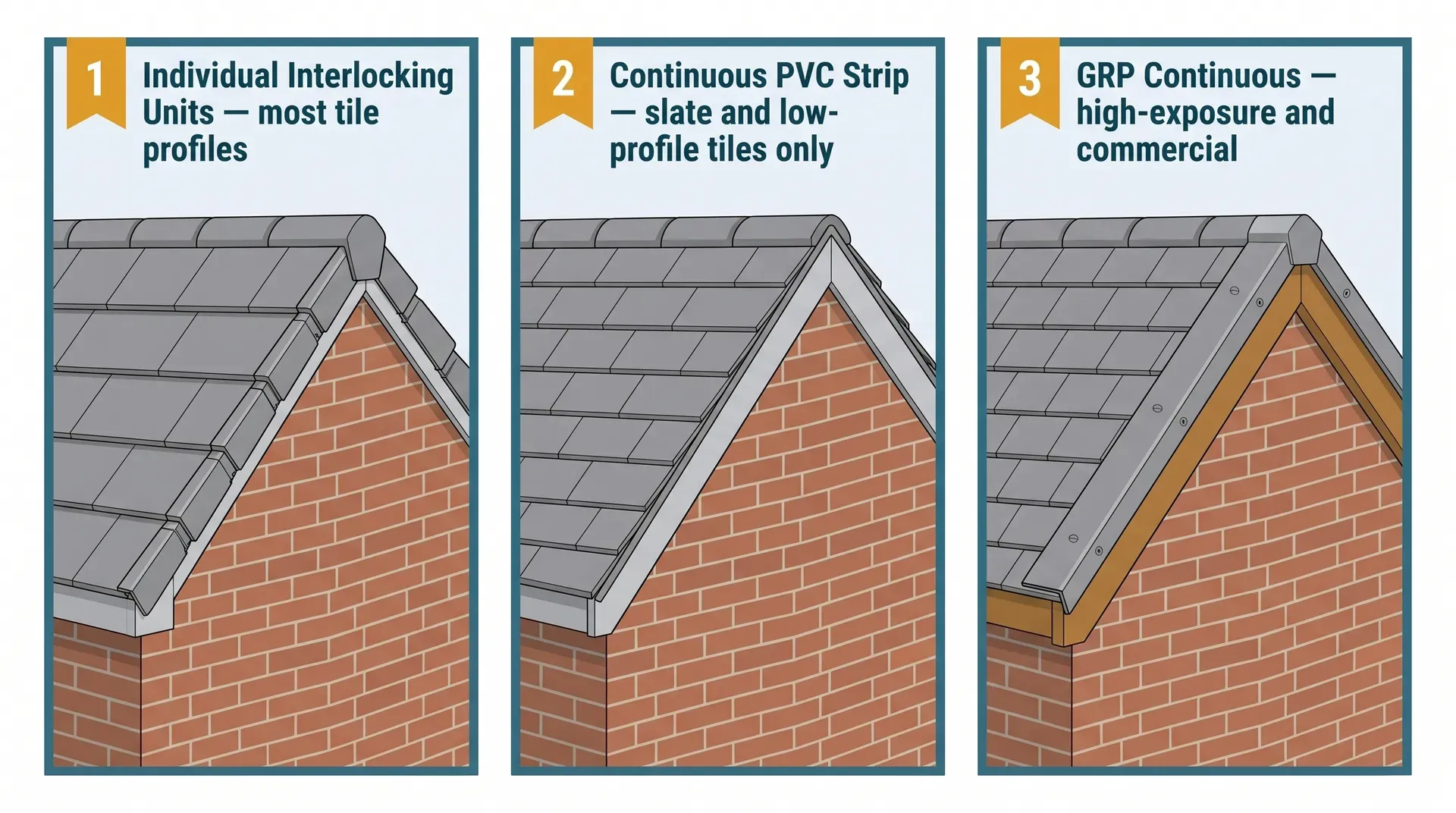

The three dry verge configurations available in the UK, individual interlocking units suit most domestic projects.

Brand comparison

The major UK brands are all BS 8612 compliant. The differences come down to price, tile compatibility, and pack contents. Pricing here is from major roofing merchants in April 2026.

Brand / SystemPrice per unitPack sizeBatten gaugePitch rangeColoursNotes
Manthorpe SmartVerge (Ambidextrous)£2 – £430 per packVariable (handed and ambi options)15°-90°Black, Grey, Brown, TerracottaCheapest mainstream option. Ambidextrous units fit either gable. Strong availability online.
Hambleside Danelaw HDIDV£2 – £450 per pack260-355mm (widest range)15°-90°Antique Red, Black, Brown, Slate Grey, TerracottaMarket-leading 355mm batten gauge. Angular adjustment for sprockets. Left- or right-handed.
Glidevale Protect Universal£2 – £410 per pack315-343mmStandard interlocking tilesGreyStocked at Screwfix in person. Easiest to buy for a single gable. Non-handed.
Klober Uni-Click£10 – £1210 or 40 per pack260-350mm12.5°-90°Brown, Slate Grey, Terracotta, BlackPremium price. UV-stable polypropylene. 40 × 3.5mm stainless steel screws into batten ends per the spec.
Marley Universal Dry Verge£10 – £12Sold per unit287-345mm12°-55°Grey, Brown, TerracottaMatch for Marley tile profiles including Lincoln clay. Two starter units per 28-unit fixing kit. Often out of stock.
European Plastics Type R (continuous)£6 – £135m or 6m stripsConcrete profilesStandard pitchesLimited (mainly black, brown)Cheapest continuous system. Suited to plain tiles and slate, not pantiles.

For most domestic extension work, the Manthorpe SmartVerge or Hambleside Danelaw HDIDV deliver the right balance of price, availability, and tile compatibility. Klober Uni-Click is the premium choice if your roofer prefers it or if you want to match an existing Klober dry ridge system. Marley tiles Universal makes sense when you're already specifying Marley tiles. Glidevale Protect is the easiest single-gable buy because Screwfix stocks it.

Tip

Roofers on DIYnot are split between Klober and Marley as the better-engineered option, with no clear consensus winner. Both meet BS 8612 and both perform well in service. The price difference between economy (Manthorpe, Danelaw) at £2£4 and premium (Klober, Marley) at £10£12 per unit is meaningful, so on a two-gable retrofit you can save materially by going economy without compromising compliance.

What's in the kit and what to order separately

A standard pack of individual dry verge units gives you the caps for one gable run and nothing else. The full installation needs four component types, and most starter packs include only one.

Dry verge units. One per tile course. A typical extension gable has 12-18 courses depending on the gable height and the tile gauge.

Eaves starter unit (or eaves closer). Sits at the bottom of the verge run, screwed to the bargeboard or fascia. Closes the gap at the eaves and provides the anchor point that the first dry verge unit clips onto. Almost always sold separately from the main unit pack. Hambleside Danelaw sells a dedicated 10-pack starter kit at a modest price. Klober and Marley fixing kits include eaves units (Marley provides two starter units per 28-unit fixing kit). The single most common installation defect on UK roofs is the omission of this starter unit.

Ridge end cap. Sits at the top of the verge run where the gable meets the dry ridge. Closes the gap at the apex and prevents water entry at the most exposed corner of the roof. Sold separately. Usually a few pounds per pair.

Batten end clips and stainless steel screws. Some systems (Klober) supply stainless steel screws to drive directly through the dry verge unit into the batten end. Others (Marley, Redland Ambi) use a metal batten end clip nailed or screwed to the batten side, which the dry verge unit then clips onto. Check the manufacturer's specification before you order. The screws or clips usually come in the pack but it's worth checking.

When you place your order, ask for: dry verge units, eaves starter unit/closer, ridge end cap, and confirmation that batten end clips and screws are included. Ordering only the verge units and discovering on installation day that there's no starter is the fastest way to add a week to the job.

How to work with it

You won't be installing this yourself (it's done from a scaffold or access tower at gable height), but understanding the sequence means you can check your roofer's work before they pack up.

Pre-installation: batten extension

Tiling battens must extend beyond the gable wall to give the dry verge unit something to fix to. The exact overhang depends on the system: Klober specifies a minimum of 30mm beyond the gable wall when using a batten end clip; Redland Ambi and most retrofit systems need 45mm; some installation guides quote 50mm. The right answer is whatever the manufacturer's data sheet for your chosen system says. 30-50mm is the working range.

On a new build, the battens must be extended before tiling starts. You cannot easily extend battens once the tiles are laid because you'd have to lift the edge tiles to access the batten ends. On a retrofit, the existing battens often need to be cut back and replaced or sistered with new timber to achieve the correct overhang. This is part of the reason retrofit verge installations cost more than new build.

Retrofit: strip the old mortar first

If you're converting an existing mortar verge to dry verge, every trace of old mortar and the fibre cement undercloak must be stripped off before the dry verge goes on. This is the most common installation failure on retrofit jobs. Roofers sometimes try to fit dry verge over the existing mortar to save time. The verge units sit proud of where they should, the wind catches them, and within months they rip off and slide down the gable.

Old undercloak strips, mortar, and any loose tile bedding all come off. The edge tiles get inspected for damage and replaced if cracked or chipped. Battens get extended (or replaced) to the right overhang. Only then does the dry verge installation start.

Installation sequence

The system goes on from the eaves up to the ridge.

First: fix the eaves starter unit. Screw it to the bargeboard or fascia at the bottom of the gable. Some systems screw direct into the brickwork.

Second: clip the first dry verge unit onto the starter. Align it with the first batten end clip and drive the stainless steel screw (or nail) through the clip into the batten side. Each unit also clips into the unit below it via an interlocking lug, so the assembly becomes a continuous restrained run.

Third: work up the gable course by course. Each new unit engages with the lug of the unit below, slides up to align with its batten end clip, and gets fixed with a screw. A competent roofer fits 12-18 units in around 1-2 hours per gable on a new build.

Fourth: fit the ridge end cap. The final cap closes the apex corner. On a hipped roof with no gable, you don't have verges at all (you have hips, which need a different detail).

Warning

Use a string line from eaves to ridge before fitting the units, and check alignment from ground level every 3-4 units. The most visible installation defect from the street is a verge run that bows in or out from a true line. Once all the units are clipped together it's hard to correct, so the alignment check during installation is what stops a wonky finish.

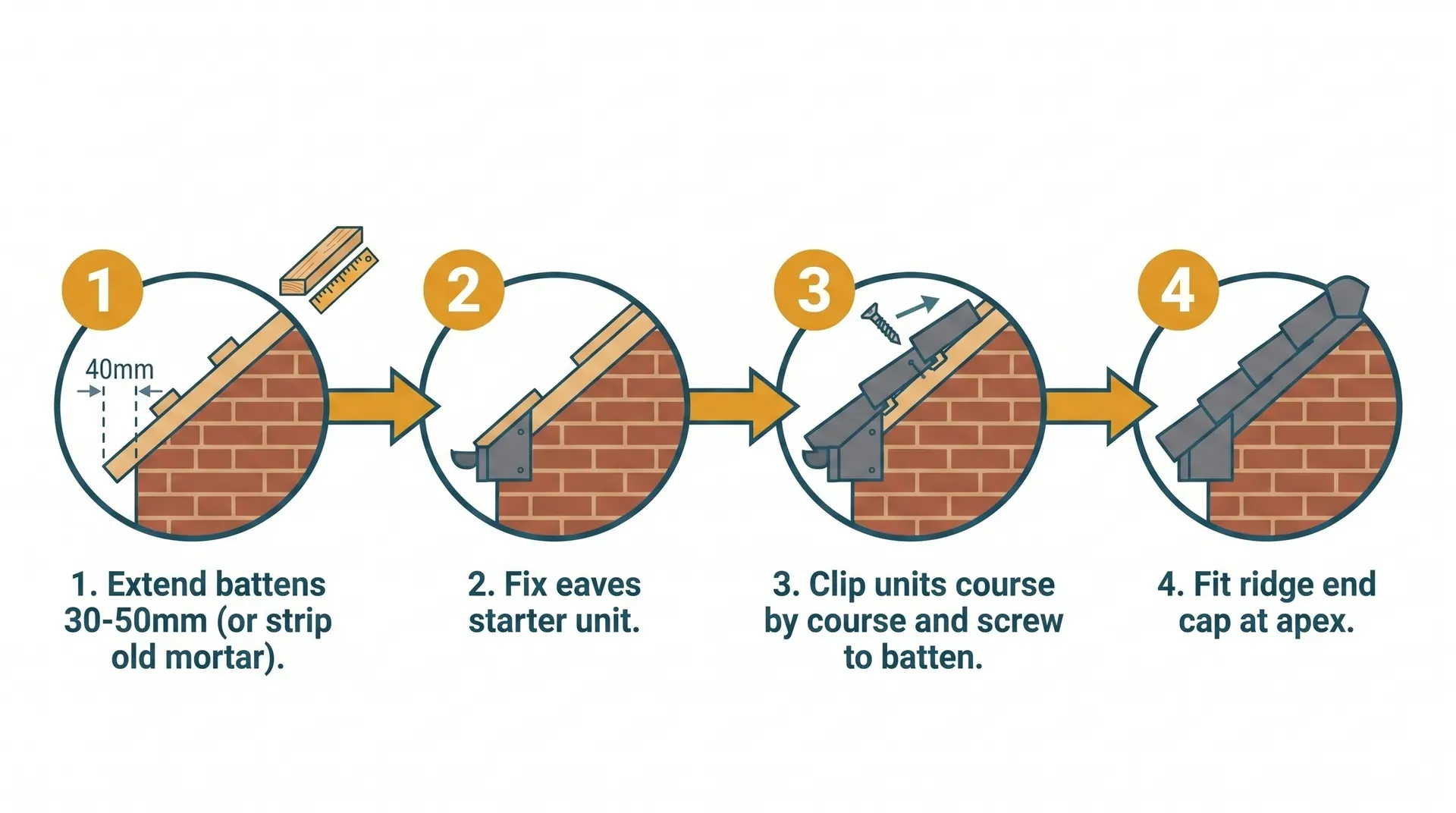

The four-step installation sequence from extended battens to completed ridge end cap.

How much do you need

For individual interlocking units, the calculation is straightforward.

Step 1: count the tile courses on the gable. Either count them directly, or measure the gable height (eaves to ridge) and divide by the tile gauge (the spacing between batten centres, usually 287-345mm for standard interlocking tiles, slightly less for plain tiles).

Step 2: add 1 for the eaves starter and 1 for the ridge end cap.

Step 3: add 10% wastage for breakage and offcuts.

Worked example. A 4m high gable with a 320mm tile gauge has 4000 / 320 = 12.5 courses, round up to 13. Add 1 starter and 1 ridge end cap = 15 units total. Add 10% wastage = 17 units. For one gable. For a semi-detached house with two gables, double it to around 34 units.

Order the eaves starter unit and ridge end cap separately unless your chosen brand explicitly includes them in the pack. They're cheap and easy to overlook, and ordering them at the same time as the main units saves a delivery delay.

For continuous PVC strip, divide the gable height in metres by the strip length (usually 5m or 6m), round up, and add 10% wastage. A 4m gable needs one 5m strip per side. A 7m gable needs two 5m strips per side, with significant offcut.

Tip

If your gable height is awkward (say 4.2m, just over a 5m strip's reach), specify individual interlocking units rather than continuous strip. Continuous strip generates a lot of offcut on awkward dimensions, while individual units have minimal waste because each unit serves exactly one tile course.

Cost and where to buy

Dry verge unit, individual (Manthorpe, Danelaw, Glidevale Protect)

£2£4

Dry verge unit, individual (Klober Uni-Click, Marley Universal)

£10£12

Dry verge continuous PVC strip

£6£13

For a typical two-gable semi-detached extension, materials run to £60 – £120 per gable. Add labour and access (scaffold or tower) and a full installation comes in at £450 – £1,015 for a semi-detached house, with London and the South East adding 20-30% on top.

Dry verge installation, complete two-gable semi-detached job

£450£1,015

The labour rate per linear metre runs £10 – £30. The lower end applies to new build where the battens are already extended; the upper end covers retrofit work with mortar removal, edge tile inspection, and batten replacement. Scaffolding for a two-storey property adds several hundred pounds; a mobile access tower is a cheaper alternative on single-storey extensions.

Where to buy

For single packs and small jobs, Screwfix stocks Glidevale Protect Universal at a competitive price for a 10-pack, the cheapest way to buy a small quantity in person. Roofgiant, Roofing Megastore, DryVerge and Roofline Direct, and JJ Roofing Supplies are the online roofing specialists with the widest range across all the major brands, and typically beat builders' merchants by 10-20%, particularly on Klober and Manthorpe kits.

For larger orders alongside the rest of your roofing materials, Travis Perkins, Jewson, and SIG Roofing carry the full range and can advise on tile profile compatibility. They're often more expensive than the online specialists but the convenience of one-order roofing supply matters when the rest of your tile order is going through them.

Your roofer will usually quote for the dry verge as part of the overall roof covering price. Check what brand they're specifying. If the quote says "dry verge supply and fit" without naming a system, ask. The price difference between economy and premium is real, and so is the difference between a system that includes the eaves starter and one that doesn't.

Cost compared to mortar verge

The headline upfront cost of dry verge is higher than a wet mortar verge: materials for a dry verge gable are roughly double the cost of mortar and undercloak for the same gable. Where dry verge wins is lifetime cost.

A mortar verge typically needs repointing every 5-15 years (3-5 years on exposed sites, longer in sheltered locations). Each repoint involves trade time and scaffold costs per gable. Over a decade, a dry verge installation with no maintenance and a 20-30 year lifespan comes out ahead in like-for-like terms against repeated repointing cycles.

On a new extension where you're paying for the install once anyway, the upfront cost difference is small enough to ignore and the maintenance saving compounds. On a retrofit, the calculation is closer because you're paying for scaffold and labour either way, but dry verge still wins over the medium term.

Alternatives

The only real alternative is traditional mortar bedding with mechanical fixings, the hybrid method that satisfies BS 5534 by using stainless steel nails or screws driven through the mortar bed into the timber batten or the gable wall. This approach is most often used on heritage properties where the appearance of plastic dry verge units would clash with the building.

For a standard 1930s-onwards extension, a dry verge system is the right specification. Building control expects it, BS 5534 effectively requires it on new work, and it'll outlast a mortar verge by decades.

A second alternative occasionally promoted is a clip-on metal verge profile (aluminium or galvanised steel). These are uncommon on UK domestic projects and mainly seen on commercial flat-to-pitch transitions. Not generally a homeowner choice.

Where you'll need this

  • Roof covering - mechanical fixing system for verge tiles, required by BS 5534 on any new pitched roof or roof refurbishment

These systems appear on every pitched-roof project with a gable end, whether that's a new extension, a re-roof, or a like-for-like verge replacement. They pair with dry ridge systems at the apex, sit on top of concrete roof tiles or clay roof tiles, and rely on tiling battens being extended correctly before tiling starts.

Common mistakes

The community research on this topic is unusually consistent: the same handful of installation failures appear across DIYnot threads, roofer Q&As, and trade body guidance. None of them are exotic. All of them are checkable from ground level with a pair of binoculars after the work is done.

No starter unit at the eaves. The single most common defect. A dry verge run without an eaves starter has an exposed gap at the bottom that lets water track behind the verge, allows birds and wasps to nest under the tiles, and leaves the entire run unsupported at the base. Walk to the bottom of each gable and look up. You should see a closed cap, not a gap.

Old mortar left in place. On retrofit jobs where the roofer fitted the dry verge over existing mortar bedding rather than stripping it first, the units sit proud of the tile surface and catch the wind. They tear off in storms within a year or two. Look at the verge profile from the side: the units should sit flush against the edge tiles. If you can see a visible gap underneath the run, the mortar wasn't removed.

Batten ends not extended far enough. If the battens stop short of the gable wall, the dry verge units have nothing to screw into, and the roofer either nails into batten end grain (banned by BS 8612, the nail will pull out) or screws into the brickwork (also wrong). On a finished installation you can't see the batten extension, but if the units rattle in wind or the ridge end of the run is visibly lifting, this is often the underlying cause.

Wrong system for the tile profile. Continuous PVC strip on a high-profile pantile roof leaves gaps where the strip can't seal against the tile peaks. Plain-tile dry verge on an interlocking concrete tile fits the wrong batten gauge. Both result in visible gaps and water ingress. The brand's compatibility chart is the source of truth here, not the roofer's preference.

Water draining onto the gable wall, not into the gutter. The whole point of the drainage channel on the underside of a dry verge unit is to discharge water away from the brickwork and into the gutter. If the units are fitted upside down, the wrong way round, or with the drainage channels blocked by leaves or debris, water tracks down the gable wall and stains the brickwork. A dark dribble pattern below the verge a year after installation is the giveaway.

Missing ridge end cap. Where the verge meets the ridge, the corner is the most exposed point on the entire roof. Without a ridge end cap, water blows in. The cap is a low-cost component that's easy to forget but essential.

Warning

NHBC and building control inspections do not reliably catch dry verge installation defects. Forum reports document NHBC-signed-off new builds with missing starter units, mortar left in place, and visible gaps at the eaves. The sign-off does not absolve the contractor of liability, but it doesn't help you spot the problem either. Walk every gable yourself with binoculars after the verge is finished and before you sign off the job. The first few months of a newly fitted dry verge are when defects show up.

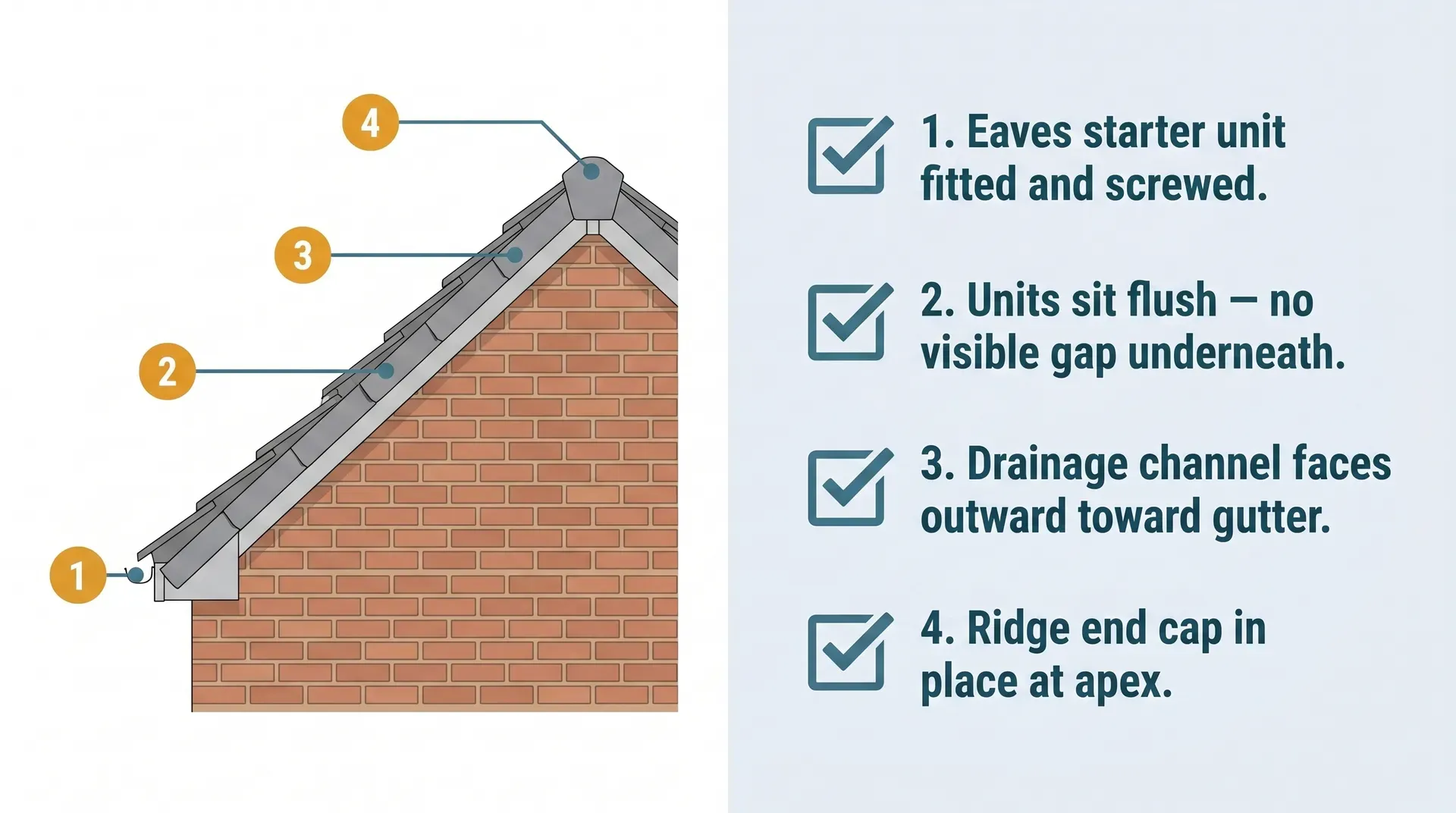

Four checks to run from ground level with binoculars after the verge is finished.
