Tie Wire: The Cheapest Material That Holds Your Foundation Together
UK guide to rebar tie wire. Black annealed 16-17 gauge, how much you need, tying methods, BS 7973-2 frequency rules, wire selection, and what to buy. From £8 – £15 per 2kg coil.
By IanLast updated
Project managed a £182k Oxfordshire kitchen extension
A reinforcement cage can look complete until the inspector spots untied intersections or wire ends left proud and cancels the pour. The material needed to fix it costs pennies, but the delay burns labour, concrete bookings, and programme time. Tie wire has no glamour and almost no value once the concrete cures, yet it is the small detail that keeps the reinforcement in the exact place the design depends on. Done properly, nobody notices. Done badly, the pour stops.
Tie wire is the least glamorous material on a reinforced concrete pour. It's also the one that, when done badly, most reliably costs you a delayed pour. Get it right and nobody notices. Get it wrong and the inspector spots it before you've finished offering them tea.
What it is and why annealed matters
Tie wire is soft, low-carbon steel wire used to bind rebar intersections and mesh overlaps so the reinforcement cage holds its shape during the concrete pour. Once the concrete sets, the wire has no structural job. The concrete grips the bars, the bars carry the loads, and the wire is just along for the ride. That's the single most important thing to understand: the wire holds position, not load.
The wire used in UK construction is "black annealed". Two words, both worth explaining.
"Black" means uncoated. The wire is bare steel with a thin layer of mill scale on the surface, which gives it a dull dark grey appearance. No paint, no plastic, no zinc plating. Use the wire specified for the reinforcement system; coating compatibility should not be guessed.
"Annealed" means heat-treated to soften the metal. Wire fresh from the drawing process is hard and springy, which is hopeless for tying because it springs back the moment you let go. Annealing heat-treats the wire, leaving it soft enough to twist tight by hand without snapping. You can feel the difference if you ever pick up hard-drawn fencing wire by mistake. It bends but won't stay bent.
Black annealed wire is a common choice for ordinary carbon-steel reinforcement. Use the specified tie material, especially with coated or stainless reinforcement.

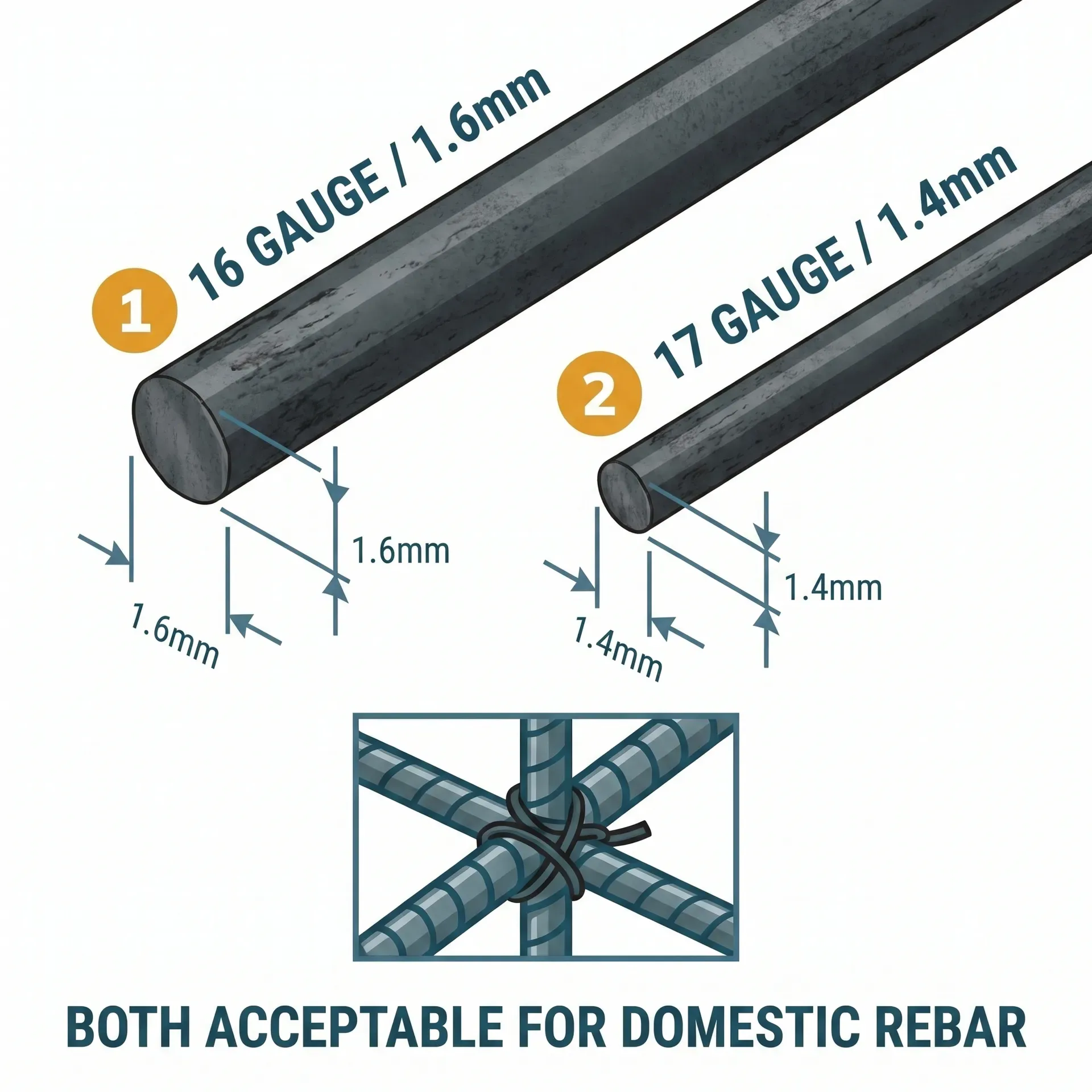

Gauge and diameter
Two gauges dominate the UK market and they're often used interchangeably in product listings: 16 gauge (1.6mm diameter) and 17 gauge (1.4mm). Both are sold widely. Both are acceptable for domestic rebar and mesh tying. The difference between them is small enough that several UK suppliers list the same model code under both designations.
The thinner 17 gauge is easier to twist tight by hand, which matters when you're tying hundreds of intersections in a single afternoon. The thicker 16 gauge is marginally stronger and slightly more forgiving if you over-twist and start to notch the wire. For T12 and T16 rebar in standard domestic foundations, either gauge does the job. If your engineer has specified larger bars (T20 and above) the 16 gauge is the safer choice.
What you cannot do is use ordinary fencing wire, baling wire from the farm yard, or any general-purpose wire. The gauge needs to be right and the wire needs to be annealed. Anything stiffer either snaps when you twist it or won't hold the twist tight against the spring of the bars.
How much you actually need
The construction industry's rule of thumb is 9 to 13 kg of tie wire per tonne of reinforcement. The variation comes from bar size: smaller diameter bars mean more bars per tonne, more intersections, and more wire. The Lemon Groundwork Solutions calculation puts 1 tonne of 8mm bar at roughly 12 kg of wire, and 1 tonne of 32mm bar at roughly 7 kg.
For a typical domestic extension, you're nowhere near a tonne of rebar. A standard 4m by 6m strip foundation with two T12 bars along the bottom of the strips uses about 40 to 45 kg of steel total. Multiply that by 9-13 kg of wire per tonne and you need about 0.4 to 0.6 kg of wire for the whole job. A single 2kg coil is more than enough. Most homeowners doing a single extension end up with three quarters of a coil left over.
For a single domestic extension foundation, buy a 2kg coil. You will use less than half of it. Buying an 8kg trade coil is overkill and the leftover wire rusts in the shed before you ever use it again.
The rule of thumb breaks if you're using mesh reinforcement instead of loose rebar. Mesh sheets need ties along the lap zones (where sheets overlap by the distance specified in the reinforcement design); the intersections across the body of each sheet are welded at the factory and need no ties. A standard 4.8m by 2.4m A193 sheet has hundreds of intersections, but you only tie the ones in the laps. Budget on the same 9-13 kg per tonne rule and you will not run short.
What BS 7973-2 actually says about tying frequency
There's a British Standard for this, and it's surprisingly specific. BS 7973-2:2001 is the governing document for fixing and applying spacers, chairs, and tying of reinforcement. It's not a document homeowners typically read, but the rules it sets are what your structural engineer and building control officer are working to.
The headline frequency rules:
| Element | Tying frequency | Notes |
|---|---|---|
| Slab perimeter bars | Every intersection | Edge bars hold the cage shape and resist lateral movement during the pour |
| Slab interior bars (≤20mm diameter) | Alternate intersections | Chequerboard pattern is acceptable for body of mat |
| Slab interior bars (≥25mm diameter) | Maximum 50× bar diameter centres | Heavier bars need fewer ties because they don't shift as easily |
| Laps | Follow the specified tying arrangement | Hold the designed overlap and bar position during placing |
| Columns | Every vertical-bar-to-link intersection | Columns carry concentrated loads, no shortcuts |
| Foundation starter bars | Follow the reinforcement drawing | Secure the specified position and projection |
Check the fixing arrangement against the reinforcement drawing, especially around edges, laps and starter bars. The cage must retain its designed shape and cover during placing.
Between the perimeter bars of a loose-bar mat, tying alternate intersections is fine for bars up to 20mm (welded mesh needs no ties in the body of the sheet). The cage is mostly self-supporting once the perimeter and laps are locked.

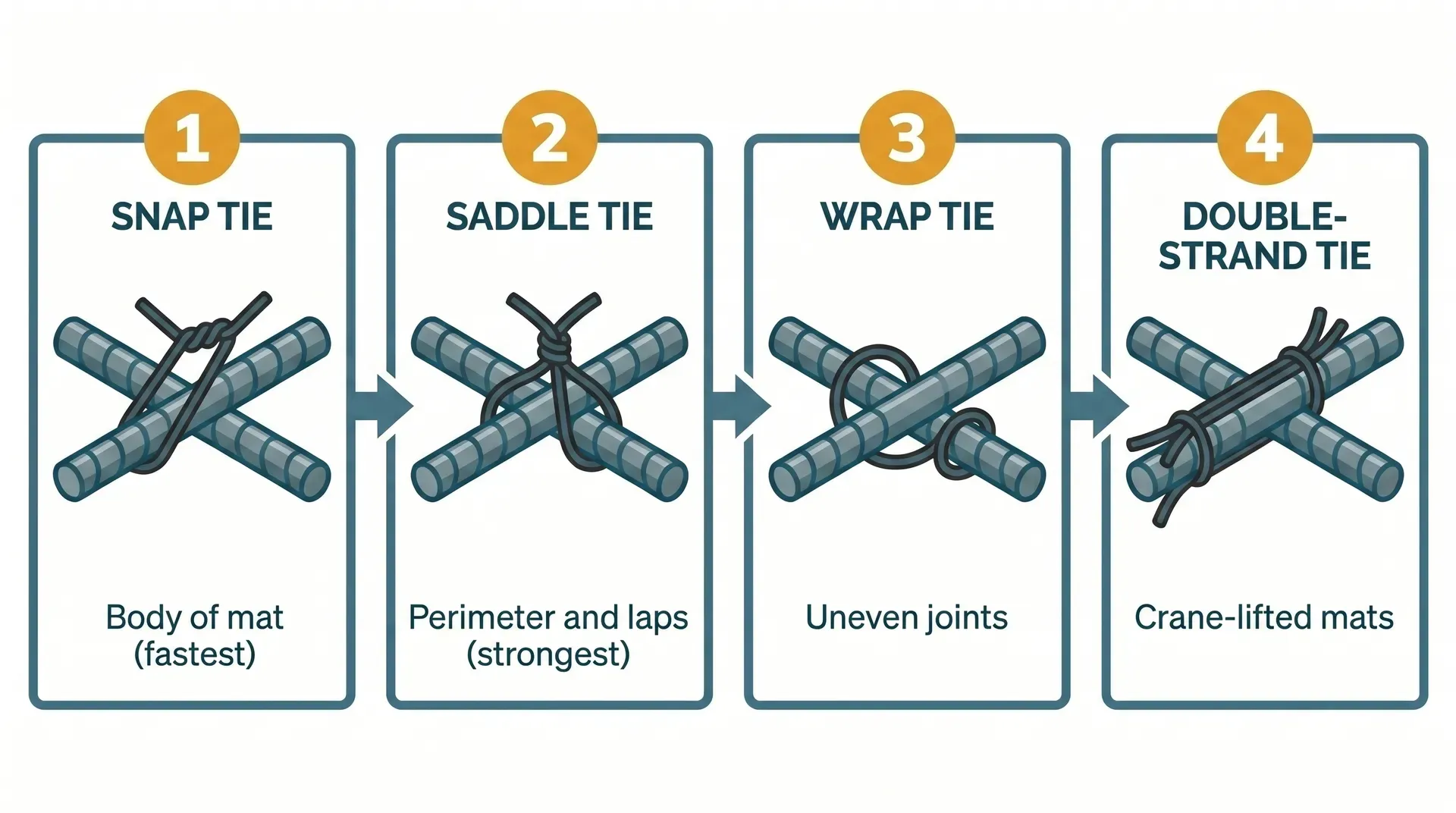

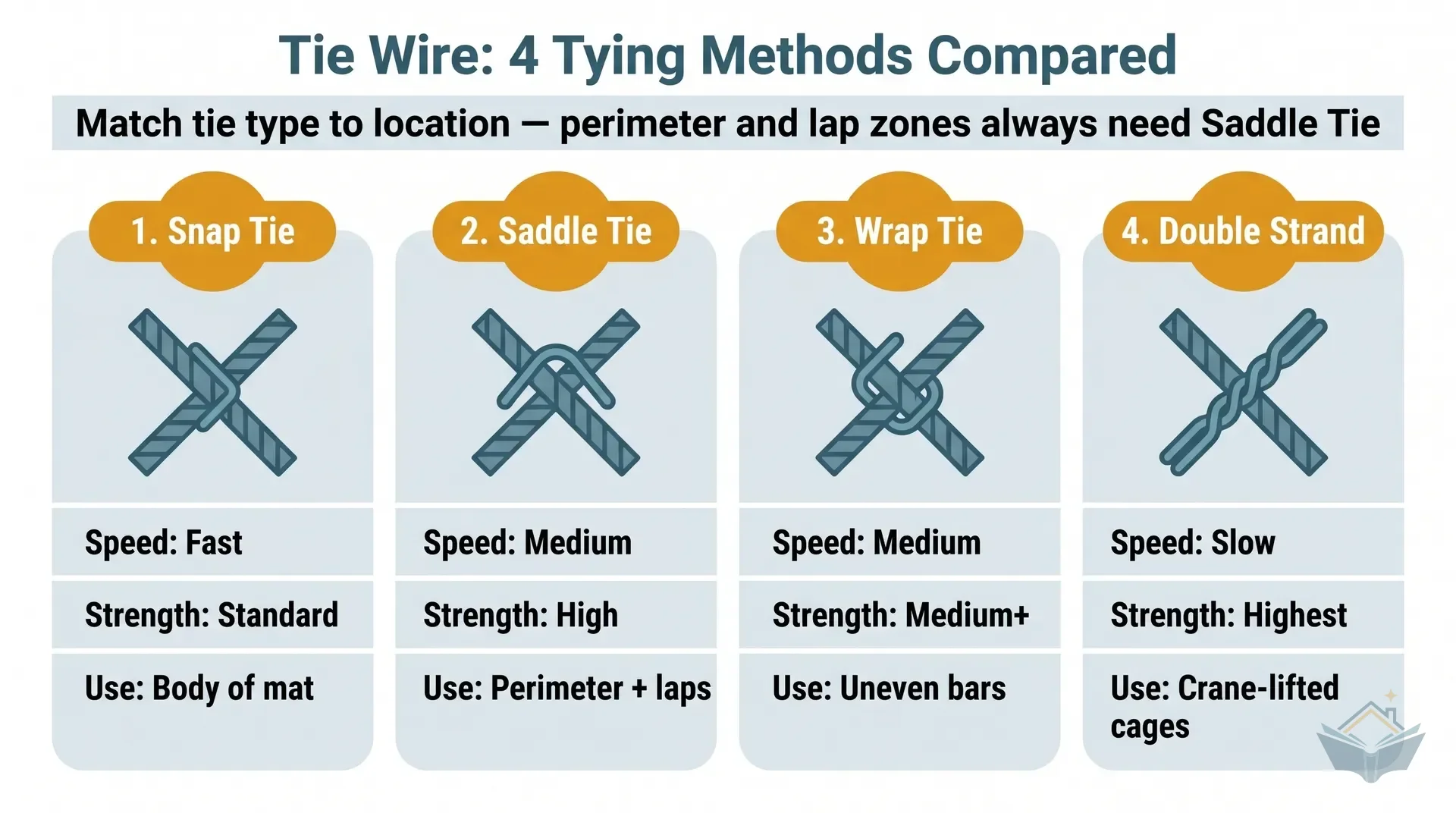

The four basic tying methods
There are dozens of named ties used in international reinforcement codes, but four cover almost every domestic situation. Knowing which is which lets you understand what your groundworker is doing and spot when they're cutting corners.
Snap tie. The fastest and most common. The wire is folded in half, looped diagonally over the bar intersection, and the two ends are gripped together with pliers and twisted three or four turns. The single twist sits diagonally across the intersection. Used for the body of slabs and wherever speed matters more than ultimate hold strength.
Saddle tie. The wire wraps over the top of the upper bar, down both sides of the lower bar, and the ends meet at the top to twist together. Stronger than a snap tie because the wire fully encloses both bars. Used at perimeter intersections, lap ends, and column links where the connection has to survive the pour.
Wrap tie. The wire makes one and a half turns around the intersection before twisting. Used where you need a snap tie's speed but a bit more grip, typically on rebar that's been straightened by hand and isn't quite sitting flush.
Double-strand tie. Two pieces of wire used in parallel, twisted together as one. Used when a heavy mesh mat is being lifted by crane and the ties have to hold the cage together against the lifting forces. Domestic foundations almost never need this.
How to tie a snap tie by hand
The technique is easy to describe and surprisingly hard to get right the first dozen times. Here's the practical sequence.
Cut a 200-250mm length of wire. Most groundworkers cut a stack of these in advance, holding them in one hand or stuffing them into a back pocket. Some use pre-cut double-loop ties bought in packs of 1000. Either works.
Bend the wire roughly in half so it has a U shape. Slide the loop end under the lower bar at the intersection, then bring it up the far side and over the top of the upper bar. The two free ends should now be on your side of the intersection.
Grip both free ends with side-cutter pliers (also called nippers or tying pliers). Pull the wire tight against the intersection so there's no slack. With the pliers gripping the ends, twist your wrist three or four full turns until the wire bites tight onto both bars. You'll feel the resistance increase as the twist tightens.
Cut off the excess with the same pliers. Leave a 10mm tail. Critically, fold this tail down and inward, away from the surface of the concrete. Wire ends pointing toward the formwork or trench wall are the single biggest reason inspectors fail tying work. Fold them in.
Warning
Wire ends sticking up toward the concrete cover zone create a corrosion path from the surface to the bar. Once the concrete sets, those tails rust within months and rust streaks appear on the finished surface. NHBC Standards explicitly require that no ties or clips protrude into the cover zone. Fold every tail inward.
The whole sequence takes about 10 seconds for a fast groundworker. Slower for a first-timer. A typical foundation has 100-200 ties. Budget 30-60 minutes for the tying work alone, and longer if you're learning.
Tools for tying
Hand pliers are the bottom of the range. A pair of side-cutter pliers from any builders' merchant does the job for under twenty pounds. They cut wire and twist it. For a single domestic foundation, this is what most homeowners use.
A retractable hook tool speeds things up significantly when you have hundreds of ties to make. The tool is a 300mm steel handle with a hook on the end that engages with pre-cut double-loop ties and twists them tight by pulling the handle. It runs around £10 – £21 from a reinforcement specialist. It pairs with double-loop pre-cut ties at £21 – £27 per pack of 1000. For a busy week of foundation tying, the hook tool is genuinely faster than pliers. For one extension, hand pliers work fine.
The MAX TwinTier RB443T is the cordless automatic tying tool used on commercial sites. It positions itself over the intersection, fires a pre-loaded wire coil around the bars, twists it tight, and cuts the tail automatically. MAX advertises up to 5,000 ties per battery charge; actual output depends on the work. The price tag is £2,100 – £2,310. Not a domestic-buyer item. If you're working on something at the scale of a commercial slab and you want one, it's available to hire from groundwork tool hire companies for the week. For a 4m by 6m extension, ignore it.
Tip
A pair of decent side-cutter pliers and a 2kg coil of wire is the right kit for a single domestic extension. Total spend under thirty pounds. Don't overthink it.
Choose wire for the reinforcement system
Use the tie-wire material specified by the designer or reinforcement supplier. Black annealed wire is a common choice for uncoated reinforcing bars; other systems can require a compatible coated or stainless wire. Do not infer suitability from fencing-wire packaging or assume all galvanised tying wire is prohibited.
Storage: the unforgiving detail
Black annealed wire is uncoated steel. It rusts. Fast.
A coil of fresh tie wire opened on a damp morning will have surface rust by afternoon. A coil left in an unheated shed for a winter will be rusty enough that the rust scales off when you try to twist it. The standard advice is to use the coil within a week of opening it.
Store unopened coils in a dry place at room temperature. Don't leave them in the van overnight in winter. Don't store them on a concrete floor where ground moisture wicks up. A shelf in a heated garage or utility room is fine.
If your wire has surface rust when you open the coil, it's still usable as long as the rust is light and brushes off. If the wire has flaky scaly rust or pitted surface corrosion, it's compromised and the wire will snap when you twist it. Discard and buy new.
Cost and where to buy
Tie wire is one of the cheapest items on a build. The total spend for a domestic extension foundation is rarely over fifteen pounds.
| Format | Typical supply price (inc VAT) | Best for |
|---|---|---|
| 2kg coil (small) | £8 – £15 | Single domestic extension foundation - the right size for most homeowners |
| 8kg coil (trade) | £14 – £32 | Multiple foundations, raft slabs, larger projects with lots of rebar |
| 10kg coil | £23 - £29 | Trade groundworkers and small civils contractors |
| Double loop pre-cut ties (pack of 1000) | £21 – £27 | Use with a manual hook tool for speed on repetitive work |
For a single 2kg domestic coil, expect to pay £8 – £15 at most UK suppliers. Trade-priced 8kg coils run £14 – £32 depending on whether you're buying from a high-street merchant or an online specialist.
The cheapest source is online reinforcement suppliers like Reinforcement Products Online and Next Day Steel. They sell to trade and public, deliver next day, and price below high-street merchants. Parker Steel, BS Fixings, CMT, and Devoran Metals are reliable alternatives.
Travis Perkins and Jewson stock tie wire but at higher prices and not always in 2kg sizes. Screwfix and Toolstation generally don't stock proper rebar tie wire because the volume isn't there for their typical customer base.
External resource
Reinforcement Products Online
The cheapest UK online source for black annealed tie wire. Sells coils from 1.5kg up to 10kg with next-day delivery. Trade-grade material at the lowest market price.
reinforcementproductsonline.co.uk
Where to buy Tie Wire
Check current prices from UK suppliers.
These are affiliate links: if you buy through them we may earn a small commission, at no extra cost to you. Learn more.
What can go wrong: the common mistakes
Wire ends sticking up. The single most common defect on inspected reinforcement. Wire tails pointing toward the trench wall or formwork face create rust streaks once the concrete sets and reduce the cover. Always fold tails inward, away from the concrete surface.
Skipping perimeter intersections. BS 7973-2 requires every perimeter intersection to be tied. If your groundworker is moving fast and tying every second perimeter intersection, the cage edge isn't locked. The first concrete pump pulse can shift the perimeter bars, leaving an unreinforced strip along the edge of the foundation.
Skipping lap intersections. Laps are where two bars overlap to behave as one continuous bar. Tie the lap zone to the reinforcement designer’s specified pattern so the bars remain in their designed positions during concreting. A poorly tied lap can separate during the pour and the structural design assumption (continuity through the lap) is broken.
Using unsuitable tying wire. Fencing wire is too stiff and snaps when twisted. Use the tie material specified for the reinforcement system.
Buying an 8kg trade coil for a 4m by 6m extension. Half a kilo of wire goes into the foundation. Seven and a half kilos rust slowly in the shed. Buy a 2kg coil.
Leaving wire offcuts in the formwork. Loose wire ends, snipped tails, and dropped pieces of wire all rust in the formwork and create surface stains on the finished concrete. Sweep the formwork before the pour.
Warning
Loose wire pieces left in the trench or formwork before the pour create rust spots on the finished concrete surface. The Concrete Society explicitly identifies dropped tying wire as a cause of localised surface staining. Sweep the trench bottom before the concrete arrives.
Concrete cover and why the wire matters to it
Cover is the distance between the rebar and the nearest concrete face. It's what protects the steel from corrosion. NHBC Standards 2024 section 3.1.9 Table 8 gives cover for concrete not designed by an engineer of 75mm for concrete cast directly against soil, 50mm for external exposed conditions, 40mm over blinding or DPM, and 25mm for protected internal conditions.
Tie wire connects to cover in two ways. First, the wire holds the cage in position so the bars stay at their designed cover during the pour. A poorly tied cage shifts under the flow of concrete and the cover gets shallower or deeper than designed. Second, wire ends that protrude into the cover zone create a localised corrosion path from the surface, effectively reducing the cover thickness at that point.
Both failures are visible to building control. The inspector will check that the cage is rigid enough not to shift (they push it gently with a foot or hand) and that no wire tails point toward the trench wall. Both are direct consequences of the tying work.
Spacers do the actual cover work, holding the bars off the trench base or the DPM. The wire keeps the cage from shifting off the spacers. Both materials are working together. Get either one wrong and the inspection fails.
